ONTARIO POWER GENERATIONSTRABAG INC.

Chronology of Events 2005-2013

2005-2013

Last updated on February 01, 2012

VOICES from the Niagara Tunnel - A Living History

VOICES from the Niagara Tunnel - A Living History
(click link above for more information)

Niagara Tunnel Project
CHRONOLOGY OF EVENTS

August 18th 2005 -

Ontario Power Generation awarded a $600 million dollar contract to Strabag AG Company to design and build the new Niagara Tunnel.

Award of the Design/Build Agreement for construction of Ontario Power Generation’s (OPG’s) Niagara Tunnel Project was made after an intensive 8-month international procurement process. The 14.4-m diameter × 10.4-km long rock tunnel will divert 500 m3/s of water from the Niagara River to the Sir Adam Beck hydroelectric generating complex. The procurement process and Design/Build Agreement included features to address the owner’s requirements regarding risk allocation and cost and schedule certainty, while encouraging innovative ideas from the industry, both technically and commercially. The process included an international expression of interest and prequalification, followed by an invitation for design/build proposals to qualified proponents, and comprehensive proposal evaluations and negotiations with several respondent proponents. An honorarium was provided to the unsuccessful participants in the proposal stage. The resultant negotiated Design/Build Agreement includes Owner’s Mandatory Requirements, negotiated contract terms and conditions, performance incentive bonuses and liquidated damages for schedule and water delivery performance, a multistaged Geotechnical Baseline Report, joint risk management, references to pre-existing community impact agreements and measures to reduce impact on tourism. It also addresses regulatory approvals and permits, an owner controlled insurance policy that required reference to the International Tunnelling Insurance Group (ITIG) Code of Practice for Risk Management as a condition of coverage, site specific safety, security and environmental plans, formal team building, a dispute review board, and escrow documentation.

September 14th 2005 -

Ontario Power Generation announced the start  of construction of its $985 million dollar, 10.4 kilometer (6.46 mile) Niagara Tunnel project to increase the output of power from Niagara Falls. The Niagara Tunnel project is estimated to cost $600 million dollars and $385 million dollars for remedial and other work costs.

The project involves boring a tunnel 14.4 meters ( 47.24 feet) at a depth of up to 140 meters (459.3 feet) below the City of Niagara Falls . The tunnel will enhance the original engineering accomplishment of the Sir Adam Beck Hydro-Electric Generating Stations - Niagara Group in transporting water from a location up river from the Falls of Niagara to the power stations at Queenston to increase its power output.

The new tunnel will complement the upgrading of the 16 generators at the Sir Adam Beck Power Station #2. This 9 year upgrading project cost $220 million dollars increased the potential peak output by 194 megawatts.

When the new Niagara Tunnel project is completed, it will enable the Beck Power Group to produce an additional 1.6 terawatt-hours of electricity for at least the next ninety (90) years. It will allow enough energy production to serve an additional 160,000 homes and increase power output at Sir Adam Beck by 14%. - enough to meet the annual needs of a city of 700,000 persons.

Currently 1,800 cubic meters of water per second  (63,566 cubic feet of water per second) are available to be diverted to the Sir Adam Beck Generating Stations for power production. The new Niagara Tunnel will allow an additional 500 cubic meters of water per second (17,657.2 cubic feet of water per second) when available to be diverted for power generation.

On average, the Niagara Tunnel project will employ approximately 230 workers however this number will peak to about 350 employees.

The Tunnel Boring Machine (TBM) to be used on the Niagara Tunnel project will be 14.4 meters (47.2 feet) in diameter and will be one of the largest to be used in the world. In comparison the Robbins TBM will be 2˝ times the size of the Toronto Subway tunnel and 1˝ times the size of the English Channel tunnels.

The Robbins Company will design and manufacture the largest hard rock TBM in the world for the Niagara Tunnel project. It will be an open, hard rock, main beam TBM that utilizes the Robbins floating gripper design. The TBM will be equipped with a state of the art ground support system. The cutter-head will be powered with a 4,725 kW variable frequency drive system that can be increased to 5,040 kW. For optimum performance Strabag has chosen to use Robbins 20-inch cutters mounted in a back-loading cutter-head. Alternately, Robbins 19-inch cutters can be used without modification of the cutter-head. The cutting head will typically revolve at 4 to 10 revolutions per minute (rpm).

The geology is varied consisting of limestone, dolostone, sandstone, shale, and mudstone. The rock strength ranges from 15 to 180 MPa, with most of the rock in the 100 to 180 MPa range. With the exception of sandstone, the geology is basically non-abrasive. Most of the rock debris  (80%) removed from the tunnel will consist of Queenston Shale.

The Niagara Tunnel is expected to advance at a daily rate of 10-15 meters (32.8 feet - 49.2 feet).  Approximately 1.6 million cubic meters of material excavated from the tunnel will be dumped on Ontario Power Generation property between the two existing canals.

The new Niagara Tunnel will follow the same basic route as the existing two tunnels parallel to Stanley Avenue. The new tunnel starts on Ontario Power Generation property at Queenston with a  -7.82% drop over a length of approximately 1,500 meters (4,921 feet) reaching a depth of up to 140 meters (459.3 feet) below the City of Niagara Falls.  Here the tunnel proceeds with a relatively horizontal plane over a distance of approximately 7,400 meters  (24,277.9 feet). The alignment will follow a horizontal curve radius of over 1,000 meters (3,280.8 feet) in length. The tunnel ends on the Niagara River at the International Water Control Dam located one mile upriver from the Horseshoe Falls with an ascent gradient of +7.28% over the final 1,500 meters (4,921 feet).

The inside diameter of the finished tunnel will be 12.5 meters (41.1 feet) and will be lined with 50 centimeters (23.62 inches) of un-reinforced concrete with double layer seal and pre-stressed injection concrete.

The Tunnel Boring Machine will reach its maximum depth of 140 meters (459.3 feet) within the first 1.5 kilometers of operation. The TBM will operate 24 hours a day - 365 days a year on a 3 shift rotation (8 hours) until completed. The Tunnel Boring Machine will be operated by two Chief Operators per shift with a crew of approximately 10 workers onboard. An additional 20-30 men will be employed on each shift for the required surface support.

May 18th 2006 -

Province of Ontario, Minister of Energy - Donna Cansfield on tour of the construction site announced the nickname of the Tunnel Boring Machine as "BIG BECKY". A grade 6 class at Port Weller Elementary School came up with the winning entry to name the TBM. Under the direction of computer and science teacher - Kevin Dyck, his class selected the name after much "brainstorming". They called it BECKY because it is a feminine version that pays tribute to Sir Adam Beck.

August 8th 2006 -

A ceremony attended by Ontario Premier - Dalton McGuinty and other officials was held at the starting location of the Niagara Tunnel Project near the Sir Adam Beck Power Generating Stations. Premier McGuinty threw a switch to turn on the cutter head of the Tunnel Boring Machine (TBM).

Importing a European tradition, Doctor Robin Williams - Regional Municipality of Niagara - Medical Officer of Health was named  the patroness of the Niagara Tunnel Project by officials of Strabag AG. Naming a patroness is based upon a religious tradition of St. Barbara - the patron saint of miners, construction workers and engineers. Doctor Williams will keep up to date on the tunnelling project and will be a public ambassador for it. According to traditions associated with tunnelling, naming a patroness of the tunnel will keep the workers safe.

LEGEND OF ST. BARBARA

Barbara lived in the 3rd Century AD in Nicromedia, the capital of the Roman province of Bithnia (Asia Minor). She was the only child of Dioscuros, a high ranking and wealthy man. Her father adored her, had her tutored in the best schools of arts and sciences, and set out to reinforce her faith in the Roman- Greek Gods.

To protect her from foreign influences, he provided sumptuous living quarters for her in a tower. But her very loneliness caused Barbara to think seriously; as a result, she became more and more convinced that the old gods were but a hollow imitation.

Without her father’s knowledge, she became familiar with the teachings of Christ, and had herself baptized. At that time, Christians were being persecuted nearly everywhere, and considered as enemies of the state. Adherence to Christianity was subject to the severest punishment.

Dioscuros planned to marry Barbara to a very prosperous man, with a view to increasing the family fortunes. At first Barbara asked for time to reflect. Following his return from a long journey, Barbara explained to her father that she was a Christian and did not wish to marry. She had already removed the different images of Pagan gods from her living room quarters and had replaced them with crucifixes.

Dioscuros, seeing that his only child had turned to the new religion and that he himself had been placed at a disadvantage, was overcome with rage. He handed over his daughter, as a Christian, to the Roman pro-consul Martianus, a Supreme Court judge, for the assessment of punishment.

Martianus tried at first by kind persuasion, to make her break with her faith; but when this failed, he had her thrashed and cast into jail. Due to the strength of her faith, her wounds healed immediately. On the following day, she was ordered by Martianus to pay sacrifice to the pagan gods. When she refused, she was mutilated in a dreadful way. When she continued to proclaim her Christian faith, she was sentenced to die by the sword. Barbara went to her place of execution in cheerful ecstasy: with her enthusiasm for her true faith. Her last wish was that God through her experience help all those confronted with and unprepared for a sudden untimely death.

The Barbarous father was so outraged that he himself severed his daughter’s head! Immediately following Barbara’s death, a terrible thunderstorm arose. As punishment for his monstrous crime, Dioscuros was killed by lightning. This is the story of Santa Barbara in its oldest form.

Later when Christianity had become firmly established, St. Barbara was invoked as a protectress against the perils of lightning. Barbara Day was used as a holiday in the very earliest festival calendar of the city of Cologne. The belief became widespread that Barbara could control lightning and other manifestations of flame and fire. Barbara was adopted as the patron saint of miners most probably because the mining profession had to cope with many hazards to life in those days. Also, the miners formed a large part of those for whom she prayed in the hours of her own death.

Miners later developed the use of gunpowder for disintegrating rock, involving manifestations similar to thunder claps and lightning flashes. This led to their need for special protection against accidents from the use of explosives, thereby strengthening the reputation of Saint Barbara as their adopted patron saint.

 Saint Barbara was also a protectress of the plague which further strengthened her veneration, mothers would pray for healthy children and miners would mirror that by praying for plentiful blessings in their mining operations: both seeking a bountiful production and an enhanced degree of well being.

There are many churches, mines and works of art named after or produced in remembrance of Saint Barbara. A few examples of note:

Barbara Cathedral in Kuttenberg (Bohemia) built between 1388 and 1518 in the old silver city. This was thought to be the most likely source of the Barbara adoration. The cathedral was built around an already existing Barbara altar in an area with many Barbara altars present. Kuttenberg has for centuries had on its coat of arms St. Barbara above the crossed hammer and gad. [Schlaegel und Eisen-the classical symbol of mining]

Mine names frequently indicated wishes and hopes, in both Freiberg and Marienberg there was a mine named "St. Barbara Bonanza". There is also the "St. Barbara Good Hope Vein" in the Harz Mountains on the German-Austrian border.

August 2006 -

The Regional Municipality of Niagara and Ontario Power Generation drafted an agreement that will see approximately 3.5 million tonnes of Queenston Shale excavated provided to the brick manufacturing industry for free. Queenston Shale is the sole raw material used for the production of clay bricks in Ontario.

August 2007 -

The tunnel boring machine (TBM) is nearing the 1,000 meter (3,281 feet) mark. Progress has been extremely slow because of frequent vertical rock falls as a result of unforeseen geological rock structures. It is hoped that the unstable rock sections will soon be behind them as the TBM bores deeper underground . Several rock falls weighing an estimated 10-20 tons have stopped the boring progress for lengthy periods. The maximum depth of 140 meters (459.3 feet) will soon be reached as the TBM reaches the 1,500 meters mark. In order to reduce the frequency of rock falls, horizontal support rods are being installed in the rock above the TBM in advance of the cutter head.

In order to reduce airborne dust pollution at the debris dump site, a containment building has been erected.

September 22nd 2007-

 The tunnel boring machine (TBM) has reached a milestone of the first 1000 meters (3,281 feet).

January 21st 2008 -

The tunnel boring machine (TBM) is approximately 1,650 meters (5,413 feet) and is located at it's maximum depth. It's current location is under the ancient buried St. David's Gorge. Because of very difficult, unpredictable and unstable rock conditions, the TBM has been progressing at forward rate of several meters per day. This unfortunate delay in progress has setback the targeted completion date of this project from 2009 to 2010.

Five - 130 meter deep dewatering shafts from the surface to the tunnel are being drilled near the Whirlpool Road site approximately 1500 meters from the tunnel outlet. Each of these shafts will allow the tunnel to be dewatered using massive mobile water pumps if ever required. Each shaft is approximately 900 millimeters in outside diameter with the inside diameter of 700 millimeters.

March 1st 2008 -

The tunnel boring machine (TBM) is 1800 meters (5,905 feet)  with continuous roof-line over break.

March 5th 2008 -

Strabag has announced further delays in the Niagara Tunnel Project. The Tunnel Boring machine (TBM) has been making very slow progress under very unstable rock conditions. Big Becky might have to chart a new course and revise her schedule to make up for time lost while digging through difficult rock conditions. Progress on the Niagara Tunnel Project continues to be slower than both Ontario Power Generation and Strabag AG, the Austrian company hired to build the 10.4-kilometre tunnel, expected, officials with both companies say.

"You're dealing with nature. You can't predict the rock condition for 10 kilometers," said Ernst Gschnitzer, Strabag's project manager, who oversees the construction of a third hydro tunnel under the city of Niagara Falls.

What excavators call "over- break" continues to be the problem, the same situation that slowed progress last year. Once Big Becky, the nickname for the $35-million tunnel-boring machine, cuts a portion of the tunnel, loose rock from the ceiling falls in behind the machine. The cavities will be filled in to make a smooth surface before the tunnel is finished, he said. But for now, removing the rock and digging through "unstable" material is hindering progress.

To compensate for the delays, Strabag wants to alter the alignment of the tunnel, both vertically and horizontally. On the south side of the St. David's Gorge, the tunnel will go higher than first planned. That will allow the excavation to get out of the difficult conditions and into more predictable rock, said Gschnitzer.

According to the Niagara Peninsula Conservation Authority, the buried St. David's Gorge is an abandoned channel that has been filled in with a glacial debris including gravels, sands, tills, silts and clays. The ancient gorge is thought to have been 116 meters (380 feet) wide and up to 79.25 meters (260 feet) deep. It has  been estimated at approximately 22,000 years old.

A portion of the tunnel will also be shifted a bit to the east - or toward the Niagara River - from its original alignment, which ran approximately underneath Stanley Avenue.  Strabag has applied for necessary approvals to make that change. The company expects to hear a decision in a few months, Gschnitzer said. The August 2010 target for completion also needs to be adjusted.

"We hope it won't change that much. It will go into 2011," said Gschnitzer. Last fall, Ontario Power Generation's board approved August 2010 as the completion date for the tunnel. When work began in September 2006, Strabag expected it could complete the work by fall 2009.  OPG says Ontario taxpayers are protected from cost overruns because it gave Strabag a design-build contract meaning the company agreed to build the tunnel for a fixed price, said OPG spokesman John Earl. The tunnel work is pegged at $600 million.

At the beginning of March 2008, the TBM had excavated 1,800 meters of the 10.4-kilometre tunnel.

By December 31st 2007, the TBM had excavated 1,609 meters of the tunnel.

By September 2007, the TBM had excavated 1,350 meters of the tunnel, less than half the distance Strabag had hoped for at that point.  Once the TBM excavation reaches 2,300 meters (2.3 kilometers), Strabag will be in a position to reassess how to make up for lost time in the remaining 8.1 kilometers of the tunnel.

May 10th 2008 -

The TBM - Big Becky has reached the 2,000 meter mark.

May 24th 2008 -

The TBM - Big Becky has passed the 2 kilometer point in the Niagara Tunnel Project, but is so far behind that Ontario Power Generation (OPG) and Strabag AG are reviewing the cost of the $630-million project and its schedule.

"The Niagara tunnel is progressing slower than planned. The drilling conditions have been challenging," president and chief executive officer Jim Hankinson said Friday. OPG is officially sticking to its August 2010 completion target, which had already been revised once from 2009.

But Ernst Gschnitzer, project manager for Strabag, the Austrian company contracted to design and build the tunnel, predicted it won't be completed until much later.

"It's going to be 2012. We don't see any possibility to be quicker, at present," Gschnitzer said.

After 2 kilometers, the TBM is one-fifth of the way into the 10.4-kilometre tunnel that will connect the Sir Adam Beck generating stations to the upper Niagara River, south of Dufferin Islands.

At the end of March, OPG's first fiscal quarter, the tunnel boring machine had advanced about 1,848 meters. That's 239 meters further than where it was at the end of 2007, based on OPG figures.

For the first three months of 2008, Big Becky was digging an average of 2.6 meters a day - considerably slower than what had been hoped could be an average rate of 15 meters a day.

As part of the review, three independent experts are examining how the project has gone since work began. They're looking for mistakes that might have been made and ways to improve progress, an OPG official said.  Those experts are expected to consult with both OPG and Strabag in June. OPG expects to have a better understanding of how the cost and schedule will be affected by July.

"We will provide further details about changes in the schedule and the cost when they are available," Hankinson said in a conference call to discuss the Crown corporation's first quarter results for 2008.

Tunnel construction has been slowed by the loose rock conditions under the St. David's Gorge - the area near the whirlpool - that have dogged the project almost since it started. As Big Becky - the nickname for the tunnel-boring machine - advances, loose rock from the tunnel ceiling falls in behind it.  That "over-break" rock has to be removed. The cavities in the rock will be filled in when the tunnel's concrete lining is poured.

"Once we get beyond the St. David's Gorge, we do expect better performance," Hankinson said.

The tunnel-boring machine was 2,077 meters into the tunnel as of Friday, Gschnitzer said. His company expected to be "much further" along than it is now, after 20 months.  "I can't even tell you - several more kilometers," he said.  Removing the "huge amount of over-break material" is the ongoing challenge, he added.

It's impossible to know for certain what rock conditions exist before construction starts, Gschnitzer said. OPG could have spent more than $100 million on a more extensive rock study, he added, but "you would never be able to anticipate these rock conditions 100 per cent."  Strabag has bought more equipment to remove that rock material faster. That reduces the time the tunnel-boring machine loses, Gschnitzer said.

"We have worked on a consistent basis to make improvements. The rock conditions aren't changed," he said.

OPG agrees the pace has picked up.  "In the last couple weeks, our progress has been much better - more like six or seven meters a day," Hankinson said.  OPG's report predicts "considerable uncertainty" about the schedule and cost until Big Becky reaches the 2,300-metre mark, the point when the loose rock is expected to turn to harder rock, reducing the over-break concerns.  Ontario Power Generation plans to review the entire $985-million estimate of the Niagara Tunnel Project. That estimate includes some work OPG is doing not directly related to the tunnel, including the refurbishing of the Toronto Power station on the Niagara Parkway.

On May 29th 2008, the TBM had progressed to 2,114 meter. Now slightly south of the St. David's buried gorge, the TBM was averaging up to 7 meters per day but still experiencing heavy over-break (rock fall from the roof of tunnel).

May 29th 2008 -

The tunnel boring machine (TBM) is 2114 meters (9,936 feet)  with continuous roof-line over break.

July 11th 2008 -

Big Becky is behind schedule and potentially over-budget, but the Niagara Tunnel Project is so "integral" to Ontario's electricity supply the government is prepared to pass cost overruns onto provincial electricity customers, Premier Dalton McGuinty says. If there are additional costs that fall to us, that is regrettable. But these things happen from time to time in large-scale construction projects," McGuinty said in an interview Thursday, following a funding announcement at Niagara College. Despite lingering questions about the cost and timetable, McGuinty remained bullish.

"We're absolutely committed to finishing this project. We need that clean electricity," McGuinty said. "We're not going to build another coal plant."

Ontario Power Generation, the publicly-owned electricity producer, and Austrian contractor Strabag AG are now trying to sort out who will pay for expenses if the tunnel work goes above its $600-million budget.

Loose rock conditions have plagued construction of a third tunnel that will divert water from the upper Niagara River to the Sir Adam Beck generating stations since work began nearly two years ago.

It was a problem for the first 2,300 meters of the tunnel, the portion between the Beck generating stations and the St. David's Gorge. As the tunnel-boring machine nicknamed Big Becky inches along, overhead rock falls in from the tunnel roof and needs to be removed.

OPG and Strabag AG met for two days last month with their "dispute review panel," a three-member board created before the project began. The expert panel is expected to make recommendations in September about how to assess additional costs incurred because of the rock conditions.

"In general, it's about the different rock conditions and who is going to be responsible for these rock conditions," said Strabag's project manager Ernst Gschnitzer.

Strabag says the rock is not what the company expected based on geological information OPG provided before the company bid on the contract.

"The rock is different than anticipated," Gschnitzer said. OPG says the contract holds Strabag responsible for overruns. Strabag was given a design-build contract, meaning they agreed to do it for a fixed price of $600 million.

"The contract has been done in a way that as much of the risk has been transferred to the contractor as can be done," OPG's chief operating officer Pierre Charlebois said in an interview. Before asking for bidders, OPG bored test holes in the rock to give them an idea of the type of rock they would be excavating.

"Bore holes tell you one thing," Charlebois said, but doing the actually digging with a 14-metre diameter boring machine is another.

It could mean an increase in electricity rates if Ontario Power Generation is deemed to be responsible for some of the overruns and if they use up the undisclosed contingency fund the provincially-owned generation company included as part of the Niagara Tunnel Project. Under the contract, OPG pays Strabag for progress, meaning payments are made as the tunnel moves forward. Charlebois emphasized it's "premature" now to say whether the project will go over-budget. But if it does happen, OPG will recover its costs through the rates the company charges for power. The rate-recovery process allows OPG to spread those costs over a 100-year period, Charlebois said.

While OPG and Strabag await the dispute panel's recommendations, work continues. Both companies say progress has improved now that excavation is past the St. David's Gorge. The tunnel boring machine (TBM) is 2,475 meters into the 10.4 kilometer tunnel. The pace has picked up to an average of eight meters a day from the 2.6 meter average in the first quarter of 2008. But it is still below the 12 meters a day goal set when work began.

July 18th 2008 -

The TBM had tunnelled 2,528 meters and was progressing at a rate of 8 - 9 meters daily. The over-break (rock falling from the ceiling) was continuous

August 22nd 2008 -

The tunnel boring machine named "Big Becky" is taking a short cut. Two years after construction of the Niagara Tunnel Project began, Ontario Power Generation confirmed both the horizontal and vertical alignments will be changed to cut costs and make up for lost construction time.

"The horizontal realignment has been adopted which will reduce the total length by 200 or 300 meters," Pierre Charlebois, Ontario Power Generation's chief operating officer, said Friday.

Ontario Power Generation is building a 10.4-kilometre tunnel under the city of Niagara Falls to bring more water from the upper Niagara River to the Sir Adam Beck generating stations in the city's north end. But the Niagara Tunnel Project has been plagued with delays caused by the loose rock in the St. David's Gorge area. As the tunnel-boring machine, nicknamed Big Becky, moves along, overhead rock falls in and has to be removed. It has created what OPG regularly calls "considerable uncertainty" about the $600-million budget and schedule. Plans originally called for it to be completed in 2010, but the contractor has suggested 2011 is more realistic. A realignment was suggested by Strabag AG, the Austrian company hired by OPG to build the tunnel. Original plans called for the tunnel to run north-south, a bit west of Stanley Avenue.

"We have decided to change the horizontal alignment. "We will enter into a curve a little bit sooner," said Ernst Gschnitzer, Strabag's project manager. The new alignment will put the tunnel "more or less under Stanley Avenue," he said. "There is a slight cost advantage. There is an advantage in flow capacity. The tunnel can deliver slightly more water, once it's in service."

Recent excavation has occurred at about seven meters a day. At that rate, a 200-metre short-cut would save about 28 construction days. Strabag also plans to change the vertical alignment of the tunnel - the point at which the tunnel will begin rising toward the surface from its lowest point. Tunneling is taking place 140 meters (459 feet) below the surface to get underneath the St. David's Gorge. The vertical re-alignment has been approved, but not formalized, Gschnitzer said.

Both OPG and Strabag say they believe the pace will quicken now Big Becky has advanced past the troublesome rock conditions of the buried gorge.

It was at the 2,812-metre mark as of Friday (August 22nd), Gschnitzer said.  That's a little more than one-quarter of the length of the entire tunnel.  Ontario Power Generation and Strabag have discussed how to improve the pace.  OPG and Strabag are working through a dispute-resolution process to determine which company will be responsible for additional costs resulting from the delay.

Strabag has said the rock conditions aren't what the company expected based on a geological report prepared by OPG. A three-member panel held a hearing June 23 and is expected to make a recommendation by the end of September.  "The schedule delay and the issues currently being considered by the dispute review board could impact the project cost," OPG's report states.

August 27th 2008 -

The tunnel boring machine (TBM) is 2862 meters (9,390 feet) into the 10.4 kilometer tunnel with continuous roof-line over break of 1.5 meters. Progress is averaging 8 meters per day.

October 2nd 2008 -

The tunnel boring machine (TBM) is 3,131 meters (10,5073 feet) into the 10.4 kilometer tunnel with continuous roof-line over break of 1.5 to 2.5 meters. Progress is averaging 8 meters per day.

October 20th 2008 -

As a result of an agreement between Strabag and OPG, the tunnel boring machine has begun altering it's course from the original planned path. The new alignment will basically follow a north-south route under the existing Stanley Avenue. The former path followed an alignment underneath the existing twin tunnels west of Stanley Avenue. This former alignment required the TBM to maintain a greater depth to create a safe buffer from the tunnels above.

The Queenston shale continues to be a great source of over-break causing lengthy delays. As the cutting head bores into the rock face, a large amount of unsupported roof shale is collapsing onto the TBM. This causes the stopping of the TBM until the fallen rock debris is removed and the roof stabilized. With the St. David's buried gorge behind them, the rock conditions were hopefully expected to improve: have not. Strabag and OPG have agreed to change the trajectory of the TBM in an upward movement until the TBM reaches a more stable rock strata of Whirlpool Sandstone. Final approval of the change in trajectory of the TBM by OPG is further slowing progress.

The tunnelling is stopped for a six week maintenance period. The tunnel is 3,200 meters in length.

December 2008 -

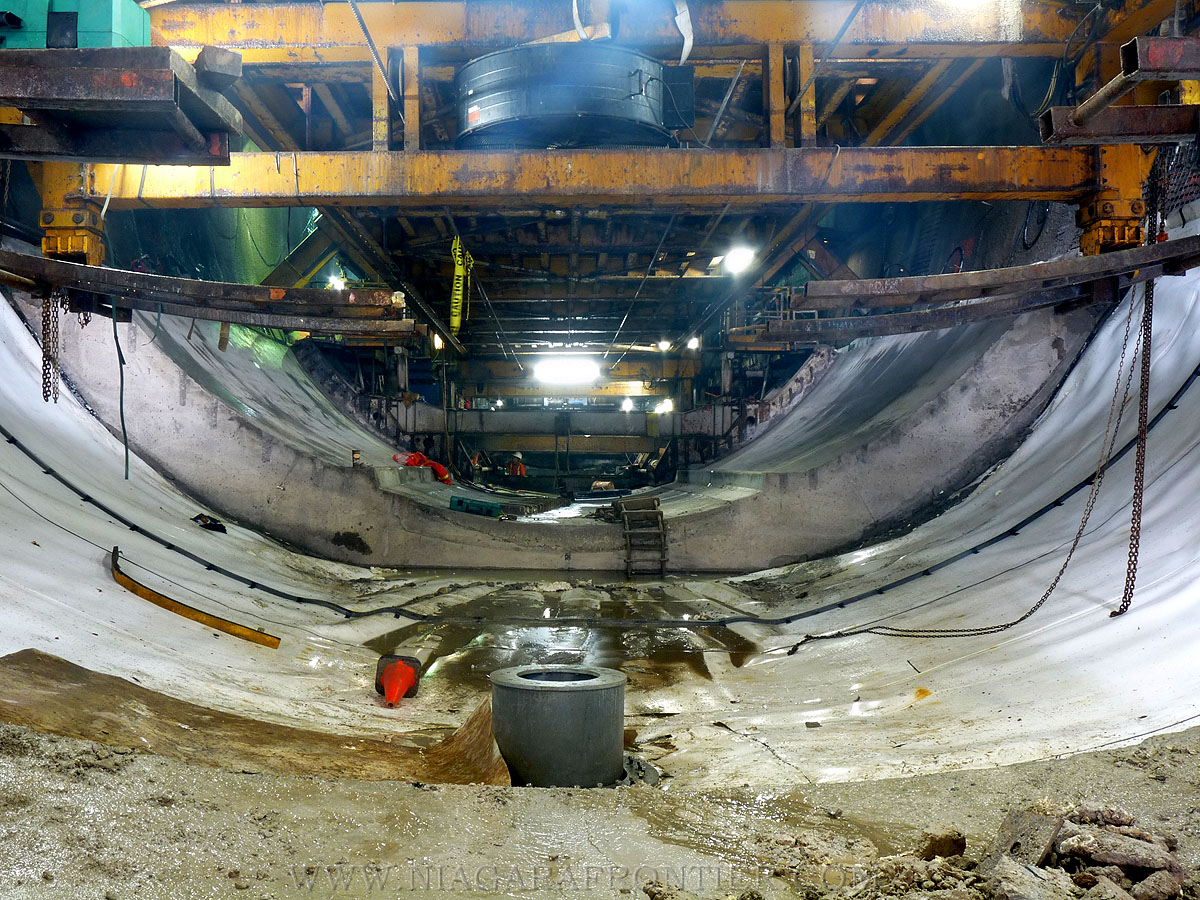

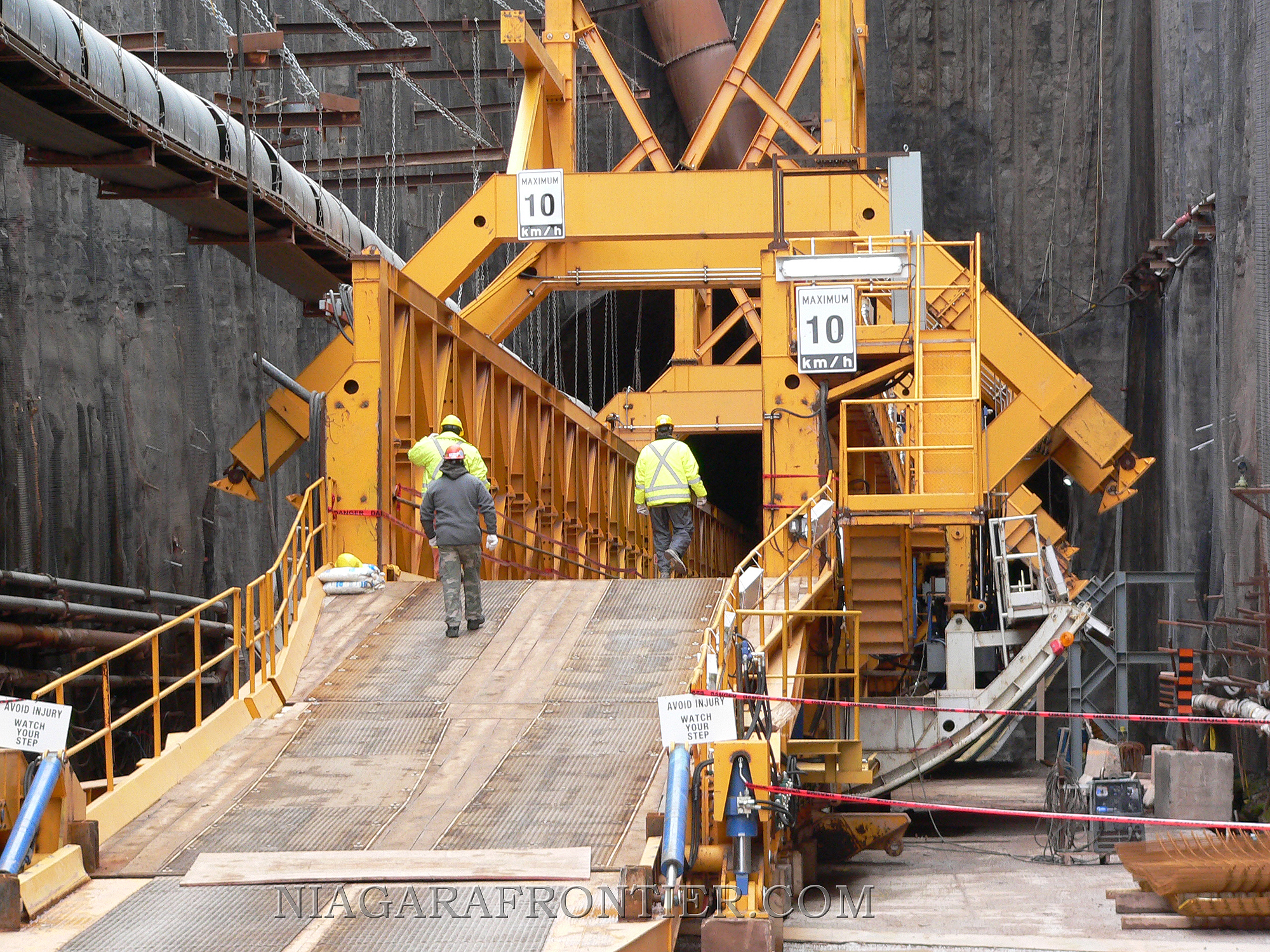

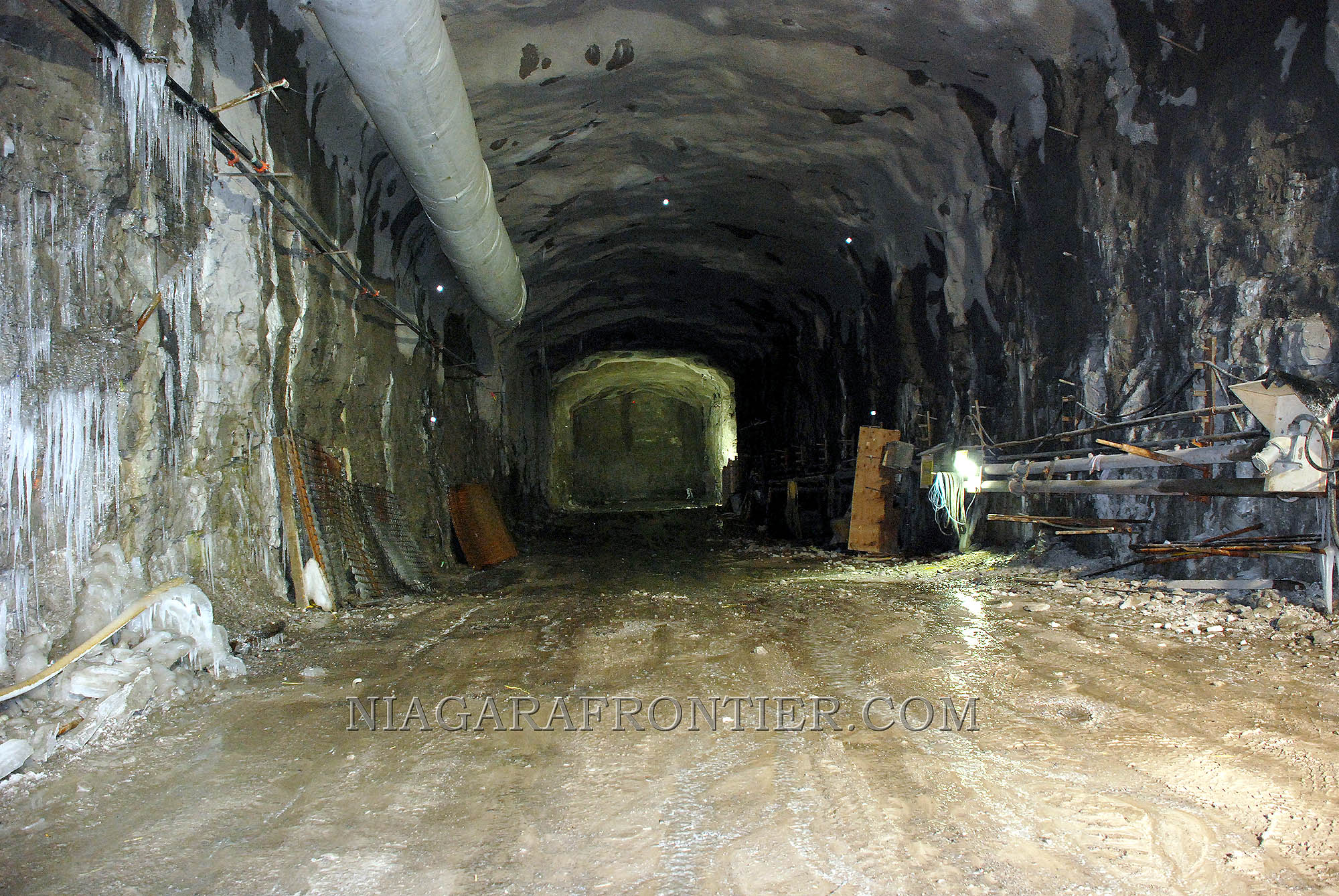

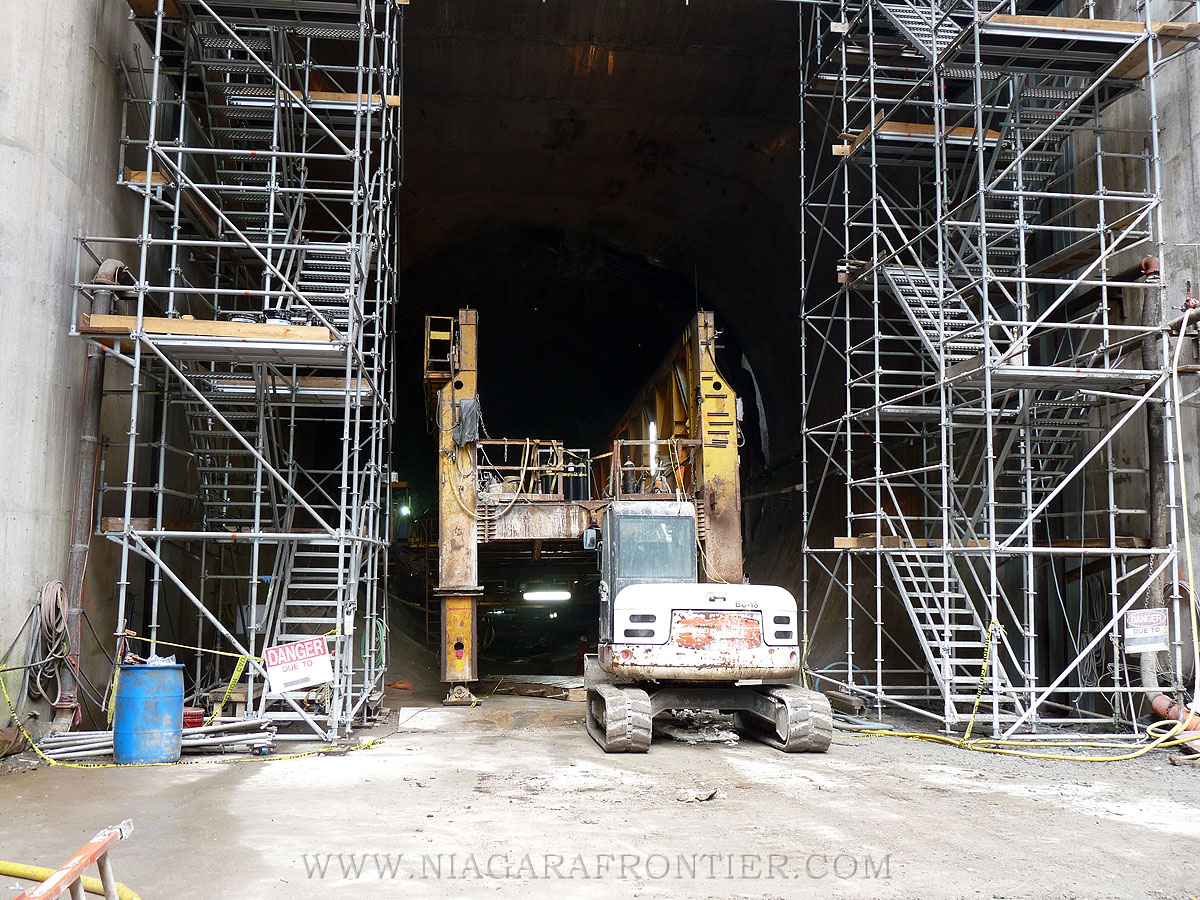

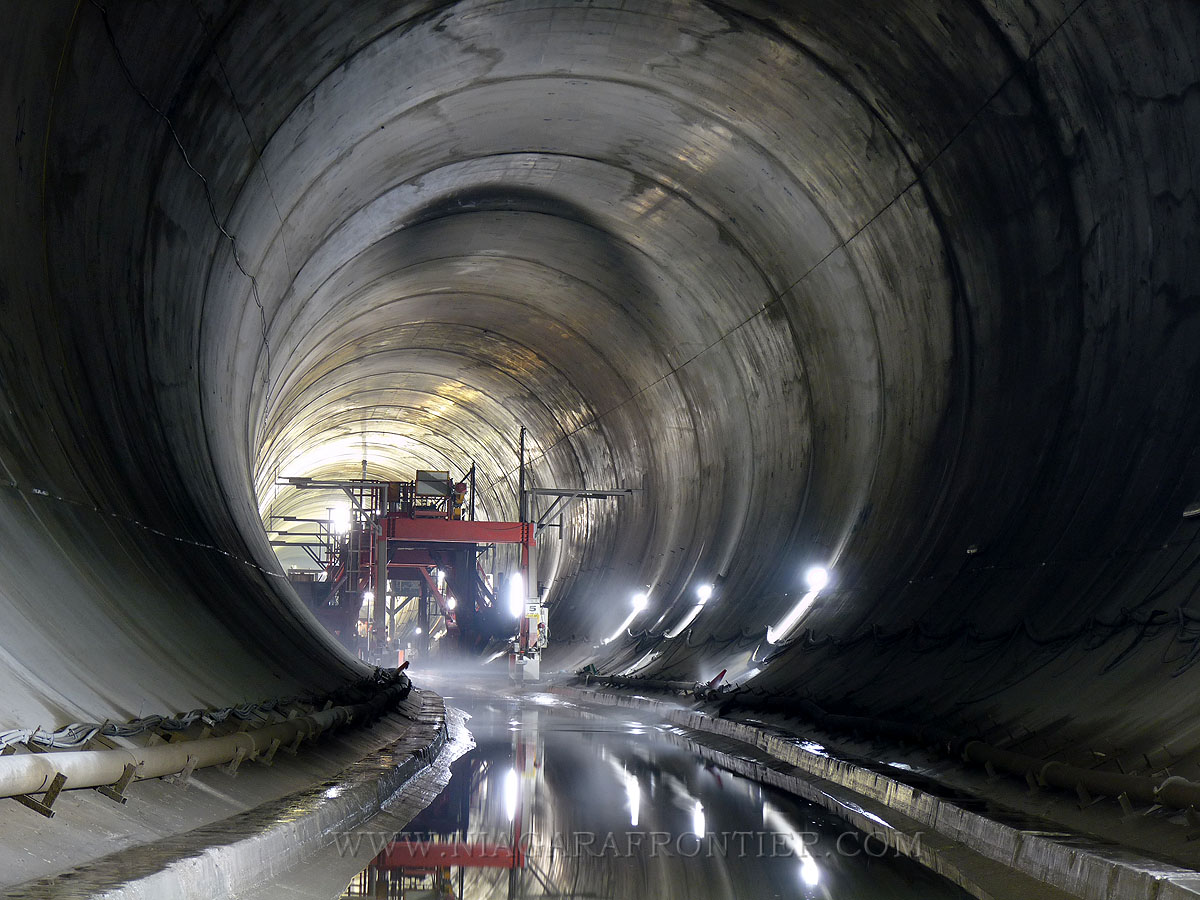

The Invert Concrete Formwork Bridge has been walked into position. The first two bays have been lined with the waterproofing membrane and the first concrete pour is scheduled for Friday December 12th 2008.

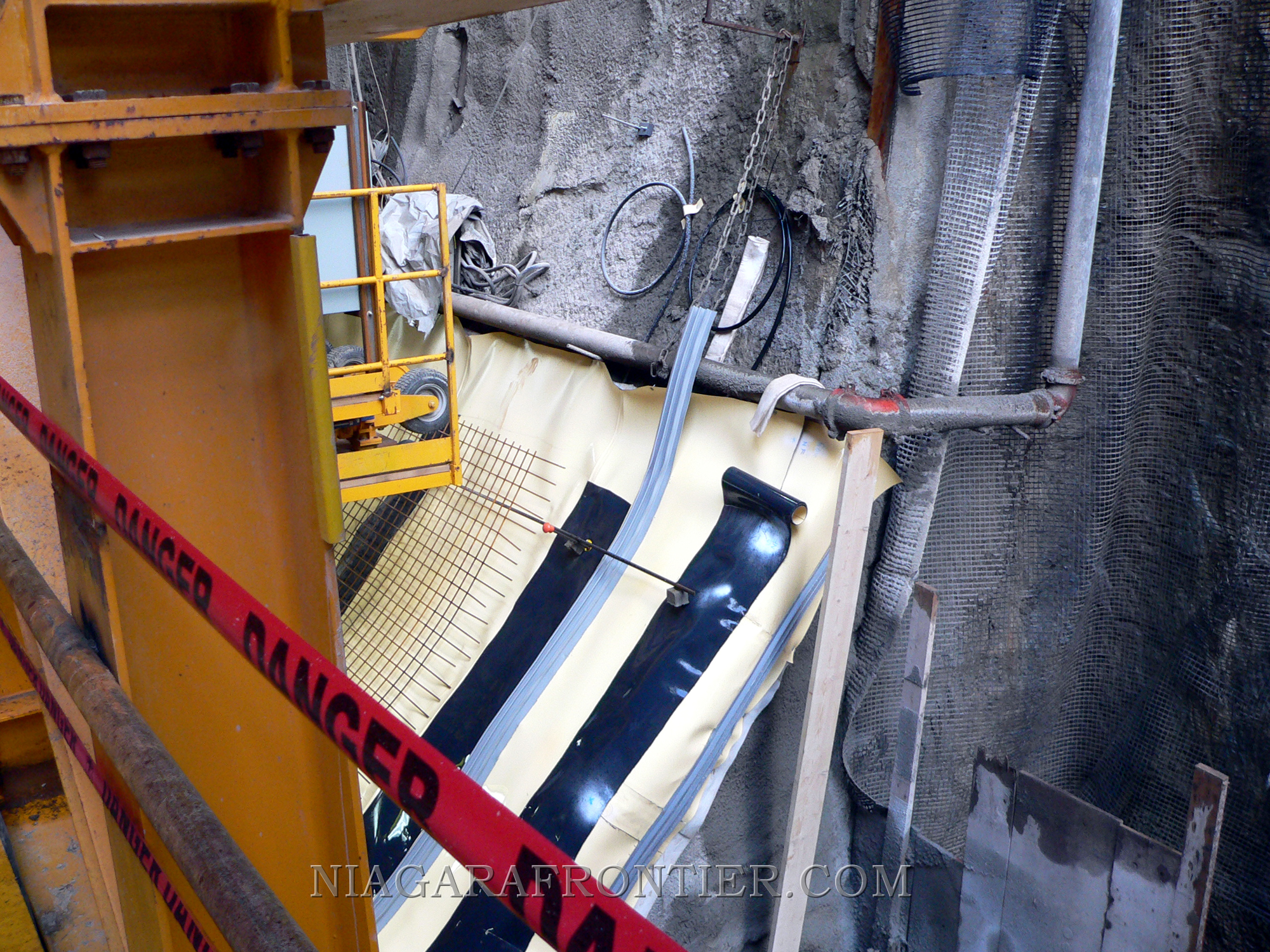

Applying the inner tunnel membranesInvert Concrete Formwork Bridge
The Invert Concrete Formwork Bridge (right) is used
to apply inner tunnel membranes  (left) before concrete is applied

December 4th 2008 -

The annual St. Barbara Day celebration is held. No significant injuries have been reported during the past two years of tunnelling.

December 10th 2008 -

The TBM is at 3,222.76 meters (10,573 feet) with a continuous over-break of up to 3.7 meters (12.14 feet).

December 30th 2008 -

The TBM is at 3,296.6 meters (10,815 feet) with a continuous over-break of up to 3.7 meters (12.14 feet). The TBM is gently ascending at a rate of 0.100% (rising one meter for every one kilometer). Rock over-break continues to prevent efficient tunnelling progress.

Currently, the TBM is pushing (moving) forward at a rate of  0.8 meters (80 centimeters) because of the heavy over-break rather than a usual push of up to 1.5 meters (150 centimeters). Although the TBM is capable of pushes of 4 meters (400 centimeters) or more, it is restricted in order to allow the mining crews the time to safely reinforce the roof line to prevent over-breaks and to prevent the rock conveyor from becoming overloaded. Debris removal from the roof line over-break causes much of the delay being experienced. The cutting head of the TBM is 6 meters (19.6 feet) thick

After each push (movement) forward the TBM is halted to allow mining crews to clear the rock debris from the roof line over-break, apply reinforcement rebar and steel joists which are bolted into the ceiling. Ten holes are drilled into the support joist at regular (80 centimeter) intervals and 4 meter long expansion rock bolts are inserted into each hole and pressurized causing the bolts to expand in diameter to secure the roof line. Each bolt is rated at 25 tonnes. The final process involves spraying Shot Crete (concrete spray) over this entire ceiling area. This process is repeated with each measured "push" of the TBM.

When the TBM reaches 3,304 meters (10,840 feet), it will begin to ascend at a 7.15% gradient (rising 7.15 meters every 100 meters) in an effort to escape from the Queenston Shale strata to more predictable and stable rock formation (Whirlpool Sandstone). The TBM will level out after rising to a depth of 90 meters (295 feet) from the surface. It is hoped that this manoeuvre will allow much less roof line over-break currently experienced.  At this depth the TBM will be at the same level of the existing twin tunnels built under the city in the 1950's.

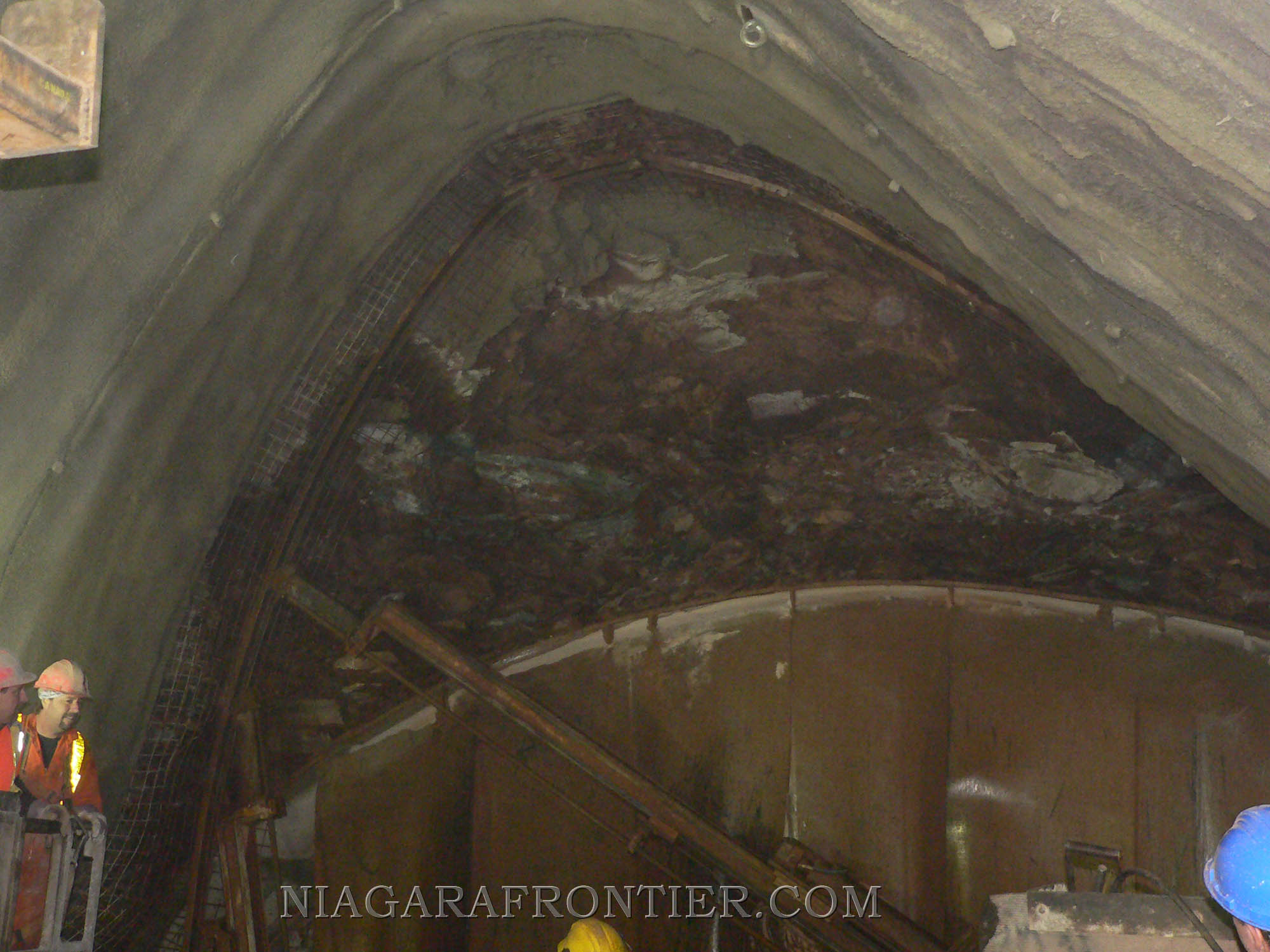

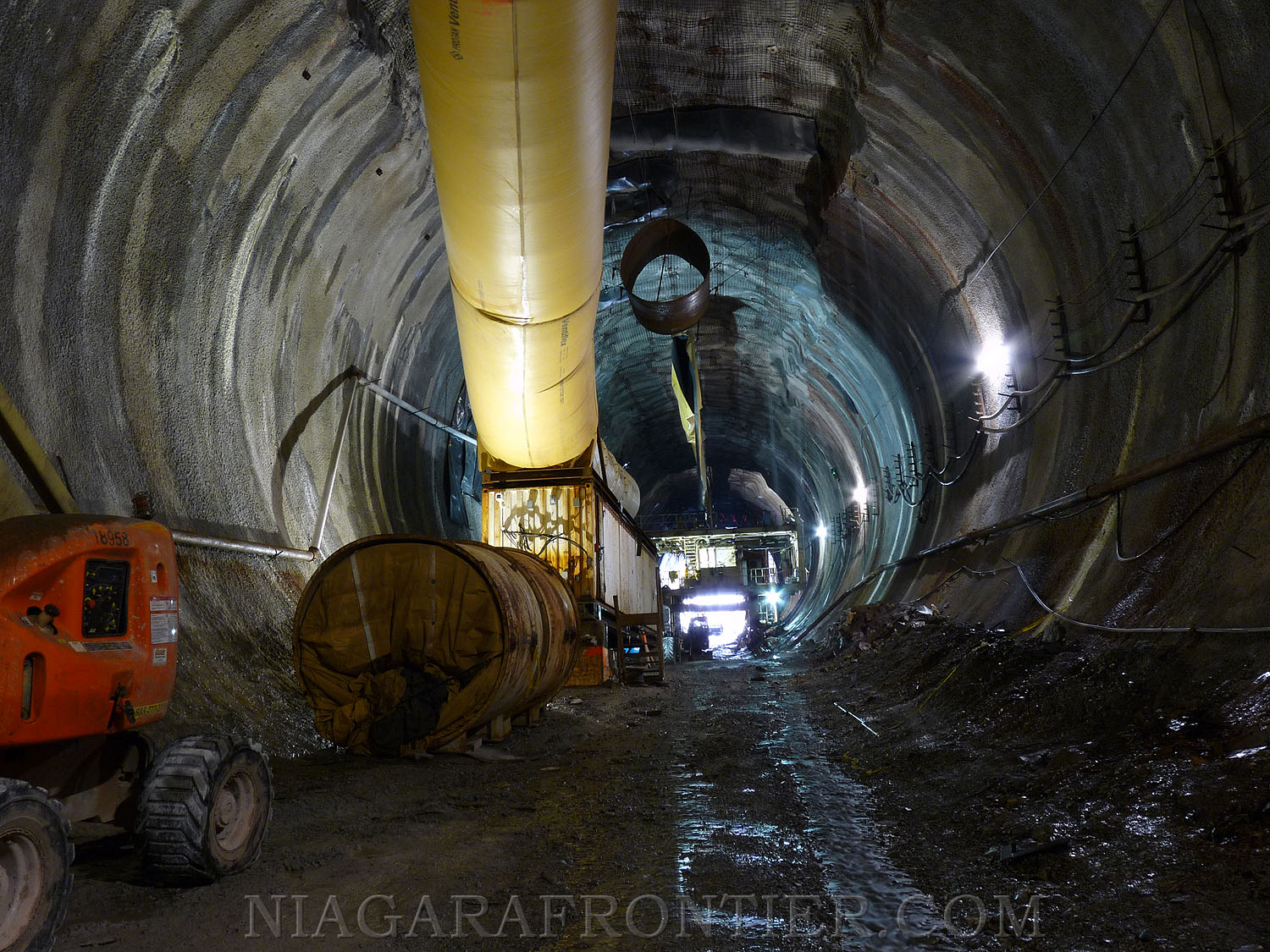

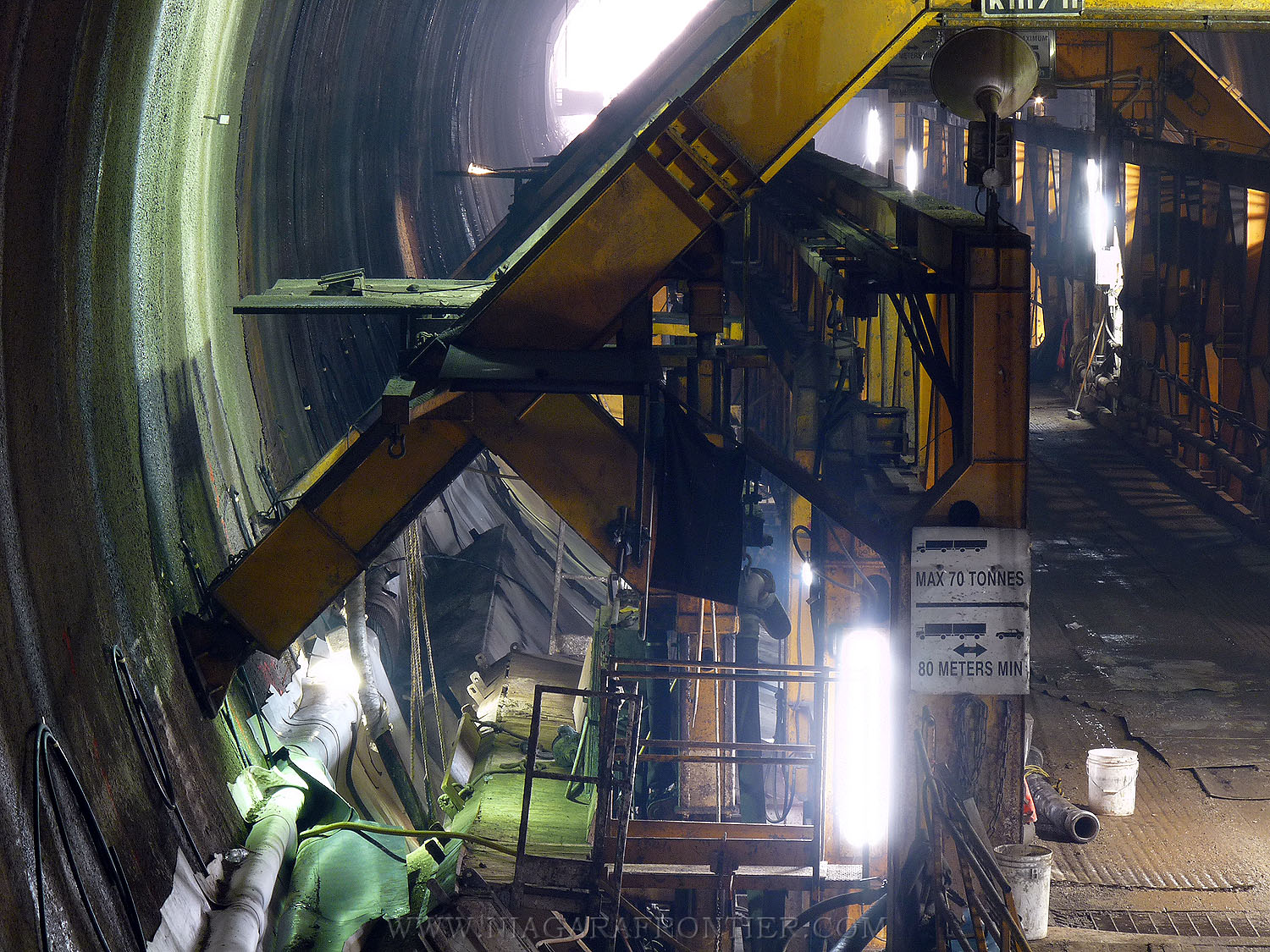

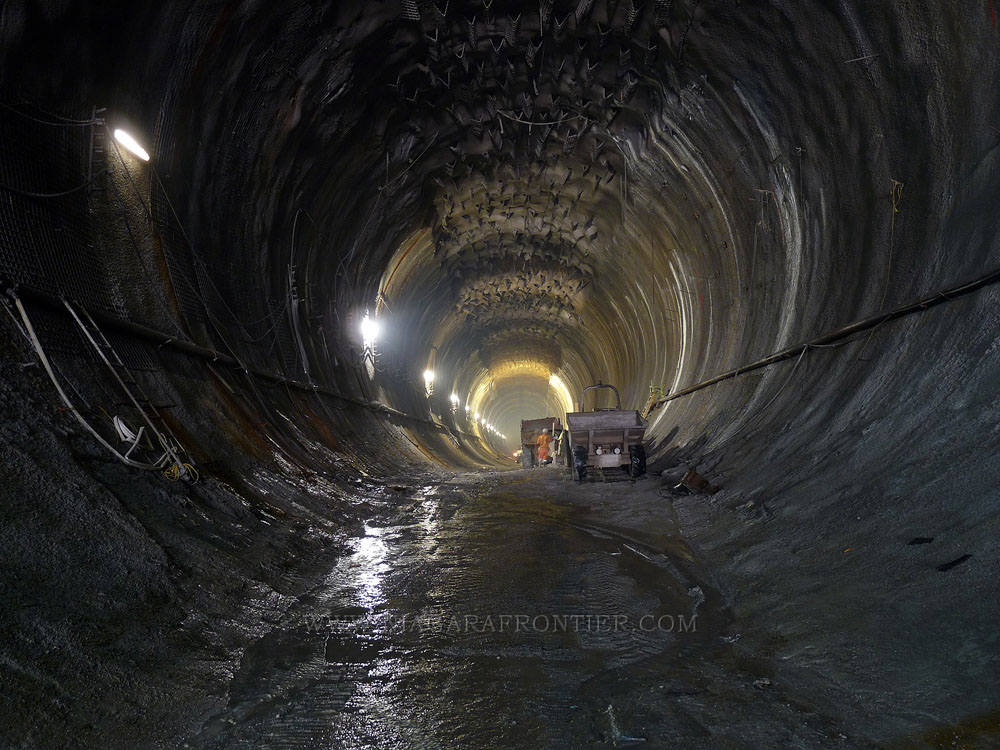

Working above the crown of the TBMWorking on the TBMWorking on the TBMWorking on the TBM

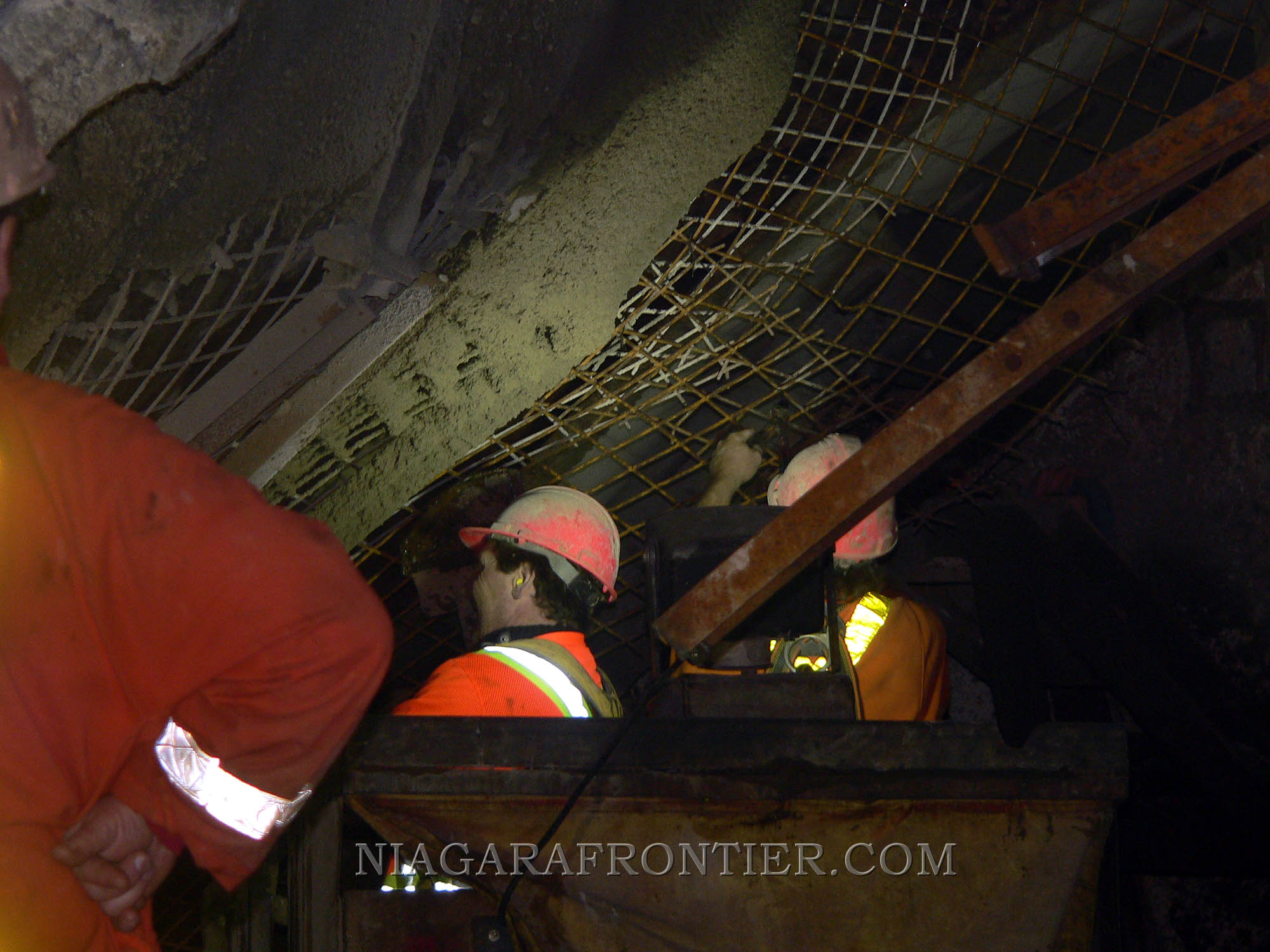

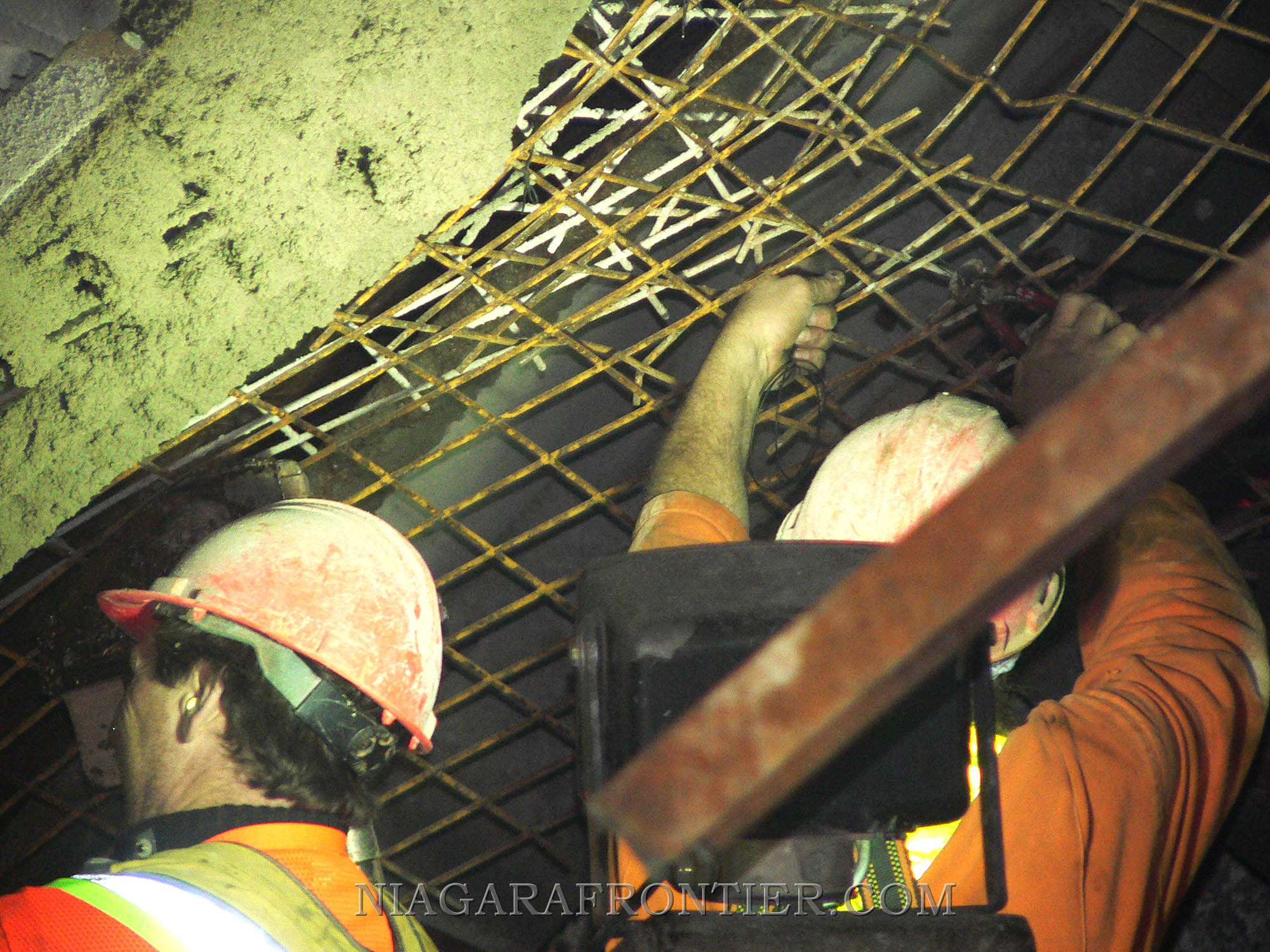

Miners working above the crown of the TBM cutter head

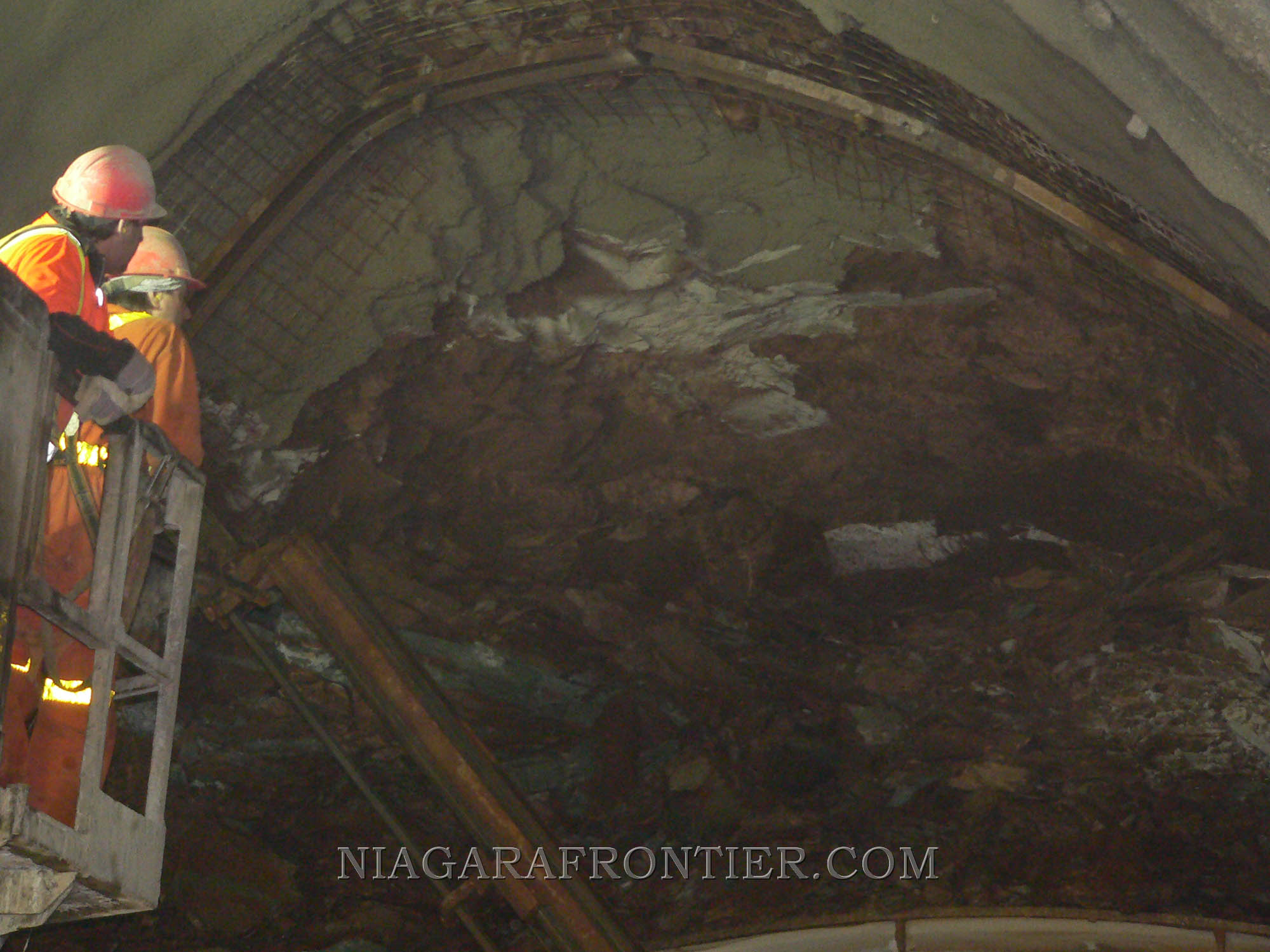

January 23rd 2009 -

The TBM is at 3,417.02 meters (11,210.5 feet) with a continuous roof line over-break of up to 4 meters (13 feet).   The overland conveyor belt from the tunnel to the rock dump broke down on the evening of January 22nd causing a temporary shutdown of mining operations until 600 meters of continuous loop conveyor belt is replaced.

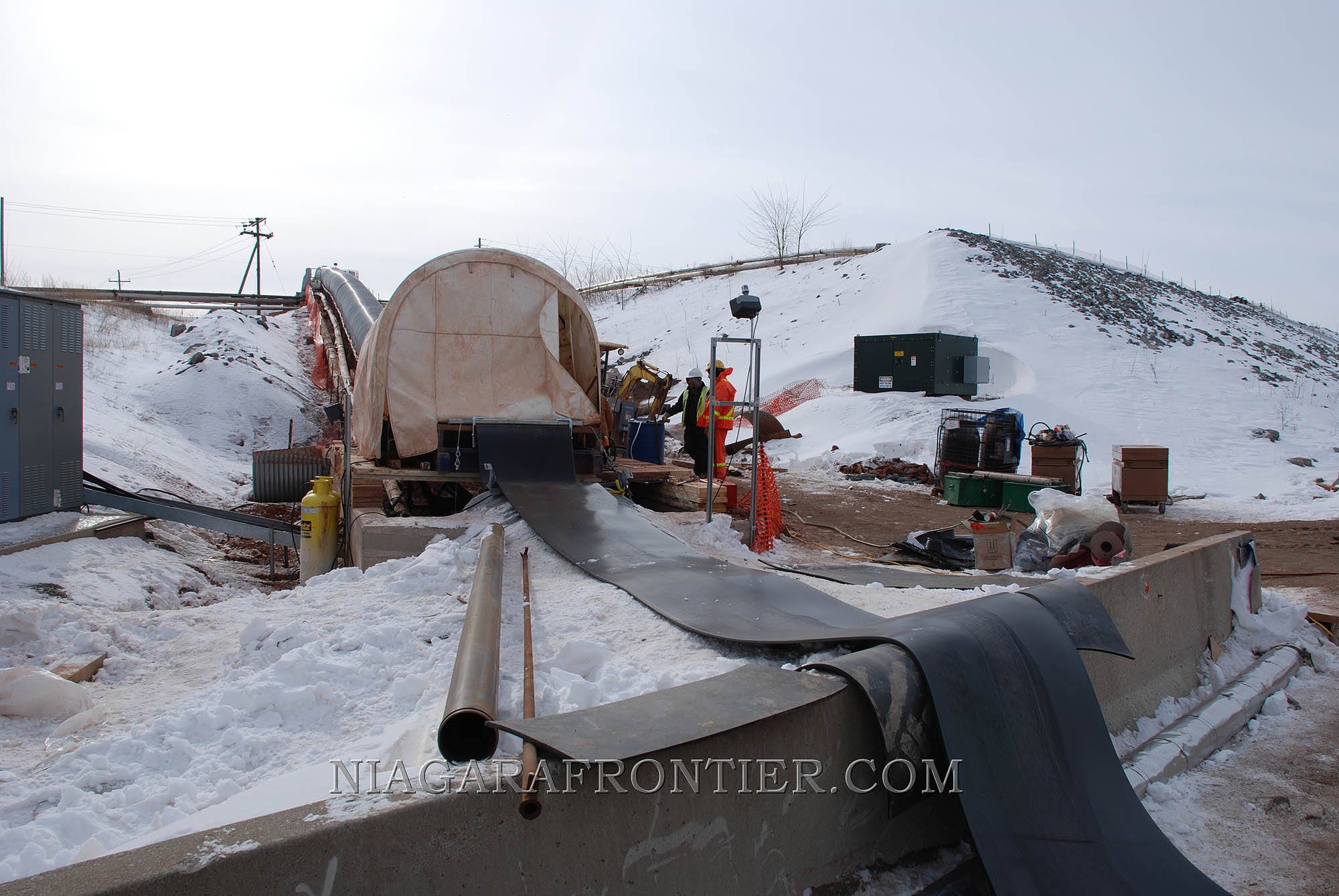

Replacing the overland conveyor beltReplacing the overland conveyor belt

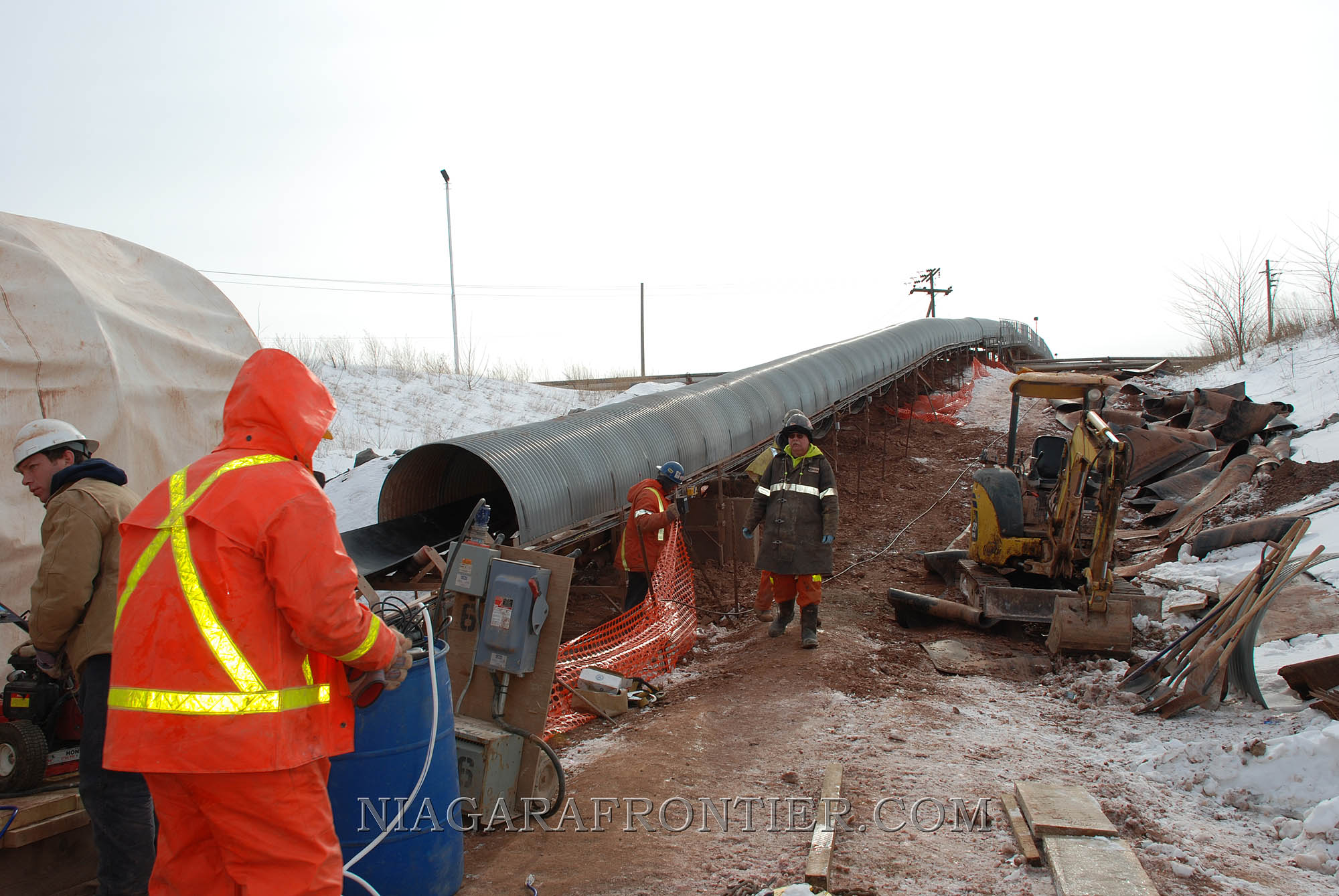

Workers replacing the overland conveyor belt

January 26th 2009 -

The overland conveyor belt from the tunnel to the rock dump has been replaced and mining has resumed.

February 5th 2009 -

The tunnel is 3473 meters long (11,394 feet) with a continuous roof line over-break of up to 4 metres (13 feet). Progress is averaging 6 metres per day.

February 12th 2009 -

The tunnel is 3503.7 meters long (11,495 feet) with continuous roof line over-break of up to 3.8 metres. Progress is averaging 6 metres per day. TBM has already begun ascent to the Whirlpool Sandstone rock strata on a 7.150% gradient (rising 7.15 meters every 100 meters). The TBM will follow a route directly under Stanley Avenue.

February 13th 2009 -

Progress rate reaches 8.2 meters. Average push is now 90 centimeters up from previous 80 centimeters.

February 23rd 2009 -

The tunnel is 3574.9 meters (11,728.5 feet) long with continuous over-break of up to 4 meters. The progress rate is averaging 6 meters per day.

March 2nd 2009 -

The tunnel is 3618.6 meters (11,872 feet) long with continuous over-break of up to 4 meters. The progress rate is averaging 5 meters per day.

March 12th 2009 -

The tunnel is 3693 meters (12,116 feet) long with continuous over-break of up to 4 meters. The progress rate is averaging 5 meters per day.

March 22nd 2009 -

The Toronto Star Newspaper reported today the according to the OPG, the Niagara Tunnel Project could be three years behind schedule.

Ontario Power Generation confirmed today that its Niagara tunnel project could be three years late in a worst-case scenario, but the province-owned power producer denied reports that the cost of the hydroelectric venture is at risk of more than doubling. The tunnel is being built to divert more water from Niagara Falls to the Adam Beck power station, which will be able to generate enough additional electricity to power 160,000 homes. But Big Becky, the massive boring machine that's digging the 10-kilometre, 14-metre wide tunnel has run into some dangerous rock conditions and is behind schedule. OPG disclosed late last year that the project will be late and over budget, but the details are still under review.

Global News, citing an interview with John Murphy, OPG's executive vice-president of hydro, reported on Friday that the project could cost $1.6 billion and be three years late under a worst-case scenario. It also reported the original cost estimate as $600 million. However, OPG spokesperson Ted Gruetzner told the Star that the original estimate was $985 million. He doesn't dispute the $1.6 billion figure, just the suggestion it's more than doubling the cost of the project. In reality it would represent a 62 per cent increase.

Gruetzner also said it's unclear how much of that additional costs, if any, will be borne by electricity ratepayers. OPG is still negotiating its contract with Strabag AG, the Austrian company leading the project. A dispute review board is expected to determine who will bear the cost or whether it should be shared between the two parties.

"Once we do get the final timelines we'll announce that," said Gruetzner, adding that the update could come next month.

OPG says that even in a worst-case scenario the project is still economical because the tunnel will deliver clean electricity for more than 90 years. But critics say the company should have known about the rock conditions before committing to such a complex engineering project.

March 23rd 2009 -

The tunnel is 3762.2 meters (12,342 feet) long with continuous over-break of up to 4 meters. The progress rate is averaging 5 meters per day.

April 11th 2009 -

The tunnel is 3855.3 meters (12,648 feet) long with continuous over-break of up to 2.85 meters. The progress rate is averaging 6 meters per day.

April 14th 2009 -

The tunnel is 3873.84 meters (12,709.2 feet) long with continuous over-break of up to 2.85 meters. The progress rate is averaging 6 meters per day.

April 30th 2009 -

The tunnel is 4007 meters (13,146 feet) long with continuous over-break of up to 2 - 2.5 meters. The progress rate is averaging 7-8 meters per day.  The TBM has stopped ascending (39.778 meters - 130 feet) and has levelled it's trajectory. It was originally hoped that the crown of the TBM cutter-head would be cutting into the Whirlpool Sandstone rock strata while the lower portion of the cutter-head would continue to mine in the Queenston Shale rock strata. It appears at this point that the TBM remains approximately 2 meters below the Whirlpool Sandstone and for the time being continues to mine entirely within the Queenston Shale layer. The over-break has been significantly reduced.

May 3rd 2009 -

The
average push of the TBM is now 1 meter (up from a previous average 80 centimeters). Over-break continues at 2 to 2.5 meters.

The Invert Concrete Formwork Bridge has poured approximately 350 meters of finished concrete tunnel lining. It is progressing at a rate of approximately 62.5 meters per week with an estimated rate of 100 meters per week in the near future.

To date approximately 700,000 cubic meters of rock debris have been mined from the tunnel.

May 9th 2009 -

The tunnel is 4067.9 meters (13,346 feet) long with continuous over-break of up to 2.85 meters. The progress rate is averaging 6 meters per day. The
average push of the TBM is now 1-2 meters (up from a previous average 80 centimeters). Over-break continues at 2 to 2.8 meters. The TBM had been halted for the past three days to allow for the expansion of the rock conveyor system.

The TBM has begun to ascend another 1.50 meters (5 feet) over a distance of approximately 150 meters . When it levels out after this brief climb, it will continue to mine entirely within the Queenston Shale strata however the over-break will be significantly reduced. The TBM will be approximately 80 centimeters below the Whirlpool Sandstone strata.

The Invert Concrete Formwork Bridge has poured approximately another 100 meters of finished concrete tunnel lining during the past week.

May 19th 2009 -

The tunnel is 4148.0 meters (13,609 feet) long with continuous over-break of up to 2 to 2.5 meters. The progress rate is averaging 7-8 meters per day. The
average push of the TBM is now 1-2 meters (up from a previous average 80 centimeters).

May 22nd 2009 -

Ontario Power Generation has released information in its first quarter financial report of 2009 that the cost of the Niagara Tunnel project has risen from
the original project cost estimated at $985 million with a scheduled completion of June 2010 to the revised project cost estimated at $1.6 billion and the revised scheduled completion by December 2013.

May 23rd 2009 -

The TBM is now pushing forward at a rate of 1.2 to 1.6 meters and is averaging 6-7 meters per day. The over-break above the crown of the TBM cutter-head is approximately 2 - 2.5 meters. The crown of the tunnel has become much flatter in appearance as the TBM nears the bottom layers of the Whirlpool Sandstone. The TBM has levelled out after an ascent of 10 meters (33 feet). On the current trajectory, the TBM will climb at a grade of 0.010% (10 centimeters for every 1 kilometer).

The Invert Concrete Formwork Bridge advancing at a rate of 100 meters per week as it lines the bottom portion of tunnel with finished concrete.

May 27 2009 -

The tunnel is 4230.9 meters (13,881 feet) long with continuous over-break of up to 2 to 2.5 meters. The TBM is now pushing forward at a rate of 1.2 to 1.6 meters and is averaging 6-7 meters per day.

June 1st 2009 -

The tunnel is 4245 meters (13,927 feet) long with continuous over-break of 1.4 meters but decreasing. The TBM is now pushing forward at a rate of 1.2 to 1.6 meters and is averaging 10 meters per day.

June 11th 2009 -

The tunnel is 4348.9 meters (14,268 feet) long with continuous over-break of 1.4 meters but decreasing. The TBM is now pushing forward at a rate of 1.2 to 1.6 meters and is averaging 10 meters per day.

June 13th 2009 -

The TBM is halfway into a one meter (3.28 feet) ascent. Roofline over-break above the crown of the TBM cutter-head is 60 centimeters and lessening as the climb to a higher elevation towards the Whirlpool Sandstone strata continues. The TBM is now progressing at a rate of 13 meters per day with each push forward averaging 1.1 meters.

Since beginning it's journey the TBM has been in operation more than twenty-two thousand (22,000) hours.

The Invert Concrete Formwork Bridge has poured approximately 750 meters of finished concrete tunnel lining to the bottom portion of the tunnel.

June 21st 2009 -

The tunnel is 4459.6 meters (14,631 feet) long with continuous over-break of 60 centimeters and decreasing. The TBM is now pushing forward at a rate of 1.1 to 1.2 meters and is averaging 13 meters per day. The TBM has levelled it's trajectory and is moving forward at near maximum capacity. The crown of the TBM cutter-head  will soon begin mining into the much more stable Whirlpool Sandstone above.

The Whirlpool Sandstone rock strata is quite narrow averaging 4 to 7 meters in thickness and the entire rock strata drops in elevation the farther south the TBM progresses.

The Invert Tunnel Concrete Lining is 1050 meters long and is averaging 100 meters per week.

June 30th 2009 -

The Tunnel Boring Machine (TBM) has mined a record best of 323 meters (1,060 feet) during the month of June.

July 1st 2009 -

The tunnel is 4568 meters (14,986 feet) long with no roof line over-break. The TBM is mining forward at near maximum capacity. The crown of the TBM cutter-head is mining in the much more stable Whirlpool Sandstone rock strata.

July 5th 2009 -

The TBM sets a single day mining record of 21.1 meters (69.2 feet)  and a single shift mining record of 14 meters (46 feet). There is no roof line over-break.

July 6th 2009 -

The tunnel is 4656 meters (15,275 feet) long with no roof line over-break. The TBM is mining forward at near maximum capacity. The crown of the TBM cutter-head is mining into the much more stable Whirlpool Sandstone rock strata. The current elevation is approximately 97.5 meters (319.8 feet) below the surface.

The TBM pushes approximately a meter at a time before being required to stop to re-grip as the TBM moves forward. With no over-break, the process of reinforcing of the roof with rebar, steel joists and expansion bolts are done virtually simultaneous as the TBM cutter-head is engaged. The only limitation is the amount of debris the rock conveyor can handle and the speed of the mucking operations under the TBM behind the cutter-head.

The cutter-head of the TBM crown is now clearly mining into the Whirlpool Sandstone. The sandstone rock occasionally cracks with sounds similar to that of thunder as it is mined. The vibration aboard the TBM is much more intense.

The Invert Tunnel Concrete Lining is approximately 1400 meters long and is averaging 100 meters per week.

Fresh air into the tunnel is now being channelled through the five existing dewatering shafts from the surface to the tunnel. The dewatering shafts are located near the 1400 meter mark and at the deepest portion of the tunnel (140 meters/459 feet) . Previously the fresh air had been channelled from the tunnel entrance.

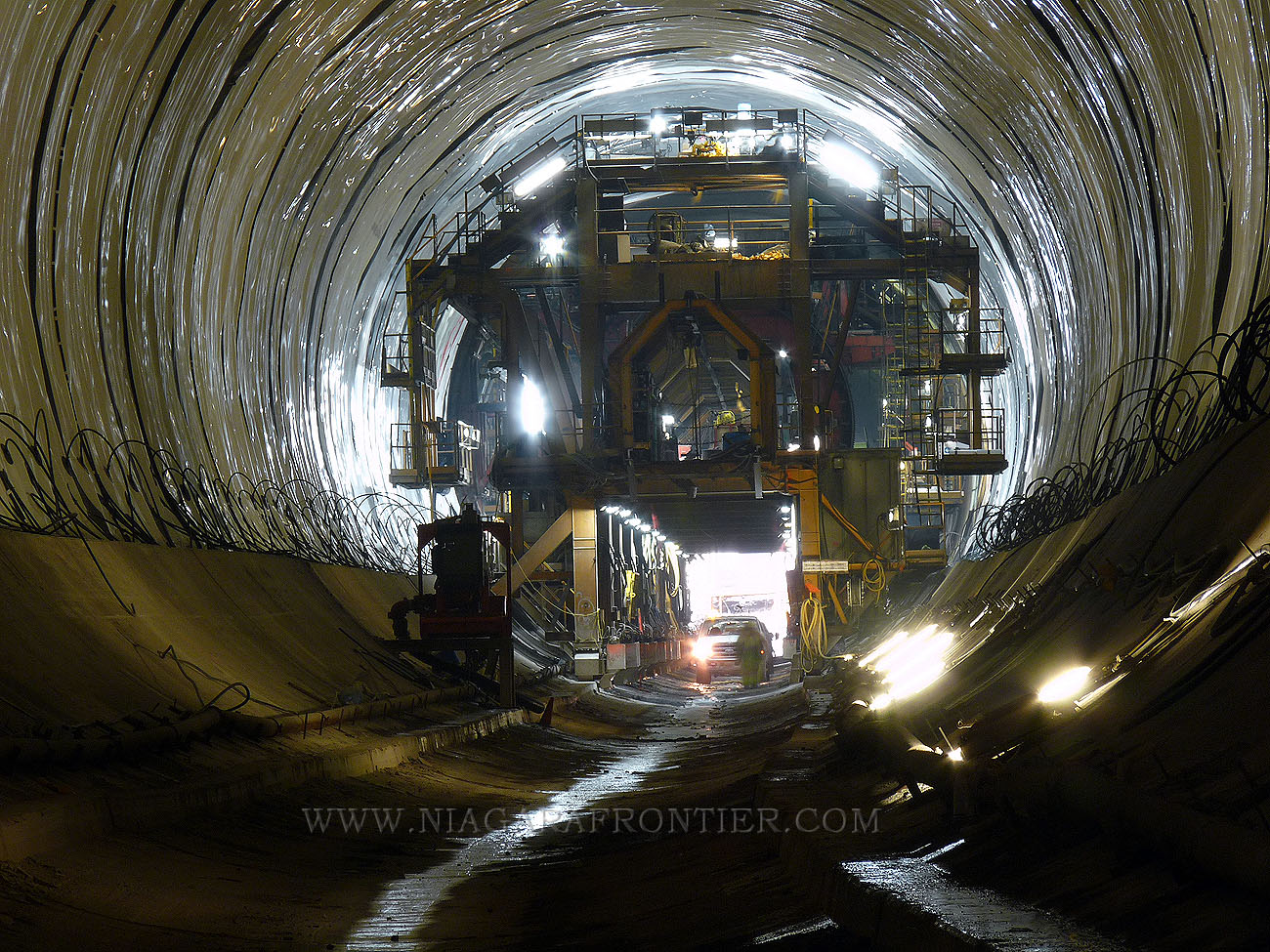

The crown of the TBM cutterhead - July 7th 2009
The crown of the TBM Cutter head - July 7th 2009
the crown is mining into the Whirlpool Sandstone with no roof line over-break

 July 14th 2009 -

The tunnel is 4795.3 meters (15,732 feet) long with zero to .80 centimeter roof line over-break. The TBM is averaging 15 meters per day. The Invert Concrete poured to date is 1,375 meters (4,511 feet).

July 18th 2009 -

The TBM had been inoperative for the previous several days for maintenance updates. It began operations again and completed 20 meters by the end of the day. Over-break is minimal. The TBM is partially mining through the much more abrasive Whirlpool Sandstone. The replacement of cutter discs has become daily with one or two being replaced regularly. Previously while mining the Queenston Shale, the replacement of a cutter discs once or twice a month was typical.

July 20th 2009 -

The tunnel is 4862.1 (15,952 feet) long with zero to .80 centimeter roof line over-break. The TBM is averaging 20 meters per day.

July 27th 2009 -

The tunnel is 4961.3 meters (16,227 feet) long with zero to .80 centimeter roof line over-break. The TBM is averaging 20 meters per day.
The Invert Concrete is 1,450 meters (4,757 feet).

July 29th 2009 -

The TBM (Tunnel Boring Machine) reached the 5000 meter (16,404 feet) milestone at 2:08 p.m.

August 4th 2009 -

The TBM reached the 5,079 meter official halfway milestone of the Niagara Tunnel Project at 02:30 hours (2:30 a.m.).

August 6th 2009 -

The tunnel is 5115 meters (16,781 feet) long with zero to .80 centimeter roof line over-break. The TBM is averaging 19 meters per day.
The Invert Concrete is 1,500 meters (4,921 feet).

 August 15th 2009 -

The tunnel is 5199.50 meters (17,058 feet) long. The TBM is averaging 11 meters per day.
The crown of the TBM cutter-head has begun mining the bottom of the Power Glen rock strata within the last 30 meters (100 feet) or so and it's coasting just above the centre of the shield. The roofline is horizontal on the left side with over-break down to the end of the shield. The Whirlpool Sandstone/Queenston Shale contact is currently about a meter above the spring-line, so thickness of Whirlpool Sandstone is about 6.2 - 6.3 metres (20.3-20.6 feet) in thickness. Elevation is 89.633 meters (294 feet).

 August 18th 2009 -

The tunnel is 5239.0 meters (17,188 feet) long. The TBM is averaging 20 meters per day.

 August 22nd 2009 -

The tunnel is 5289.48 meters (17,354 feet) long at an elevation below the surface of 89.775 meters (294.5 meters). The TBM is averaging 12.63 meters per day. The over-break has returned. It is approximately 1.7 meters (5.6 feet) in that top left corner of the flat ceiling and about 1 meter (3.2 feet) above the centreline. Apparently the same type of rock over-break was similar as the TBM descended at the beginning of the tunnel boring process at a chainage of about 0+650 (2,132.5 feet). The over-break is in the bottom of the Power Glen Rock Strata Formation. The Power Glen Formation grades upward from shale to a sandstone, so the over-break should lessen as the TBM ascends up through this strata and into the Grimsby Formation.

August 31st 2009 -

Contrary to the projection, the tunnel over-break has increased to 3 meters (10 feet) and as a result the TBM is progressing at a daily rate of 5-6 meters per day.

September 3rd 2009 -

The tunnel is 5370 meters (17,621 feet) long at an elevation below the surface of 89 meters (292 feet). The tunnel over-break has increased to 2.5 meters (8.2 feet) and as a result the TBM is progressing at a daily rate of 5-7 meters per day.

The Invert Concrete Bridge is 1,925 meters (6,315.5 feet).

September 9th 2009 -

The tunnel is 5404.2 meters (17,730 feet) long at an elevation below the surface of 89 meters (292 feet). The tunnel over-break has increased to 3.5 meters (9.8 feet) and as a result the TBM is progressing at a daily rate of 5-7 meters per day.

The Invert Concrete Bridge is 2,000 meters (6,561.6 feet).

September 11th 2009 -

The tunnel is 5418 meters (17,775 feet) long at an elevation below the surface of 89 meters (292.5 feet). The tunnel over-break is 3.5 meters (9.8 feet) and as a result the TBM is progressing at a daily rate of 5-7 meters per day. Mining has been halted following a fall of ground at 3,600 meters. The clearing of debris and repairs to the effected area as well as a scheduled six week shut down for maintenance of the TBM will precede continuation of mining.

Niagara Falls Review:

Work on the Niagara Tunnel Project has resumed after a small portion of the temporary lining and Queenston shale fell at the construction site Friday morning. The material that fell was enough to fill a few dump trucks, said Ernst Gschnitzer of Strabag, the contractor on the Niagara Tunnel Project. No one was injured, as on-site workers escaped from the tunnel safely using what a company press release described as well-rehearsed procedures.

"When this type of event does occur in tunnel and mining projects, safety is our top priority so we'll make every effort to find out what happened and make sure it doesn't happen again," said Gschnitzer.

The incident happened about two kilometres behind the current location of the tunnel-boring machine nicknamed Big Becky, in an area that experienced some of the most severe "overbreak" during the digging.  A realignment of the tunnel route moved Big Becky to more stable rock conditions and the project has been making progress, having recently moved past the halfway mark of the 10.2-kilometre tunnel.  Gschnitzer said work is continuing on the first 3.5 kilometres of the tunnel and intake structure, and that a six-week maintenance outage that was scheduled to start at the end of the month was moved up and started Friday. Strabag engineers are working with staff from the Ontario Ministry of Labour to determine the cause of the event and how best to move forward.

September 12th 2009 -

Niagara Falls Review:

Work on the Niagara Tunnel Project has resumed after a small portion of the temporary lining and Queenston shale fell at the construction site Friday morning. The material that fell was enough to fill a few dump trucks, said Ernst Gschnitzer of Strabag, the contractor on the Niagara Tunnel Project.  No one was injured, as onsite workers escaped from the tunnel safely using what a company press release described as well-rehearsed procedures.

"When this type of event does occur in tunnel and mining projects, safety is our top priority so we'll make every effort to find out what happened and make sure it doesn't happen again," said Gschnitzer. The incident happened about two kilometres behind the current location of the tunnel-boring machine nicknamed Big Becky, in an area that experienced some of the most severe "overbreak" during the digging.  Gschnitzer said work is continuing on the first 3.5 kilometres of the tunnel and intake structure, and that a six-week maintenance outage that was scheduled to start at the end of the month was moved up and started Friday.

Strabag engineers are working with staff from the Ontario Ministry of Labour to determine the cause of the event and how best to move forward. Strabag is building the Niagara tunnel for Ontario Power Generation.

October 7th 2009 -

Niagara This Week: reporter Bill Robinson

There will be no more tunnelling under the city’s streets until the contractor makes repairs to a portion of the Big Becky tunnel that collapsed early last month.

The Ontario Ministry of Labour issued a stop work order to Strabag, the German-based company contracted for the Niagara Tunnel Project, after a collapse occurred on September 11th 2009. Bruce Skeaff, spokesman for the Ministry of Labour, said no work can be done beyond the 3,500-metre mark of the tunnel, where the collapse occurred, until deemed safe by the ministry.

“We have stop work orders in place, so no more tunnelling can go on while the employer continues to repair the tunnel,” Skeaff said. “Drilling is halted until the repairs are done and quality assessments have been completed. We’ve got engineers working with the employer to make sure that everything is done properly and up to our standards.”

Strabag issued a statement after the collapse, saying “a small portion of the temporary tunnel lining and Queenston shale fell.”  No workers were injured during the collapse.

Project manager Ernst Gschnitzer said this type of collapse is not uncommon, and occurred about two kilometres behind the present location of “Big Becky,” the tunnel boring machine.

“While this type of event does occur in tunnel and mining projects, safety is our top priority so we’ll make every effort to find out what happened and make sure it doesn’t happen again,” Gschnitzer said, adding the amount of material that fell “would fill a few dump trucks.”

The collapse caused Strabag to prematurely begin a six-week maintenance operation that had originally been scheduled to take place the end of September. As a result, the company laid off about 100 workers, Gschnitzer said.

“Obviously, we have some temporary layoffs,” he said. “We’re working behind schedule but we hope to be up and running in about a month.”

Gschnitzer said while drilling has halted, work and repairs are still being done inside the tunnel, which is now 5,418 metres long, and that Big Becky is currently under Stanley Avenue, near Valley Way, undergoing maintenance.

Completion of the 10-kilometre tunnel, which will add enough electricity to power a city twice the size of Niagara Falls by allowing more water to the Sir Adam Beck generating stations in Queenston, was pushed back to some time in 2010 instead of late 2009 as originally planned.

Strabag ran into problems drilling through Queenston Shale. The cost of creating the tunnel has more than doubled from an estimated $985 million to $1.6 billion.

In a previous interview with Niagara This Week, John Earl, a spokesperson for Ontario Power Generation, said there are stipulations built into the contract that will protect the province, and taxpayers, from any cost overruns as well as incentives for Strabag to complete the project on schedule.

November 1st 2009 -

Scheduled maintenance of TBM is in progress. The Invert Concrete Bridge is 2,640 meters (8,661 feet).

November 13th 2009 -

Niagara Falls Review: reporter Corey Laroque

Tunnel work back on track after September cave-in causes delay, OPG says
Mining to resume after planned outage ends in December

Work resumed this week on the Niagara Tunnel Project after it was stopped in Sept following the collapse of rock from the ceiling of the tunnel, Ontario Power Generation announced in an update on the project. It means about 368 workers are back on the job and a full complement of 398 will be working again some time in December when full-scale excavation resumes, said OPG spokesman Ted Gruetzner.

"They're expected to be back up and running again in December," Gruetzner said.

Work had been disrupted since Sept. 11 when there was a collapse of rock from a 25-metre section of the tunnel's ceiling. It occurred about two kilometres into the tunnel, more than three kilometres behind the spot where the tunnel-boring machine, nicknamed Big Becky, is cutting into the rock face.

Big Becky was about 5.4 kilometres into the tunnel when the collapse occurred. No one was injured as workers followed what Strabag's project manager Ernst Gschnitzer called a "well-rehearsed" evacuation. Ontario's Ministry of Labour ordered a halt to the digging until the debris rock could be removed and the tunnel ceiling reinforced for worker safety.

The delay is not expected to affect the tunnel's 2013 target for completion.

The Niagara Tunnel Project is OPG's $1.6-billion construction of a third tunnel to bring more water to the Sir Adam Beck hydroelectric generators. Over-break had been an ongoing problem for the first three years of the digging because loose Queenston shale in the St. David's gorge area fell in.

Strabag AG, the Austrian mining company hired by OPG to dig a 10-kilometre tunnel under the city of Niagara Falls, had scheduled a planned outage on its tunnel-boring machine for October. They moved the start of that outage up to coincide with the cave-in. Planned outages are scheduled periodically to do maintenance work on the tunnel-boring machine and on other equipment used in the excavation process.

When the rock fell in on Sept. 11th, no one could get past the debris and Big Becky was left unattended. That debris has been removed and wire mesh is being installed on the roof and Shotcrete, a rough form of concrete is sprayed over top to give the tunnel a rough shape.

Both OPG and Strabag say they're committed to worker safety. There have been no significant injuries since work began in 2006.

November 19th 2009 -

Tunnel Talk Magazine:  reporter Paula Wallis

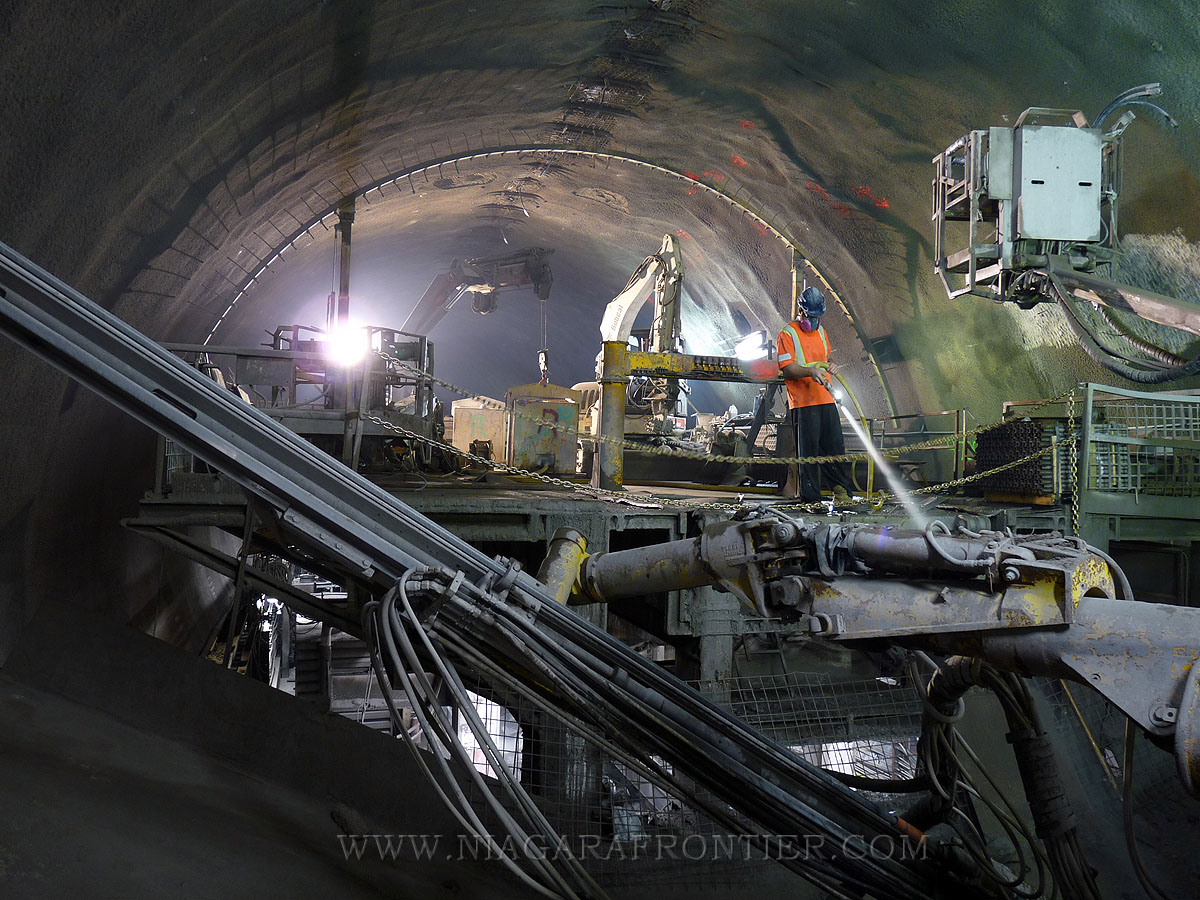

Repairs are complete following a 25m3 rock fall in the tunnel but planned maintenance keeps the mega TBM idle on Niagara's water diversion tunnel some two months after the partial collapse. Meanwhile, in an interview with Tunnel Talk yesterday (November19), the contractor says the root cause of the collapse stems from early geotechnical investigations. Section of high over-break in crown of tunnel - "The crown fall happened in a area surrounding a 20-year old bore hole," said Ernst Gschnitzer, Project Manager for Strabag. "The hole had a long time to deteriorate and eventually the ground gave way."

Gschnitzer said it took some time to make the repairs in part because the contractor had to build up a ramp to reach the crown and the over-break. "We used standard means and methods employed throughout excavation to repair the crown, including 6m (20 ft) rock-bolts and 6m (20 ft) IBO bolts plus wire reinforced Shotcrete," said Gschnitzer. "We will also increase rock supports in areas of known previously drilled bore holes and we have also grouted all these old bore holes." Gschnitzer said the bore hole in question hadn't grouted at the time it was encountered, but has been subsequently.

The partial collapse came just as the TBM was moving into more competent ground and achieving higher progress rates. About 25m3 (100 tonnes) of temporary lining and Queenston Shale fell from the crown on September 11th 2009. According to the owner, Ontario Power Generation, no one was injured in the collapse and all of the workers left the tunnel safely, following established emergency procedures. The fall occurred about 2 km (1.2 miles) behind the TBM, and some 3,600 meters (2.2 miles) into the 10 kilometer (6.2 mile) long ,14.4 meter (47ft) diameter tunnel, in an area that experienced some of the most severe over-break to date.

It happened on the new alignment in 80 meters (262 ft) of overburden and beyond the immensely challenging section under the St David's Gorge that cancelled out the original completion schedule and cost estimate of the contract. The revised schedule agreed to as part of the realignment. The original project cost was estimated at $985 million with a scheduled completion of June 2010. The revised project cost estimate is $1.6 billion and the revised schedule completion date is December 2013. The contract includes revised incentives and penalties tied to the new target cost and schedule.

A six-week maintenance outage planned for the end of September on the Robbins TBM was moved forward and combined with the crown repairs. "After 5.4km (3.4 miles), partially in very abrasive rock, the bucket lift scrapers were worn out, so we have some major refurbishment on the cutter-head and we are also making repairs to the conveyor system, trucks and trailers and other equipment," said Gschnitzer.

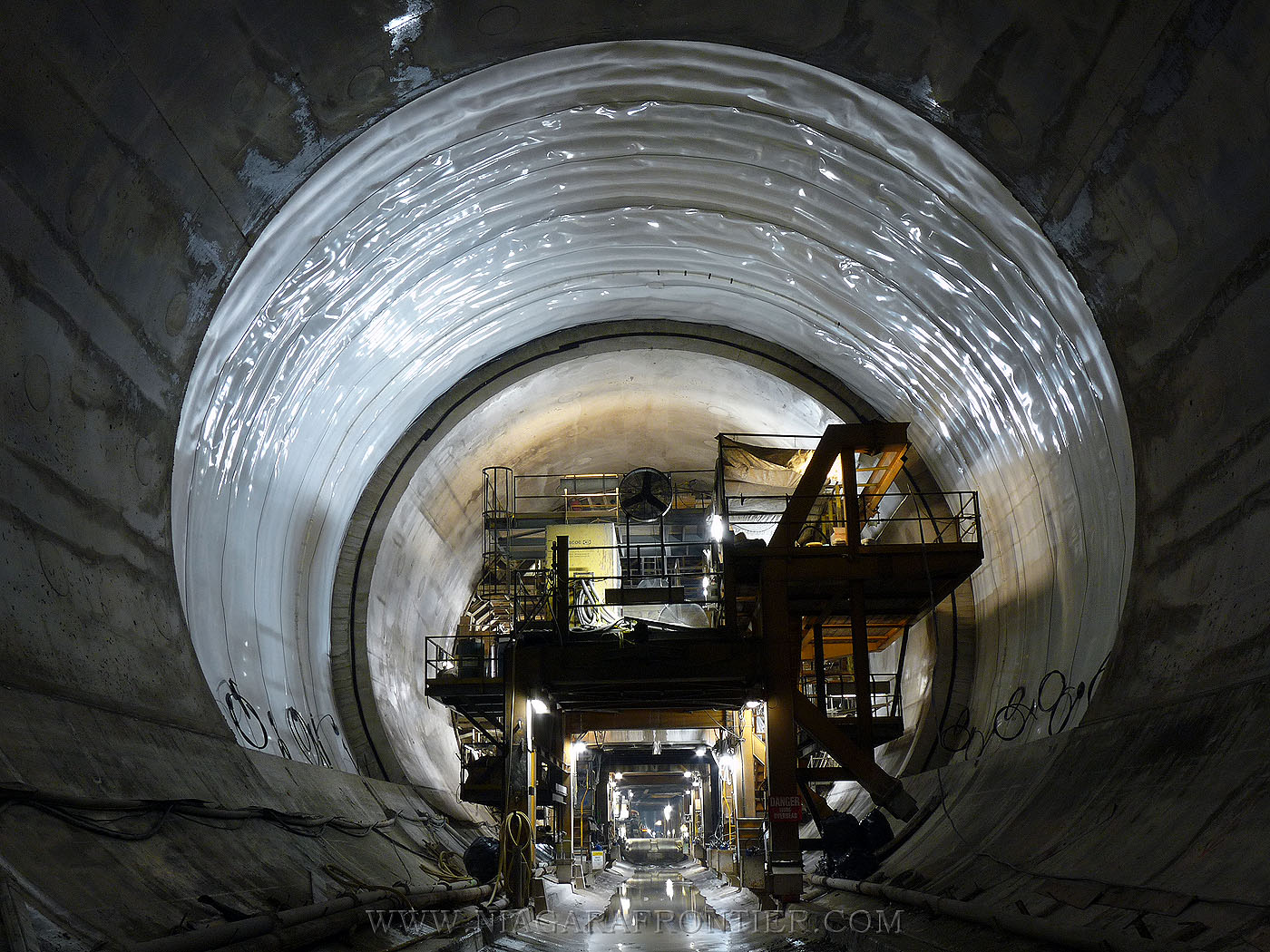

Meanwhile installation of the concrete lining is progressing ahead of the revised schedule. Before the stoppage, ground conditions had improved markedly following a change in the vertical alignment that was initiated late last year. Progress rates jumped to a high of 468m (1,535ft) for the month of July. "That was excellent, and confirmed that changing the alignment was the right decision," said Gschnitzer. "Since then rates have deteriorated a little to about 8m-10m/day (26ft-32ft), but not to the extent of what we experienced in the Queenston Shale, and we expect decent progress rates once we resume excavations in about two weeks." Repairs to the crown were completed at the end of October and Gschnitzer says the TBM repairs will be completed shortly, with excavation resuming in early December.

December 4th 2009 -

The annual St. Barbara Day celebration is held. No significant injuries have been reported during the past three years of tunnelling.

December 8th 2009 -

TBM mining has resumed.

December 20th 2009 -

The tunnel is 5454.9 meters (17,897 feet) long at an elevation below the surface of 89 meters (292 feet). The tunnel over-break is 3 meters (9.8 feet).

The Invert Concrete Bridge is at 3,300 meters (10,827 feet).

The Shotcrete Over-break Carrier is at 500 meters.

December 31st 2009 -

At the end of 2009, the tunnel is 5480.7 meters (17,981 feet) long at an elevation below the surface of 88 meters (289 feet).
The tunnel over-break is 3.4 meters (11.15 feet).

January 10th 2010 -

The tunnel is 5541.2 meters (18,179.5 feet) long at an elevation below the surface of 89 meters (292 feet).
The tunnel over-break is 3.4 meters (11.15 feet).

The Invert Concrete Bridge is at 3,475 meters (11,401 feet).

The Shotcrete Over-break Carrier is at 551 meters (1,808 feet).

A 300 meter section of the conveyor belt was torn causing a shut down of TBM production. The conveyor section was damaged as a result of a rock piercing the belt as it dropped onto the conveyor from the TBM. The damaged conveyor belt section caused the TBM to remain idle until it was replaced.

January 13th 2010 -

The TBM resumes mining following a three day delay while a section of conveyor belt was replaced.

January 27th 2010 -

The tunnel is 5,711 meters (18,737 feet) long at an elevation below the surface of 89 meters (292 feet). The crown of the TBM cutter-head is mining into the silt/sandy Power Glen rock strata.
There is no tunnel over-break. The TBM is currently averaging 18.5 meters per day. The Invert Concrete Bridge is at 3,725 meters (12,221 feet).

The Overbreak Restoration Carrier is at 900 meters (2,953 feet).

Due to an electrical short in the main power feeder to the TBM, mining was suspended for a period of 5 days until the problem was isolated and repaired.

February 4th 2010 -

The tunnel is 5,757.2 meters long at an elevation below the surface of 89 meters. There is an over-break along the left flank of the crown of 1-1.5 meters. The TBM averaging 10 meters per day.
The Concrete Invert Bridge is at 3,850 meters. The Restoration Carrier: Grinding is at 1,040 meters/ Shotcrete is at 800 meters

February 7th 2010 -

Work has begun at the 4500 meters mark of the tunnel to sink a new ventilation shaft from the surface to the tunnel. Once constructed, it will replace the existing dewatering shafts currently utilized for providing ventilation into the tunnel.

February 19th 2010 -

The tunnel is 5,958.3 meters long at an elevation below the surface of 89 meters. There is 1-1.5 meters over-break. TBM averaging up to 14.3 meters per day. The Concrete Invert Bridge is at 4,100 meters and the Restoration Carrier is at 1,100 meters.

February 21st 2010 -

The tunnel is 17.7 meters from reaching the 6,000 meters mark. There is 1-2 meter over-break to the left side of the TBM cutter-head crown. The daily mining average is 9 meters.  Since January 1st 2010 the TBM has mined 501.6 meters.

A new air shaft is currently under construction at the 5,318 meter mark of the tunnel. An 8 meter long adit (shaft) will be mined perpendicular into the eastern side of the existing tunnel at the springline before a pilot hole is drilled from the surface. Once the pilot hole reaches the access shaft, a 3 meter diameter hole will be constructed to the surface. This shaft will supply fresh air to the tunnel.

February 21st 2010 -

On Monday February 22nd at 4:38 p.m. (16:38 hrs) the Tunnel Boring Machine nicknamed 'Big Becky' passed the 6'000 meter mark. The TBM is underneath Stanley Avenue
in front of the LaPenna Co. Liquidation Store.

March 4th 2010 -

The TBM is at 6,097.5 meters. There is 1-2 meter over-break to the left side of the TBM cutter-head crown. The daily mining average is 9 meters. The Invert Concrete Carrier is at 4,225 meters. The Overbreak/Restoration Carrier  is at 1,250 meters.

March 7th 2010 -

The TBM is at 6,152.6 meters. There is less than 30 cm over-break. The daily mining average is 10.4 meters. Elevation is 92 meters below the surface.

The TBM has mined 672 meters since January 1st 2010. During the past week, mining had been suspended for three days to allow for routine maintenance and upgrades. The adit for the new air shaft is now 6 meters of a total of 8 meters. During the past week, mining was suspended for three days to allow for routine maintenance.

March 12th 2010 -

The TBM is at 6,233.1 meters. There is less than 30 cm over-break. The daily mining average is 16.1 meters. Elevation is 92 meters below the surface.

The Invert Concrete Carrier is at 4,325 meters.

The Overbreak/Restoration Carrier  is at 1,250 meters. This operation will be between 590 meters and 1'250 meters for a period of time as the carrier has to go back and forth several times.

March 24th 2010 -

The TBM mined a near daily record best of 21.2 meters (69.55 feet).

March 25th 2010 -

The TBM is at 6,379 meters. There is less than 30 cm over-break.  Elevation is 92 meters below the surface.

March 31st 2010 -

The TBM is at 6,469.5 meters. There is up to 1 meter over-break. Elevation is 91 meters below the surface. Daily mining average is 15 meters.

The Invert Concrete Carrier is at 4,525 meters.

The Overbreak/Restoration Carrier is at 800 meters. This operation will be between 800 meters and 1,400 meters for a period of time as the carrier has to go back and forth several times.

April 7th 2010 -

The TBM is at 6,552.5 meters. There is up to 1 meter over-break. Elevation is 91 meters below the surface. Daily mining average is 15 meters.

The Invert Concrete Carrier is at 4,575 meters.

The Overbreak/Restoration Carrier is at 800 meters. This operation will be between 800 meters and 1,400 meters for a period of time as the carrier has to go back and forth several times.

April 2010 -

Construction has begun on the building of a new primary air shaft to provide fresh air into the Niagara Tunnel. The site is located on hydro property along the east side of Stanley Avenue just north of Valleyway. A 15 meter long steel pipe - 3 meters in diameter has been sunken into the ground to the bedrock below. The surface soils have been removed to expose the bedrock from within the pipe. A pilot shaft is going to be drilled to the existing tunnel below. Once the location is confirmed as accurate, a small cutterhead (approximately 2.5 meters in diameter) similar to that of the TBM cutterhead will begin cutting a bore hole from the surface to the tunnel below. This new air shaft is expected to be ready for service in June.

April 24th 2010 -

A 600 mm pilot shaft has been drilled to the existing tunnel adit below. Once the location is confirmed as accurate, a small cutterhead (approximately 2.5 meters in diameter) similar to that of the TBM cutter head will begin cutting a bore hole from the surface to the tunnel below. This new air shaft is expected to be ready for service in June.

April 25th 2010 -

The TBM is at 6,745 meters. There is up to 1 meter over-break. Elevation is 91 meters below the surface. Daily mining average is 12 meters.
The Invert Concrete Carrier is at 4,775 meters.

April 27th 2010 -

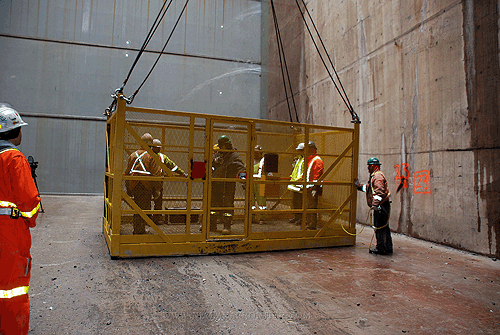

Four Strabag workers were taken to hospital as a precaution Tuesday after an early morning fire inside the Niagara Tunnel Project forced about 30 workers to take shelter in rescue containers and put in practice the emergency procedures they practice every six months.

A diesel compressor used for pumping water caught fire about 5:30 a.m., said Ernst Gschnitzer, the project manager for Strabag, the Austrian company hired to build the 10.2-km tunnel that will divert more Niagara River water to the Sir Adam Beck hydroelectric generating stations.

Strabag officials had not determined what caused the compressor to catch fire. The fire took place at about the 5,300-metre mark in the tunnel, a section of the tunnel underneath the intersection of Stanley Ave. and Valley Way. "The workers established our emergency procedure. A few of the workers began extinguishing the fire," Gschnitzer said. "There was a huge pile of smoke."  Tuesday's fire was the first time the containers had been used in a real situation, though they have been used as part of the emergency drills Strabag conducts every six months.

There are two rescue containers attached to Big Becky, the tunnel-boring machine. Each one is big enough to accommodate 25 people and provide enough oxygen for 24 hours. The purpose of the containers is to give workers a safe place to stay during an emergency while rescuers get to them.

"The guys did all the right things. It worked like it did on previous training exercises," Gschnitzer said. Stranded workers were able to leave the tunnel at about 10 a.m. Four were sent to hospital for treatment as a precaution for smoke inhalation. All the men were subsequently released.

Work was expected to resume at the tunnel at 3 p.m., Gschnitzer said. The city's fire department was not called to the tunnel construction site, whose entry point is off Stanley Avenue, south of Thorold Stone Road. Firefighters are not trained in going into a tunnel, so Strabag counts on its own staff to be trained to fight fires, Gschnitzer said.

April 28th 2010 -

The TBM has accomplished a single day BEST mining distance of 22.4 meters (73.49 feet). The previous single day BEST occurred on July 11th 2009 for mining with a distance of 22.3 meters (73 feet).

April 29th 2010 -

The TBM is at 6,799 meters. There is up to 1 meter over-break. Elevation is 91 meters below the surface.  Daily mining average is 13.5 meters.
The Best Weekly Record was eclipsed during the week of April 26th-April 29th 2010 for mining a distance of 136.3 meters (447 feet).

May 1st 2010 -

The TBM has accomplished a single day BEST mining distance of 25.4 meters (83.3 feet). The previous single day BEST occurred on on April 28th 2010 for mining with a distance of 22.4 meters (73.49 feet).

May 2nd 2010 -

The TBM is at 6,882 meters (22,578.4 feet). The TBM has been shutdown for scheduled maintenance and to allow for the launch of the arch forms into the tunnel. On May 11th, the widening of the new air vent shaft will begin. The ventilation shaft is 2.6 meters internal diameter and 2.7 meters bore diameter.

May 29th 2010 -

The TBM is still undergoing scheduled maintenance and is not expected to begin mining until June 20th. The first of two arch forms has been moved into position just inside the tunnel entrance.

On Thursday May 27th, the first concrete pouring on the arch form bay (12.5 meters) took place. The two arch forms are designed to take turns pouring every other section in succession. The arch forms when fully functioning will attain an average rate of 21 meters per day.

Work continues on the new air vent shaft. The maximum outer diameter of the shaft is currently being drilled. Before this vent shaft becomes fully functional it will need to be lined and grouted. In addition, the Invert Carrier will have to pour concrete beyond the location of the adit.

Work on the Invert Carrier resumed this past week.

Work on the Restoration Carrier continues reinforcing and reshaping the crown of the tunnel. Shotcrete spraying continues in multiple 400 millimeter layers to reshape the crown damaged from previous overbreak.

June 19th 2010 -

The TBM has resumed mining.

June 28th 2010 -

At the beginning of the day shift, the TBM is at 6,993.5 meters (22,944 feet). The Invert Carrier is at 5,075 meters (16,650 feet) and the Restoration Carrier is at 1,865 meters (6,119 feet).
At 6 p.m. (18:00 hrs), the TBM reached the 7,000 meter milestone.

Both Arch Carriers have been moved into the tunnel.

July 1st 2010 -

At the beginning of the day shift, the TBM is at 7,050 meters (23,130 feet). There is no appreciable overbreak.

July 7th 2010 -

Rock boring (2.7 meters diameter) for the air vent shaft located on Stanley Avenue has been completed.

July 8th 2010 -

At the beginning of the day shift, the TBM is at 7,152 meters (23,464 feet). The TBM is averaging 15 meters daily There is no appreciable overbreak.  The Invert Concrete Carrier is at 5,075 meters (16,651 feet). The Arch Concrete Carrier is at 112 meters (367 feet).

July 16th 2010 -

At the beginning of the day shift, the TBM is at 7,315 meters (23,999 feet). The TBM is averaging 20.3 meters daily. There is no appreciable overbreak. The Arch Concrete Carrier is at 150 meters (492 feet).

July 22nd 2010 -

The TBM mining has stopped pending a conveyor belt extension.

July 23rd 2010 -

The TBM is at 7,447.6 meters (24,434 feet) at a depth of 91 meters (301 feet).  The TBM is averaging 19 meters daily. There is no appreciable overbreak.  The Arch Concrete Carrier is at 200 meters (656 feet). The Restoration Carrier is at 2,050 meters (6,726 feet). The Air Shaft: drilling is done, the liner pipe has been installed and by the end of next week the grouting of the annular gap will be completed. The Invert Concrete Carrier is awaiting completion of the air shaft before progressing forward.

July 30th 2010 -

The TBM is scheduled to resume mining in this afternoon following a one week shutdown for maintenance .  The Invert Carrier is at 5,300 meters. The Invert Concrete Carrier is scheduled to resume work during the middle of next week (August 3-5). The Invert Concrete Carrier is awaiting completion of the air shaft before progressing forward beyond the adit.

August 6th 2010-

At the beginning of the dayshift, the TBM is at 7,559.6 meters (24,801.5 feet) at a depth of 91 meters (301 feet).  The TBM is averaging 19 meters daily. There is no appreciable overbreak.  The Arch Concrete Carrier is at 275 meters (902 feet). The Restoration Carrier is at 2,140 meters (6,726 feet). The Invert Concrete Carrier is at 5,300 meters (17,388 feet) and is awaiting completion of the air shaft before progressing forward beyond the adit.

August 7th 2010 -

At the beginning of the dayshift, the TBM is at 7576.6 meters (24,857.6 feet) at a depth of 90 meters (295 feet).  The TBM is averaging 19 meters daily. There is no overbreak.  The TBM has begun a 1,000 meter long arching curve (south-east) since reaching the 7,393.9 meter mark. The tunnel is beginning to veer away from following the Stanley Avenue route.

There are approximately 300 workers currently employed on the Niagara Tunnel project.

August 14th 2010 -

At the beginning of the dayshift, the TBM is at  7,694.997 meters (25,245 feet) at a depth of 91 meters (298 feet).  The TBM is averaging 23.6 meters daily. There is no overbreak.  The TBM has begun a 1,000 meter long arching curve (south-east) since reaching the 7,393.9 meter mark.

The Invert Carrier is at 5,150 meters. The Restoration Carrier is at 2,230 meters and the Arch Form is at 262.5 meters.

August 15th 2010 -

Since the beginning of 2010, the TBM has progressed 2 kilometers and in the past year it has mined 2,514.4 meters.
The TBM is at  7,717.37 meters (25,319 feet) at a depth of 91.889 meters (301.47 feet)*.

August 20th 2010 -

Ontario Power Generation releases 2nd Quarter Financial Report. Read more

August 23rd 2010 -

The TBM is at  7,786.98 meters (25,245 feet) at a depth (elevation) of 91.879 meters (301.4 feet)*.

August 27th 2010 -

The TBM is at  7,857 meters (25,777 feet) at an elevation (depth) of 91.879 meters (301.4 feet)*.  The Invert Concrete at 5,320 meters. The Overbreak Restoration at 2350 meters and the Arch Forms are at 362.5 meters.

September 4th 2010 -

The TBM is at  7,969.59 meters (26,146.63 feet) at a depth (elevation) of 91.900 meters (301.5 feet)*. The TBM is mining a daily average of 14 meters (46 feet).

September 7th 2010 -

The TBM is at  8,043.50 meters (26,389 feet) at a depth (elevation) of 91.979 meters (301.76 feet)*. The TBM is mining a daily average of 18.4 meters (60.37 feet).

September 15th 2010 -

The TBM is at 8,131.40 meters (26,677.5 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 18 meters (59.5 feet).

September 16th 2010 -

The TBM is at 8,148.5 meters (26,733.6 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 18 meters (59.5 feet).

September 17th 2010 -

At the beginning of their day shift, the TBM is at 8,166 meters (26,791 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 18 meters (59.5 feet). The Invert Concrete is at 5,500 meters. The Restoration carrier is at 2,500 meters and the Arch Concrete is at  450 meters.

September 21st 2010 -

At the beginning of their day shift, the TBM is at 8,207.3 meters (26,926.5 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 10.38 meters (34 feet). The Invert Concrete is at 5,575 meters. The Restoration carrier is at 2,556 meters and the Arch Concrete is at 450 meters.

September 26th 2010 -

At the beginning of their day shift, the TBM is at 8,296.6 meters (27,219.4 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 18 meters (59 feet). The Invert Concrete is at 5,661 meters. The Restoration carrier is at 2,605 meters and the Arch Concrete is at 474 meters.

September 28th 2010 -

The TBM is at 8,314.82 meters (27,279.2 feet) at an elevation of 92.012 meters (301.87 feet)*.

October 11th 2010 -

At the beginning of their day shift, the TBM is at 8,456 meters (27,742 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 12 meters (39 feet). Overbreak is minimal. The Invert Concrete is at 5,900 meters. The Restoration carrier is at 2,720 meters and the Arch Concrete is at 575 meters.

October 12th 2010 -

At 5:15 pm, the TBM is at 8,468.10 meters (27,742 feet) at a depth (elevation) of 91.98 meters (301.65 feet)*.

October 18th 2010 -

At the beginning of their day shift, the TBM is at 8,548 meters (28,044 feet) at a depth (elevation) of 91.944 meters (301.65 feet)*. The TBM is mining a daily average of 13.14 meters (43 feet). Over break is minimal. The Invert Concrete is at 5,975 meters. The Restoration carrier is at 2,800 meters and the Arch Concrete is at 625 meters.

October 22nd 2010 -

At 6 pm, the TBM is at 8,605.79 meters (28,233.8 feet) at a depth (elevation) of 91.97 meters (301.74 feet)*.

October 28th 2010 -

At the beginning of their day shift, the TBM is at 8,640 meters (28,346 feet) at a depth (elevation) of 91.922 meters (301.65 feet)*. The TBM has been undergoing maintenance since October 24th. Mining has resumed.

November 3rd 2010 -

At the beginning of their day shift, the TBM is at 8,716 meters (28,595 feet) at a depth (elevation) of 91.922 meters (301.65 feet)*. The TBM is mining a daily average of 15 meters (50 feet). Overbreak is minimal. The Invert Concrete is at 6,050 meters. The Restoration carrier is at 2,940 meters and the Arch Concrete is at 775 meters.

November 4th 2010 -

At 6 p.m. the TBM is at 8,729.15 meters (28,638 feet) at a depth (elevation) of 92.151 meters (302.3 feet)*.

November 11th 2010 -

At 6 p.m. the TBM is at 8,847.39 meters (29,026.5 feet) at a depth (elevation) of 92.239 meters (302.6 feet)*.

November 16th 2010 -

At 6 p.m. the TBM is at 8,913.32 meters (29,242.8 feet) at a depth (elevation) of 92.068 meters (302.06 feet)*.

November 23rd 2010 -

At 7 a.m. the TBM is at 8,984.43 meters (29,476.2 feet) at a depth (elevation) of 92.062 meters (302.04 feet)*.

November 27th 2010 -

At 7 a.m. the TBM is at 9,009 meters (29,557 feet) at a depth (elevation) of 91.933 meters (301.61 feet)*.

December 1st 2010 -

At 7 a.m. the TBM is at 9,076.92 meters (29,779.5 feet) at a depth (elevation) of 92.160 meters (302.36 feet)*.

December 3rd 2010 -

Mining has been stopped for an undisclosed period of time pending repairs to the TBM that has sustained structural damage.

The TBM is at 9,107 meters (29,878 feet).

December 4th 2010 -

The 4th Annual St. Barbara ceremony took place just inside the tunnel outlet at 10 a.m.  It is the only day of the year that work inside the tunnel is suspended. Safety was the key to a banner year of mining with no major injuries reported. Strabag has surpassed a safety record of 1 million man working hours without a lost day injury.

December 6th 2010 -

A 5.1 cm (2 inch) crack appeared at the top of the main beam (center spine support) of the TBM resulting in the immediate stoppage of mining. The main beam supports the TBM cutterhead, grippers and major hydraulics. In order to repair this crack, four 200 ton jacks have been utilized to lift the sections at the front of the crack and the rear of the crack in order to align the beam before it can be welded.

Ernst Gschnitzer, Project Manager has said "she (the TBM ) has a crack in the Main Beam that we need to repair. After 9,107 meters of mainly difficult ground and more than 6,000 hours, we think she is just getting older and suffering from some correlated disease. We would have had to do some last repair anyway prior to the last reach of tunnel. Including these maintenance and repair works, we expect her back in service by December 27."

The crack created a break seperation in the main beam of 10.2 centimeters (4 inches).

December 29th 2010 -

The TBM has resumed mining.

January 3rd 2011 -

The TBM has reached 9,177.31 meters  (30,108.9 feet) at an elevation of 91.915 meters. The TBM is approximately 68 meters (223 feet) below the surface.

January 5th 2011 -

The TBM has reached 9,192 meters  (30,157 feet) at an elevation of 91.915 meters. The TBM is approximately 68 meters (223 feet) below the surface.
The Arch Concrete Form is at 1,275m (4,183 feet).

January 7th 2011 -

The TBM has reached 9,215 meters  (30,232 feet) at an elevation of 92 meters. The TBM is approximately 68 meters (223 feet) below the surface of the Niagara River. The TBM is mining an average of 12 meters daily.

At 9,458 meters, the TBM will begin to ascend towards the surface at an angle of 7.150%.  At 9,846 meters, the TBM will breakthrough into the existing grout tunnel.

January 9th 2011 -

At the beginning of the shift, the TBM has reached 9,223 meters  (30,258 feet) at an elevation of 92 meters.

January 14th 2011 -

At the beginning of the shift, the TBM has reached 9,271.51 meters (30,418 feet) at an elevation of 91.911 meters (301.54 feet). The TBM is approximately 68 meters (223 feet) below the surface of the Niagara River. The TBM is mining an average of 9.7 meters daily.

At 9,458 meters, the TBM will begin to ascend towards the surface at an angle of 7.150%.  At 9,846 meters, the TBM will breakthrough into the existing grout tunnel.

January 17th 2011 -

At the beginning of the shift, the TBM has reached 9,309.59 meters (30,543 feet) at an elevation of 92.050 meters (302 feet). The TBM is approximately 68 meters (223 feet) below the surface of the Niagara River. The TBM is mining an average of 12.6 meters daily.

January 22nd 2011 -

At the beginning of the shift, the TBM has reached 9,382 meters (30,780 feet) at an elevation of 92.050 meters (302 feet). The TBM is approximately 68 meters (223 feet) below the surface of the Niagara River. The TBM is mining an average of 14.4 meters daily.

The Invert Concrete is at 6,623 meters

The Arch Concrete is at 1,425 meters

January 31st 2011 -

At the beginning of the shift, the TBM has reached 9,456 meters (31,023 feet) at an elevation of 92.050 meters (302 feet). The TBM is approximately 68 meters (223 feet) below the surface of the Niagara River. The TBM is mining an average of 10 meters daily.

The Invert Concrete is at 6,712 meters

The Arch Concrete is at 1,525 meters

February 4th 2011 -

At the beginning of the shift, the TBM has reached 9,527.22 meters (31,257 feet) at an elevation of 93.97 meters (308 feet). The TBM is mining an average of 17 meters daily.

February 13th 2011 -

At the beginning of the shift, the TBM has reached 9,640.40 meters (31,628 feet) at an elevation of 93.97 meters (308 feet). The TBM has begun to ascend. The TBM is mining an average of 7-8 meters daily.

The Invert Concrete is at 6,750 meters

The Arch Concrete is at 1,675 meters

February 17th 2011 -

At the beginning of the shift, the TBM has reached 9,673 meters (31,735 feet) at an elevation of 102 meters. The TBM is mining an average of 7-8 meters daily.

February 21st 2011 -

At the beginning of the shift, the TBM has reached 9,717.78 meters (31,882 feet) at an elevation of 107.661 meters. The TBM is mining an average of 11 meters daily.

February 24th 2011 -

At the beginning of the shift, the TBM has reached 9,758.95 meters (32,017 feet) at an elevation of 110.451 meters. The TBM is mining an average of 13.7 meters daily.The TBM is currently 55.54 meters (182.25 feet) below the surface of the Niagara River.

February 26th 2011 -

At the beginning of the shift, the TBM has reached 9,790.04 meters (32,120 feet) at an elevation of 112 meters. On February 25th the TBM mined 17 meters. The TBM is mining an average of 15.6 meters daily. The TBM is currently 56 meters (183 feet) below the surface of the Niagara River.

At the current pace, the TBM will breakthrough into the existing Grout Tunnel on or about March 1st or 2nd. ** The TBM is 70 meters away from this intersection and is 353 meters from the the completion of the TBM mining.

March 1st 2011 -

At 1:15 p.m., the TBM intersected the grout tunnel at 9,845 meters (32,302 feet) at an elevation of 116.667 meters. The TBM is 52 meters (170 feet) below the surface of the Niagara River.
At 9,458 meters, the TBM will begin to ascend towards the surface at an angle of 7.150%.  At 9,846 meters, the TBM will breakthrough into the existing grout tunnel.

March 11th 2011 -

At the beginning of the shift, the TBM  is at 9951 meters (32,647 feet).

March 13th 2011 -

At the beginning of the shift, the TBM  is at 9986.44 meters (32,736 feet) at an elevation of 126.768 meters. The TBM will mark the 10,000 meters milestone during this daily shift. The TBM is 40 meters (131 feet) below the surface of the Niagara River. The TBM is 157 meters away from completion of the mining phase.

March 14th 2011 -

At the beginning of the shift, the TBM  is at 10,009 meters (32,837.5 feet) at an elevation of 127 meters. The TBM is 134.4 meters away from completion of the mining phase.

March 15th 2011 -

The TBM  is at 10,029.48 meters (32,905 feet) at an elevation of 130.008 meters. The TBM is 36 meters (118 feet) below the surface of the Niagara River and is 128 meters away from completion of the mining phase.

Rick Mercer visits Niagara Tunnel

March 20th 2011 -

The TBM  is at 10,088.54 meters (33,098 feet) at an elevation of 134.22 meters. The TBM is 33.78 meters (110.83 feet) below the surface of the Niagara River and is 70 meters away from completion of the mining phase.

March 24th 2011 -

The TBM  is at 10,136 meters (33,254 feet) at an elevation of 137 meters. The TBM has stopped mining until the official Breakthrough Ceremony in April. The TBM is 31 meters (102 feet) below the surface of the Niagara River and is 1.5 meters away from completion of the mining phase.

The Invert Concrete is at 6,900 meters.
The Restoration is at 3,450 meters.
The Arch Form is at 2,000 meters.

March 25th 2011 -

Two Strabag workers involved on the Niagara Tunnel Project were taken to hospital Friday, following an incident with a pressurized pipe that carries concrete into the tunnel, project manager Ernst Gschnitzer says. "Two workers are hurt… They are conscious. They can talk. They are, so far, OK," Gschnitzer said. The injuries weren't life-threatening and the two workers were reported to have talked to paramedics and they walked to an ambulance that attended  the site, he added. Both workers are from the Niagara area, Gschnitzer said, though he couldn't release their names. Their families had been notified of the incident. The incident took place before noon on what's known as the arch form – some equipment that's used to install a concrete lining on the top third of the tunnel. Two Strabag workers involved in the Niagara Tunnel Project were taken to hospital Friday, following an incident with a pressurized pipe that carries concrete into the tunnel, project manager Ernst Gschnitzer says. They were released from the hospital later in the afternoon and were expected to be back at work for their next shift, he said.

The incident took place before noon on what's known as the arch form -the equipment used to install a concrete lining on the top third of the tunnel. It occurred during the cleaning of that pipe. Compressed air is blown through the pipe to clear it of concrete.  "The concrete pipe was opened while it was still under pressure," Gschnitzer said.  The workers were hit with compressed air and flying chunks of wet concrete.  The sudden blast of air explained why the call was first reported to emergency crews as an explosion, he added.

Ministry of Labour investigators were called, but left the site in the afternoon. They ordered Strabag to prepare a written report on how to prevent a similar occurrence.

That work is being done a little more than two kilometres into the tunnel, whose entrance is outside the Sir Adam Beck generating stations. The two-kilometre mark would under the ground, a little bit north of Thorold Stone Road. Big Becky, the tunnel-boring machine that excavates the tunnel, has been the high-profile part of the project. It has dug its way almost to the International Control Structure. But other work is still taking place at various points throughout the tunnel.

Strabag, the Austrian company hired by Ontario Power Generation to build the tunnel, has boasted of its safety record since the project began in 2006. Friday's injuries are a setback to that record, but not a major blemish on it, Gschnitzer said. "It sets us back a little bit, but it does not have a big impact on our good safety record so far," Gschnitzer said.

Two men have been sent to hospital following an accident in the Niagara Tunnel project on Friday. The accident occurred shortly before lunch time. The two men have been transported to hospital with non-life threatening injuries.

A cement-carrying pipe at the Niagara Falls "Big Becky" tunnel construction site crashed on Friday, resulting in two workers being sent to the hospital.

Project manager Ernst Gschnitzer, of Strabag Inc., said the incident occurred shortly before lunch when the arch concrete machine which he described as a big piece of equipment spanning two kilometres in the tunnel had pressure built up in one of its pipes, causing it to collapse. Two men working below were injured in the accident and sent to hospital.

Gschnitzer said the men were conscious and talking while waiting for the ambulance. He noted that the injuries were not life-threatening. After a quick check-up, the workers returned to work with no broken bones or work-impeding injuries.

"It's good news," said Gschnitzer, who added that this incident will not affect the project's safety record. The project, which began in 2006, has a loss-time rate of 0.6 which is well below the provincial average of 1.9, Gschnitzer said. General work on the tunnel was never interrupted, but the area where the accident occurred was isolated and shut down while an investigation took place.

OPG hired the Austrian company to build a 10-kilometre tunnel about 140 metres below the city of Niagara Falls to connect the upper Niagara River to the Beck hydro generators. The $1.6-billion project is scheduled to be completed in 2013. The 14.4-metre diameter tunnel is expected to bring enough water to generate enough additional electricity to supply 160,000 homes.   - Corey Larocque Niagara Falls Review

April 3rd 2011 -

The TBM  is at 10,136 meters (33,254 feet) at an elevation of 137 meters. The TBM has stopped mining until the official Breakthrough Ceremony. Work in the tunnel continues. A ventilation bulkhead is being constructed in the tunnel behind the TBM. This is to prevent the loss of air pressure inside the tunnel following the breakthrough. Parts of the TBM that are unnecessary for the final breakthrough continue to be dismantled and removed.

April 7th 2011 -

OPG has stated in a media release issued today that the date of the final break-out of the 14.4 meter diameter TBM named "Big Becky" will occur on Friday May 13th 2011. The TBM  remains at 10,136 meters (33,254 feet) at an elevation of 137 meters. This finale will bring to an official end the mining phase of the Niagara Tunnel Project construction. The breakout will occur at 10,143.026 meters. The final push will be 1.5 meters

The tunnel ends at Station 10143 meters at the Intake Structure, a few meters have been excavated by drill and blast. Difference between 10143 meters and 10158 meters is due to the alignment change. Final push is about 1.5 meters.

May 2nd 2011 -

The Official Breakthrough Ceremony of the TBM will take place on Friday May 13th 2011 beginning at 11 a.m. Work continues within the tunnel unabated. The Arch Form has poured 12.5 meters every single day for the past 40 days (advancing 500 meters). Work continues tearing down unnecessary parts of the TBM, conveyor system and support bridges. Although much focus is currently on the TBM ceremony marking the completion of the mining phase of the Niagara Tunnel Project, much major and no less important work continues on a 24/7 basis of many other processes of the tunnel construction including the Invert Concrete, Restoration, Arch Form and Grouting.

May 9th 2011 -

MEDIA ADVISORY - NIAGARA TUNNEL EVENT - BIG BECKY BREAKTHROUGH - issued by Ontario Power Generation

TORONTO, May 9 /CNW/ - The Niagara Tunnel Project will hit an important milestone May 13, 2011 when Big Becky, the world's largest hard rock tunnel boring machine "breaks through" to daylight after a 10.2 Km journey beneath Niagara Falls, Ontario.

When completed in 2013 the Niagara Tunnel will increase the output at Ontario Power Generation's Sir Adam Beck Generating Station and provide clean, renewable energy for an additional 160,000 Ontario homes.

The tunnel mining is a major component of the project and tunnel mining tradition calls for a celebration when the mining is completed.

EVENT DETAILS

WHAT: Big Becky Breakthrough at Niagara Tunnel Project.
WHEN: May 13 - media should arrive at 10:00 a.m. Event starts at 11:00 am-
Breakthrough estimated for 11:30 am.
WHERE: Media Parking: 200 m east of intersection of Upper Rapids Blvd. and Niagara Parkway, Niagara Falls, Ontario

NOTE: Accredited media must pre-register with OPG Media Relations - MEDIA@OPG.COM

Because of safety regulations media cannot enter the area of the breakthrough. Images will be available on a live satellite feed. Still photos will be available shortly after the event. Contact OPG for B-roll and stock images.

Learn more about the tunnel at: www.opg.com/power/hydro/new_projects/ntp/index.asp

Public can watch the event live at www.opg.com

May 13th 2011 -

The TBM affectionately known as "BIG BECKY" officially completed the mining phase of the Niagara Tunnel Project at approximately 12:34 p.m. when the ceremonial breaking through the outer portal of the Grout Tunnel before a large number of government politicians, company executives, workers, media and other invited guests. The breakout occurred at 10,143.026 meters.

The Moment of TBM Breakthrough - May 13th 2011  The Celebration of Workers
The Moment of Breakthrough and the Celebration of the Workers

TBM Final Breakout
Niagara Tunnel Project
May 13th 2011
(courtesy of OPG)

May 26th 2011 -

The Concrete Arch lining has reached 2800 meters. Disassembly of the TBM cutterhead is scheduled to begin in approximately 10 days.

May 29th 2011 -

Workers are in the process of loosening the bolts of the TBM cutterhead. When ready, (July 2011) a large hydraulic platform will be assembled in the intake channel cut. This platform will be used to receive each the six segments (one at a time) that make up the cutterhead. The platform will then move into an open area where the segment will be lifted to the surface by a crane. It is expected that the disassembled segments of the cutterhead will remain on site until a decision is made as to whether or not it will be reassembled in an area yet to be determined as a monument to the Niagara Tunnel Project legacy.

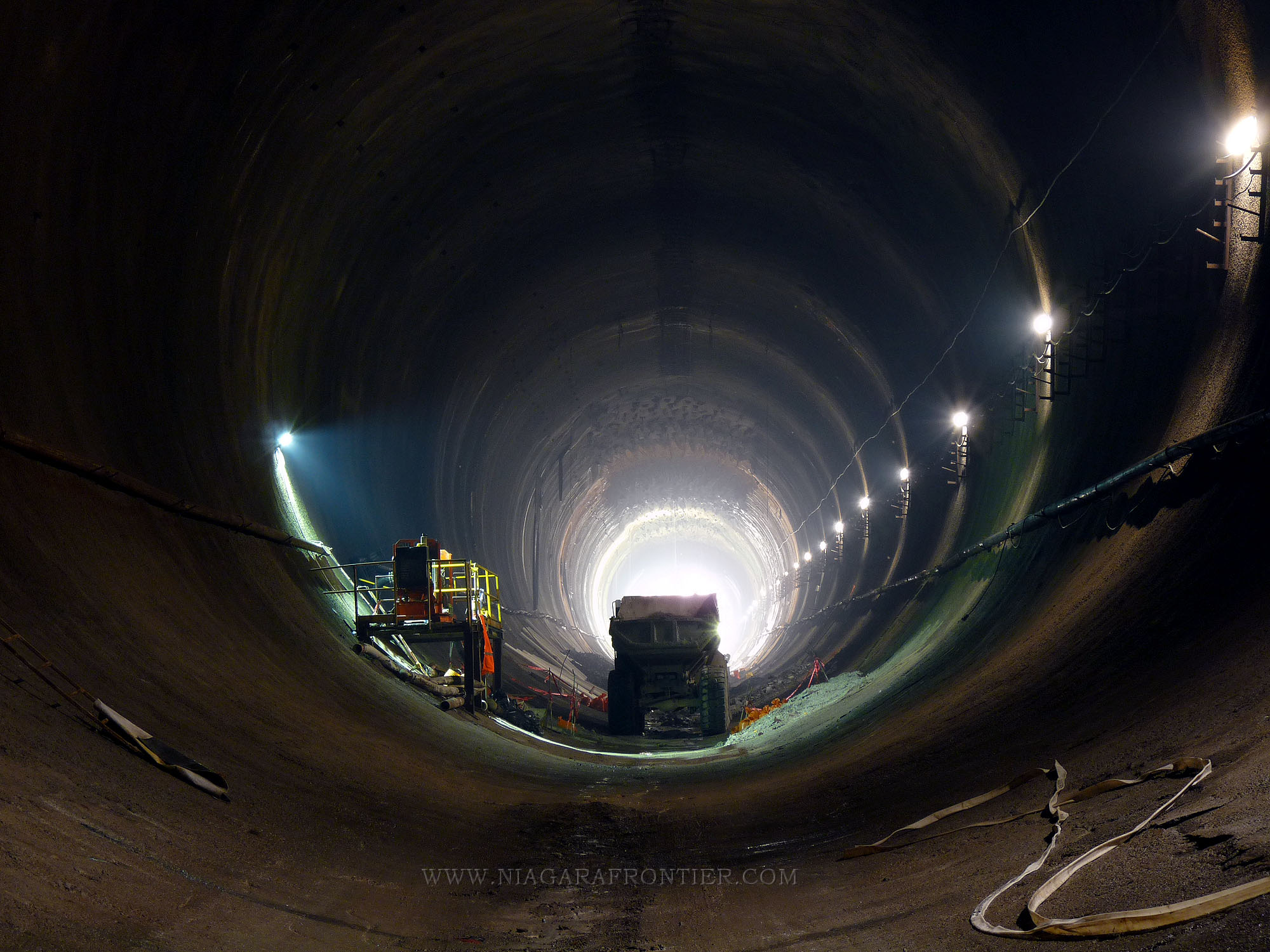

June 7th 2011 -

The Invert Concrete is in excess of 7,000 meters. The Arch Concrete continues pouring one bay (12.5 meters) per day.

June 26th 2011 -

Construction within the tunnel has continued unabated. Crews continue to dismantle parts of the TBM train that are now redundant. The parts are being placed onto flatbed trailers and moved to a location within the tunnel pending shipment out the tunnel's outlet portal. The cutterhead continues to be prepared for disassembly in the near future.

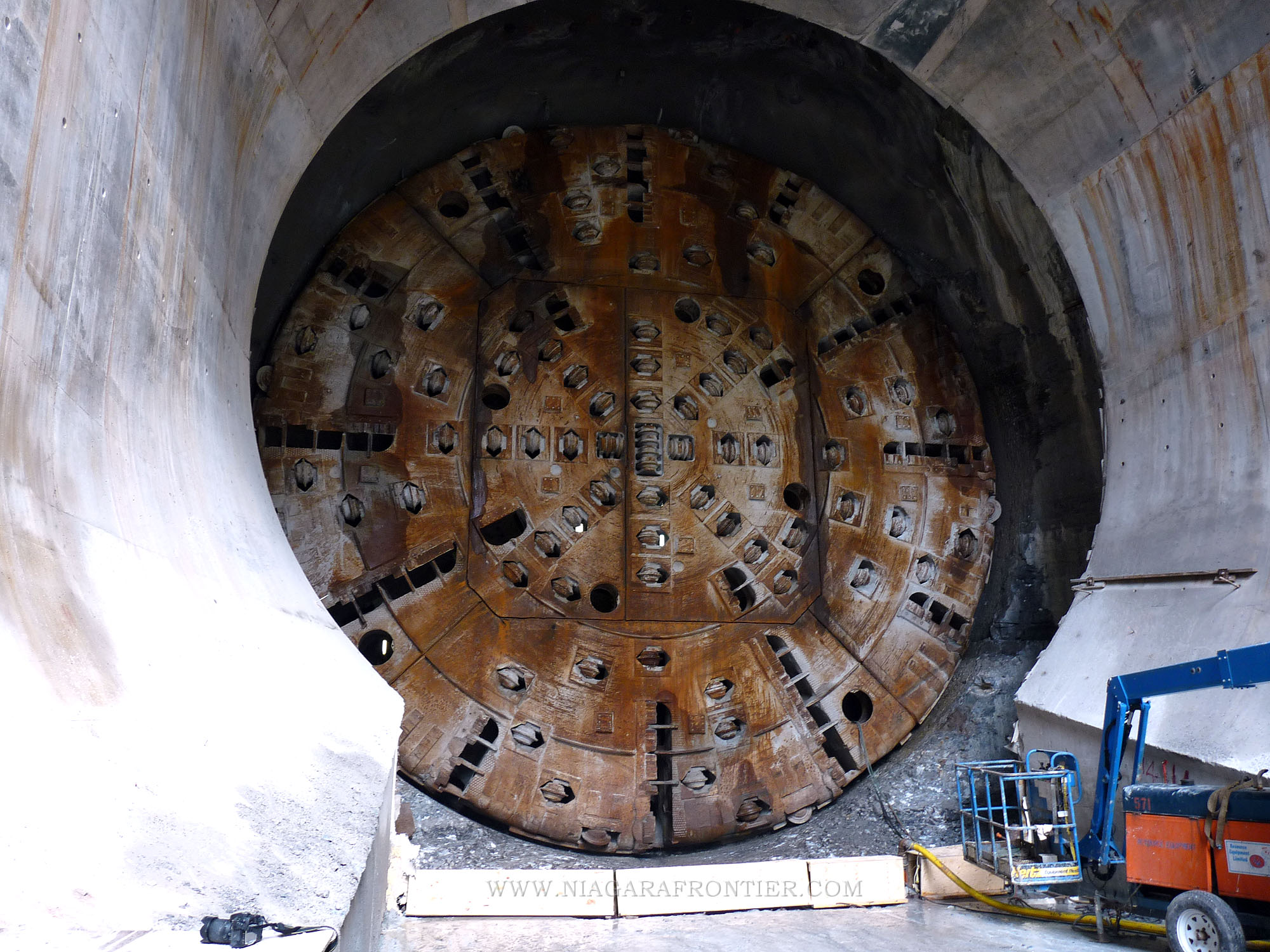

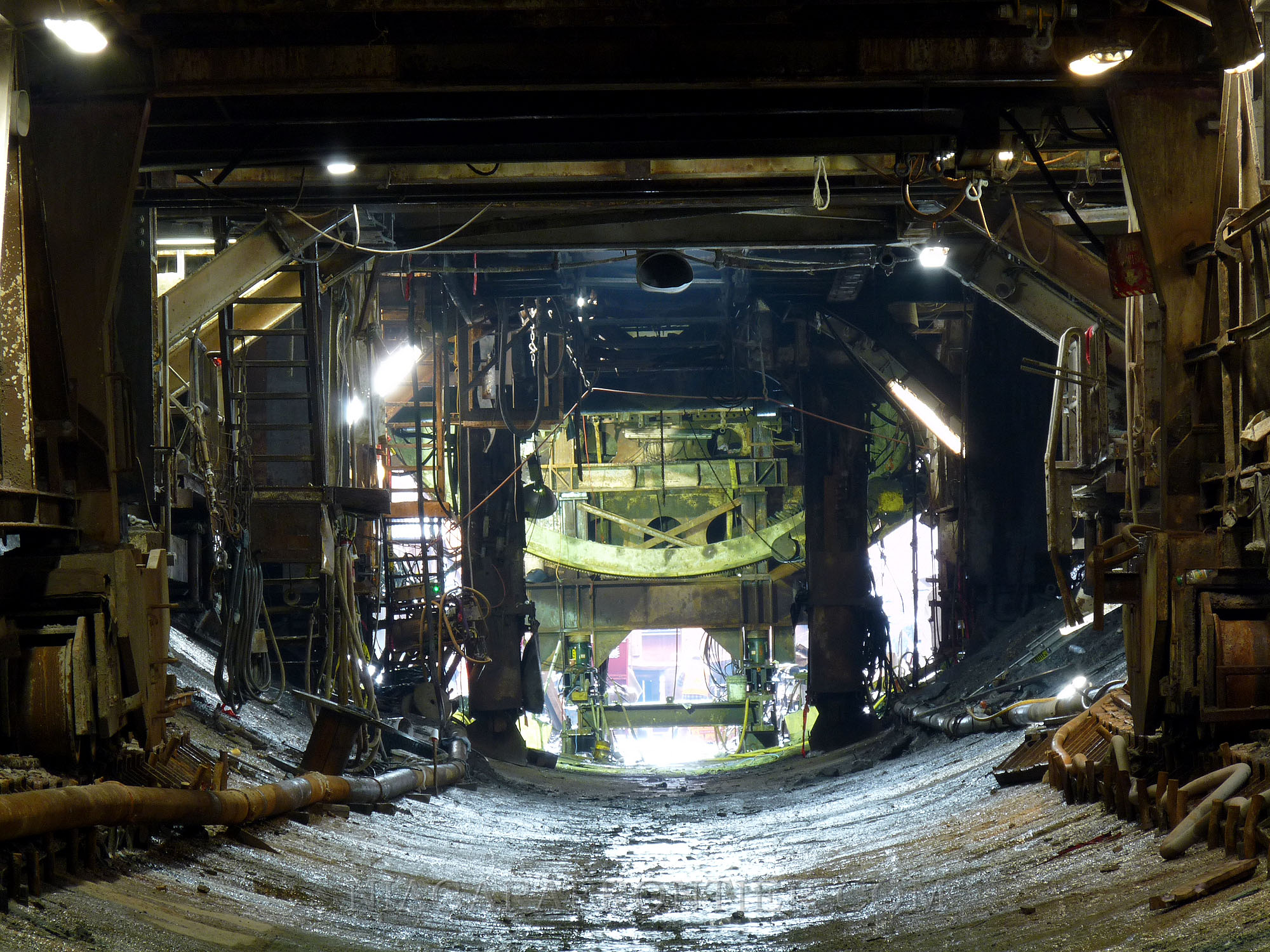

The TBM Cutterhead at the Intake Cut - June 26th 2011

The TBM  Cutter-head awaiting disassembly - June 26th 2011

The TBM - May 29th 2011

July 2nd 2011 -

A  "Fall of Ground" occurred within the Niagara Tunnel on Saturday July 2nd 2011 between 10 a.m. and 11 a.m. Forty to fifty cubic metres of rock fell from the roof of the Niagara Tunnel.  Project manager Ernst Gschnitzer said it happened in a "problematic area" about six kilometres into the 10.2-kilometre tunnel. Nobody was injured.

"The area is secured and we are in the process of restoring, or gearing up for restoring, the area," said Gschnitzer, of Strabag AG, the Austrian company hired by Ontario Power Generation to build the tunnel. "It happened already a while ago in another zone of the tunnel. It is an area that we have already monitored."
- Niagara Falls Review

The TBM mined the area of the tunnel at 6,000 Meters at an elevation of 91.729 meters in February of 2010.

This is the second such occurrence that has occurred.

The first "Fall of Ground" fell from the crown of the tunnel on September 11th 2009.  The partial collapse came just as the TBM was moving into more competent ground and achieving higher progress rates. About 25m3 (100 tonnes) of temporary lining and Queenston Shale fell from the crown. According to the owner, Ontario Power Generation, no one was injured in the collapse and all of the workers left the tunnel safely, following established emergency procedures. The fall occurred about 2 km (1.2 miles) behind the TBM, and some 3,600 meters (2.2 miles) into the 10 kilometer (6.2 mile) long ,14.4 meter (47ft) diameter tunnel, in an area that experienced some of the most severe over-break to date.

July 5th 2011 -

Arch Form is at 3,362.5 meters.
Restoration Carrier is at 4,474 meters.
Invert Concrete is at 7,625 meters.

All activities from the outlet to 5,500 meters are continuing normally.

The TBM - May 29th 2011

July 17th 2011 -

Arch Form is at 3,375 meters. Two bays per day are now being poured (25m). Overbreak Restoration Carrier is at 4,558 meters. The Grouting Carrier that is part of the overbreak restoration process is at 3,900 meters.

The TBM dismantling has begun and the cutter-head is expected to begin being dismantled during the next week.  The outlet structure is being prepared for concrete pouring in August.

The Pre-stress Contact Grouting Carrier and associated platforms have been moved into the tunnel.

July 25th 2011 -

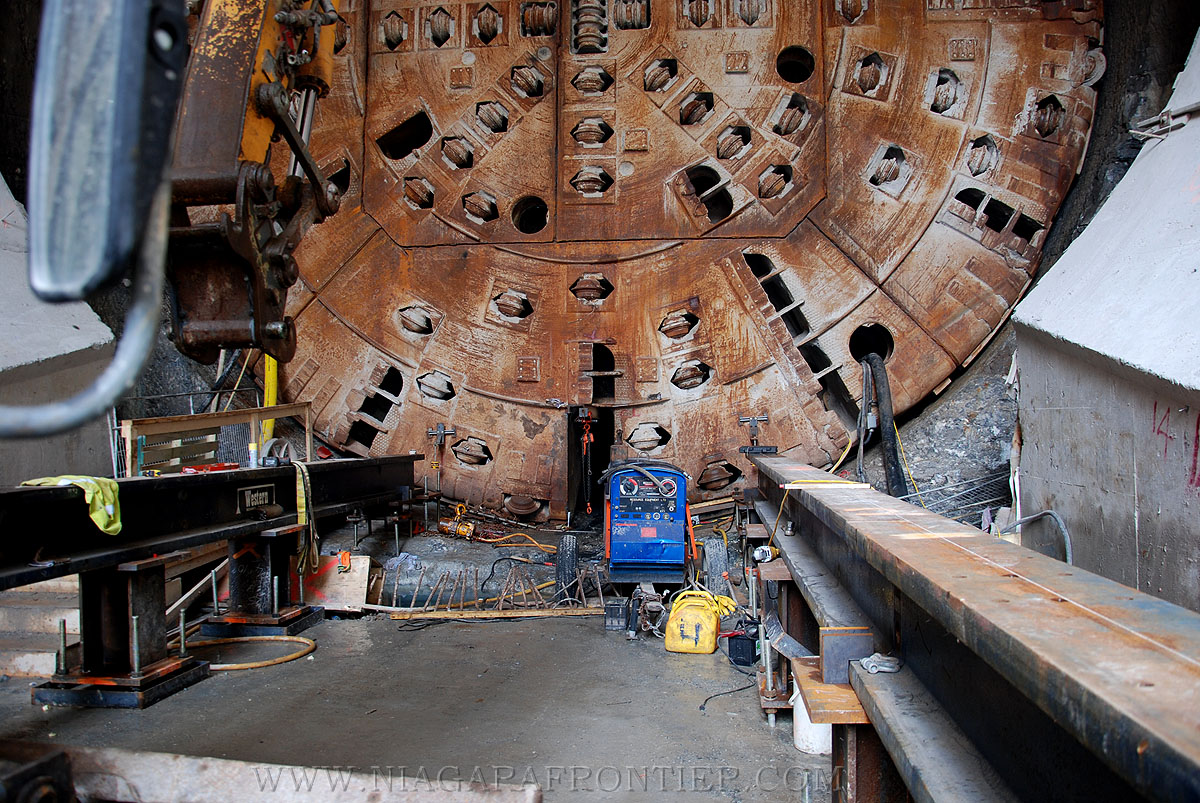

Work at the intake continues. Crews have cut the outside welds of the cutterhead in preparation for disassembly. They are currently erecting a rail system that will be utilized to begin the cutterhead removal in the near future.

Arch Form is at 3,437.5 meters. Pouring one bay per day.
Restoration Carrier is at 4,730 meters.
Invert Concrete is at 7,625 meters (stopped pending "fall of ground" repair)

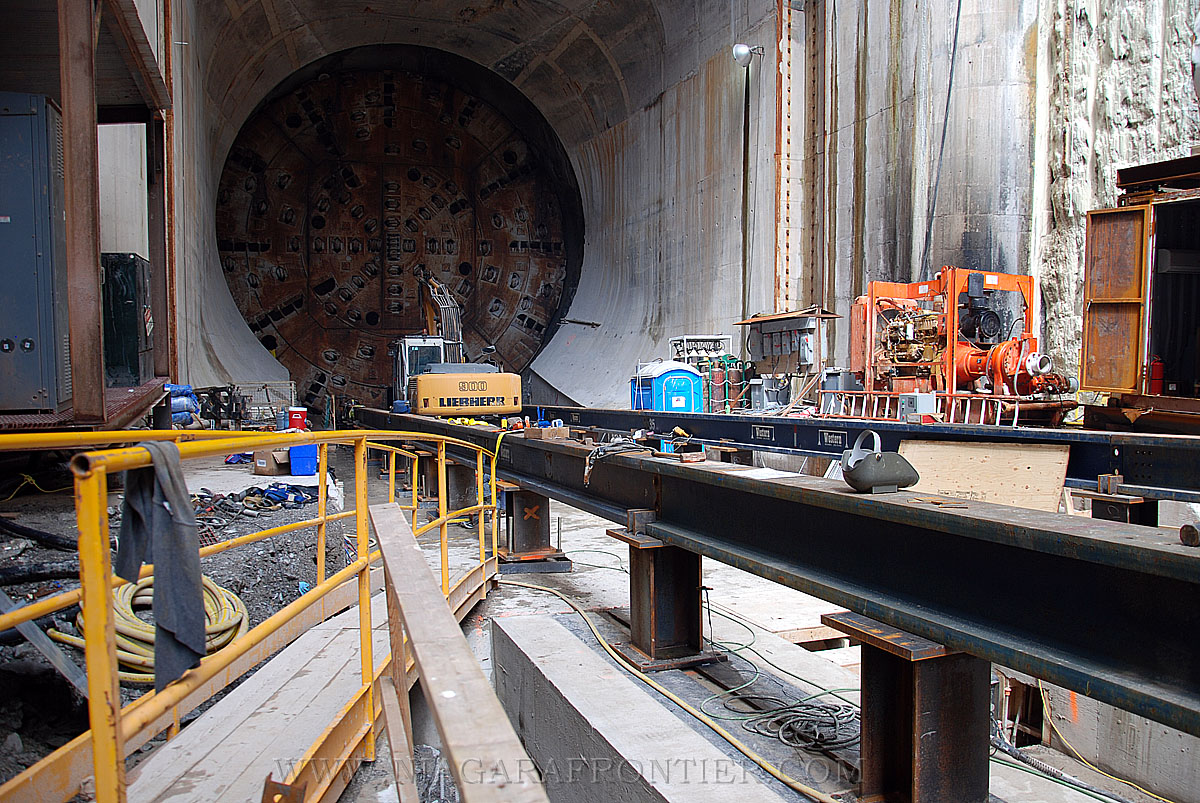

Laying track at the Intake - July 24th 2011

August 2nd 2011 -

Arch Form is at 3,500.0 meters.
Restoration Carrier is at 4,930.0 meters.
Invert Concrete is at 7,625 meters.

August 7th 2011 -

The carrier to be utilized to remove the cutterhead has been erected at the intake and is being welded in place against the first section to be removed. Once ready the bolts holding that section of the cutterhead will be cut and the carrier will bear the full weight of the section. The carrier will lower the section and move it to an open area where it will be hoisted to the surface by crane.

Intake - August 7th 2011

August 14th 2011 -

Arch Form is at 3,662.5 meters.
Restoration Carrier is at 5,095.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stress grouting bay 67-64

August 16th 2011 -

The first section of the cutterhead weighing approximately 75 tonnes was removed from the TBM on Monday August 15th and is resting on the carrier that will allow it to be lifted to the surface in several days using a 300 ton crane. The section was separated from the remaining cutterhead and lowered by the carriage to clear the roofline of the intake structure before being rolled backward into an area where it can be lifted to the surface. The process takes approximately 3 hours.

Cutterhead Section  Resting on Carriage
Intake Channel - August 18th 2011

August 18th 2011 -

The first section of the cutterhead weighing approximately 75 tonnes is expected to be hoisted to the surface on Monday August 22nd by two surface cranes working in tandem. The primary crane has a lift capacity of 300 tons and the second crane will have the lift capacity of 200 tons.

August 21st 2011 -

Arch Form is at 3,775.0 meters. One bay per day.
Restoration Carrier is at 5,165.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stress grouting bay 66-64

What Goes Down - Must Come Up

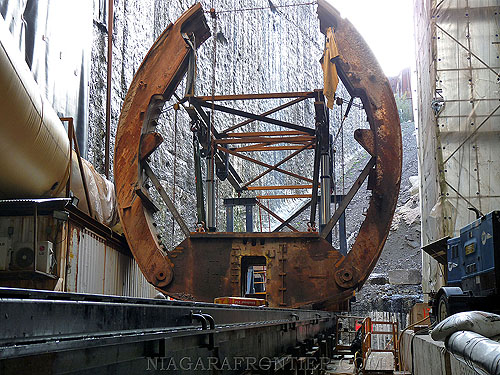

Lift of first section of Cutterhead
Intake Channel - August 23rd 2011

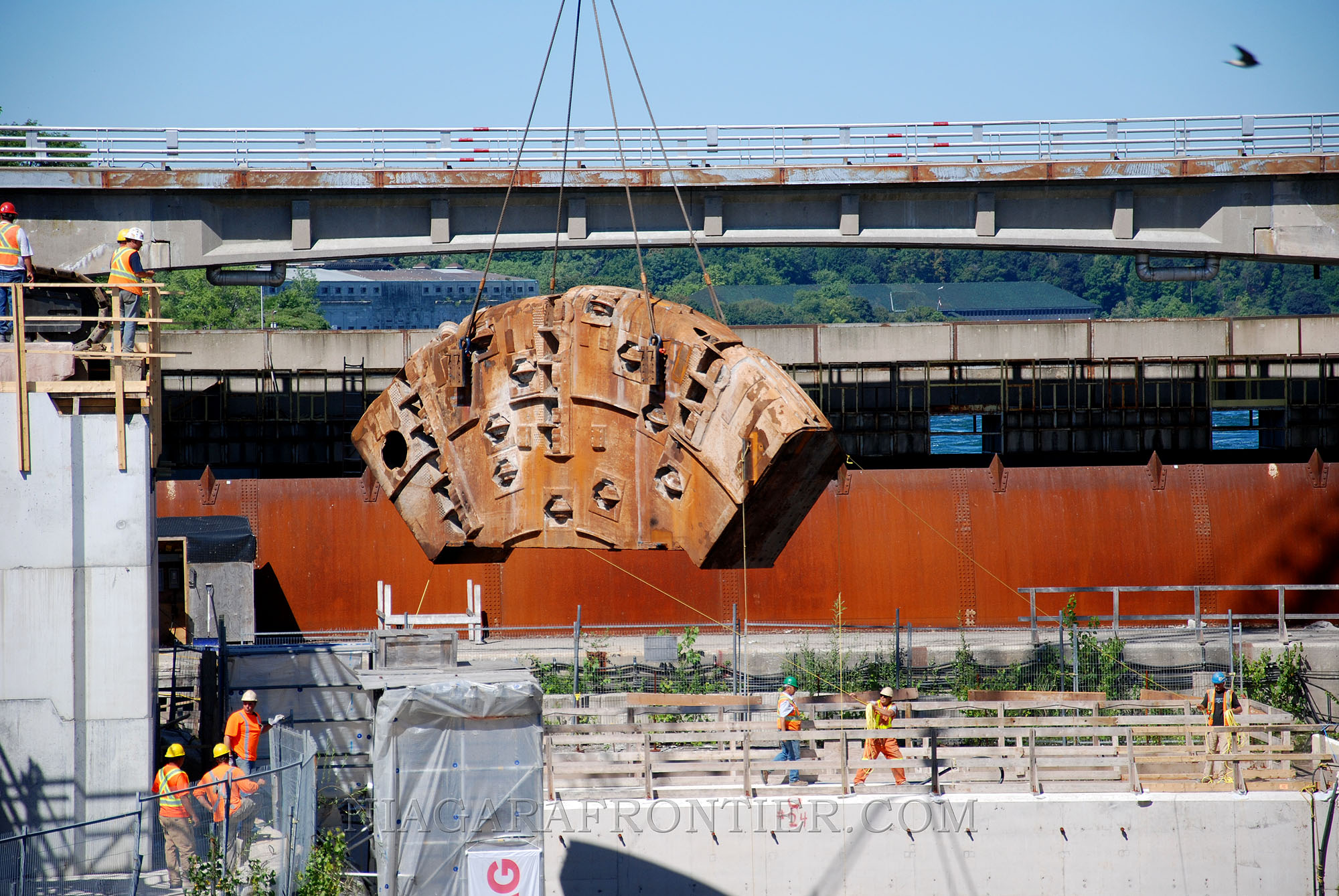

August 23rd 2011 -

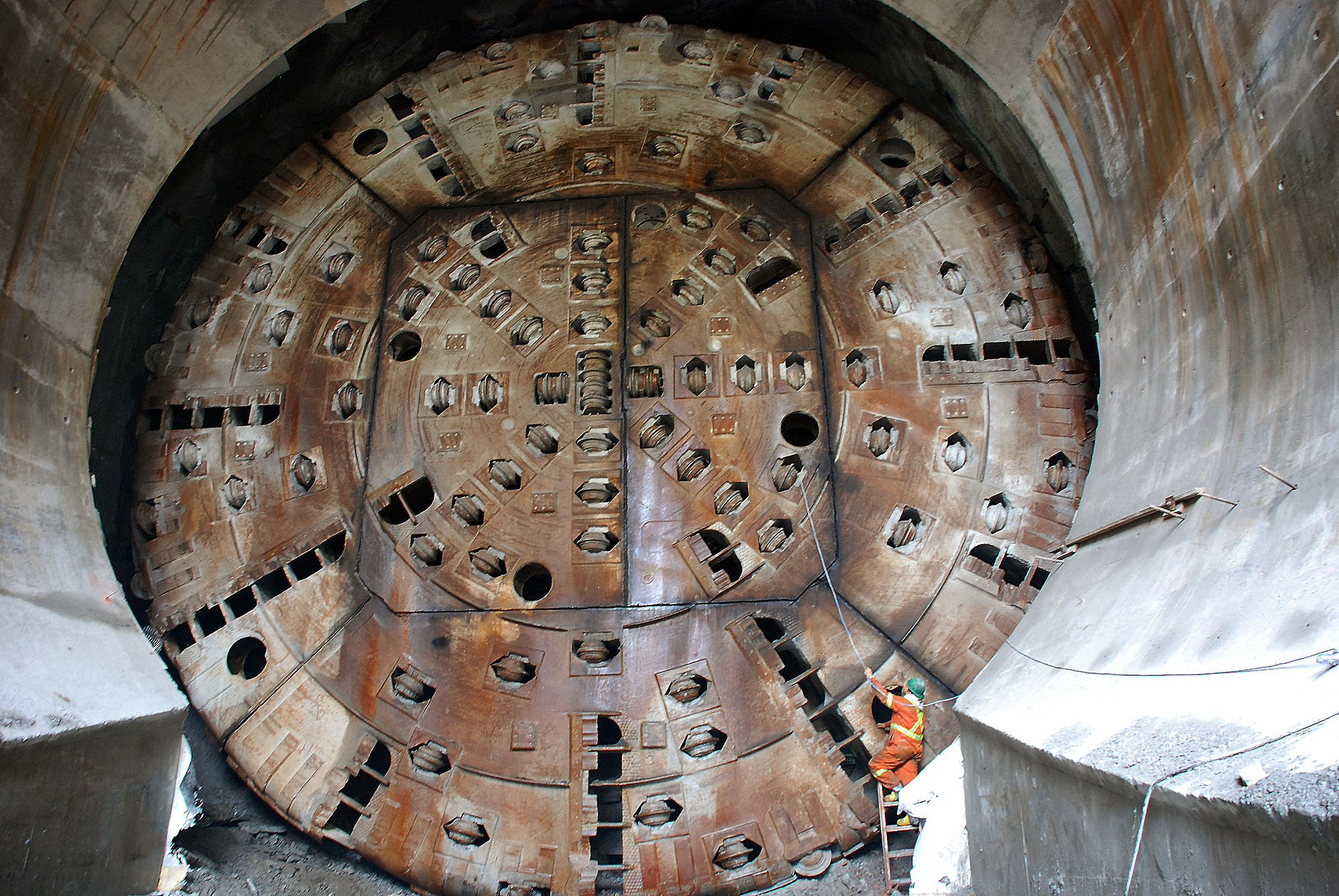

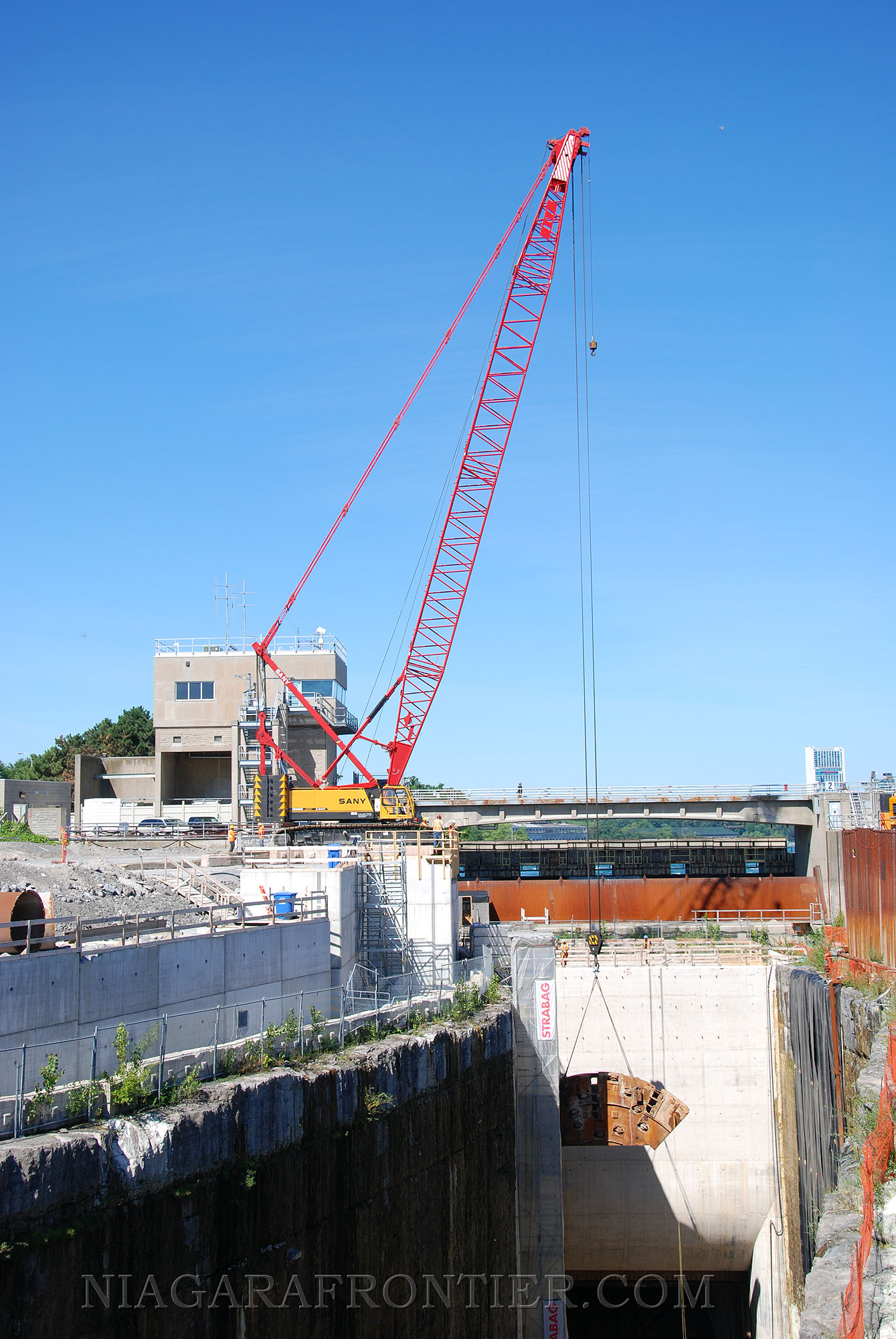

The first section of the cutterhead weighing approximately 75 metric tonnes was hoisted to the surface from the base of the Intake channel. The 6 hour process went flawlessly. Both cranes were utilized to lower the cutterhead to the base of the intake channel before being shifted closer to the primary 300 ton crane. Once this was undertaken the 300 ton crane performed the solo lift of the section to the surface. The consulting engineer for the lift was Joseph Ha of St. Catharines, Ontario.

Arch Form is at 3,775.0 meters. One bay per day.
Restoration Carrier is at 5,165.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stress grouting bay 66-64

August 28th 2011 -

Arch Form is at 3,825.0 meters. One bay per day.
Restoration Carrier is at 5,190.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stress grouting completed to bay 54

August 29th 2011 -

The second section of the cutterhead weighing 75 metric tonnes was hoisted to the surface from the base of the Intake channel.

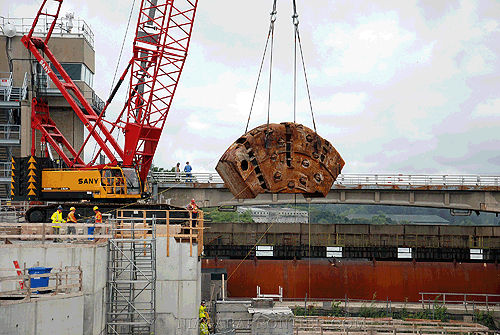

Lift of third section of Cutterhead
Intake Channel - September 6th 2011

September 6th 2011 -

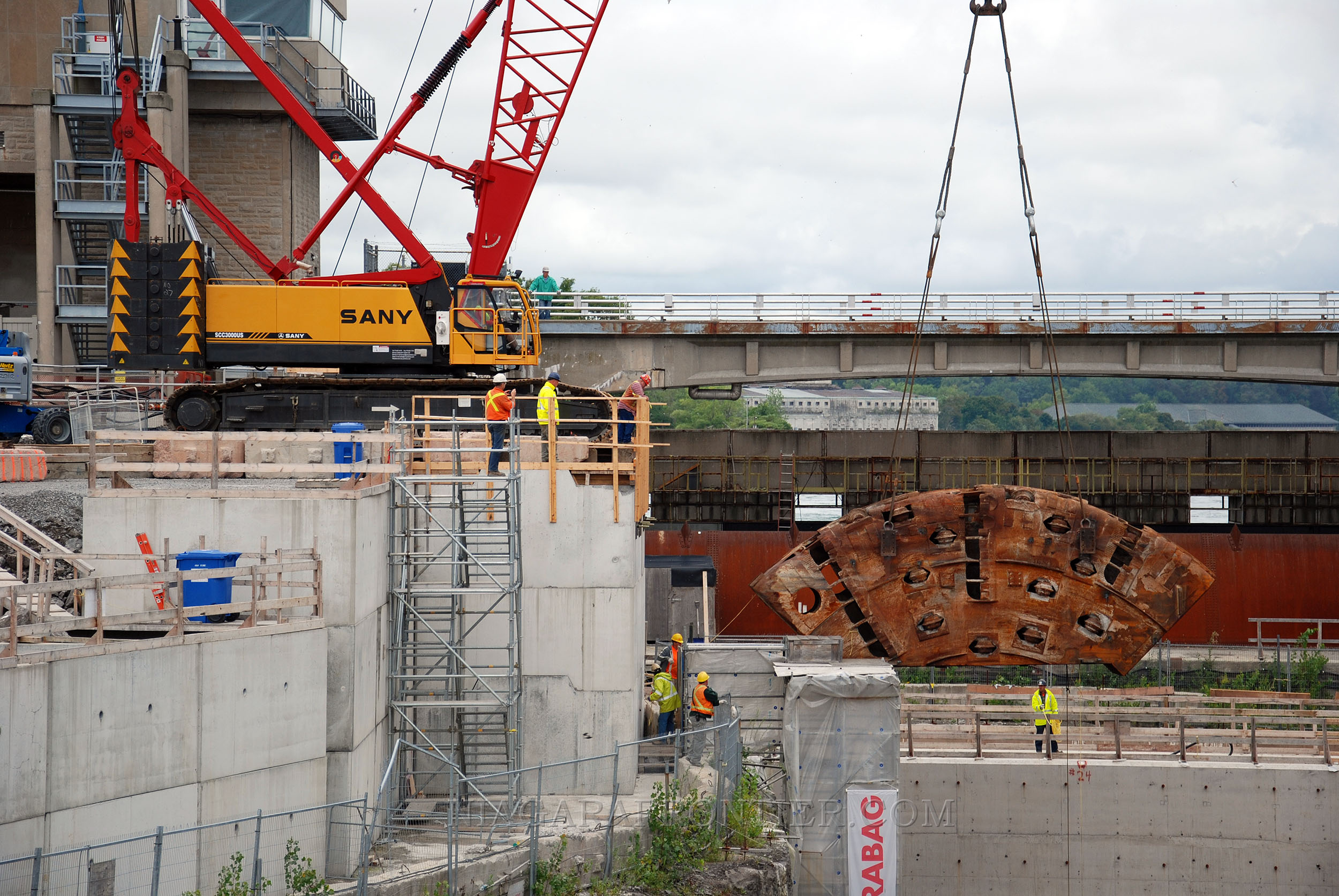

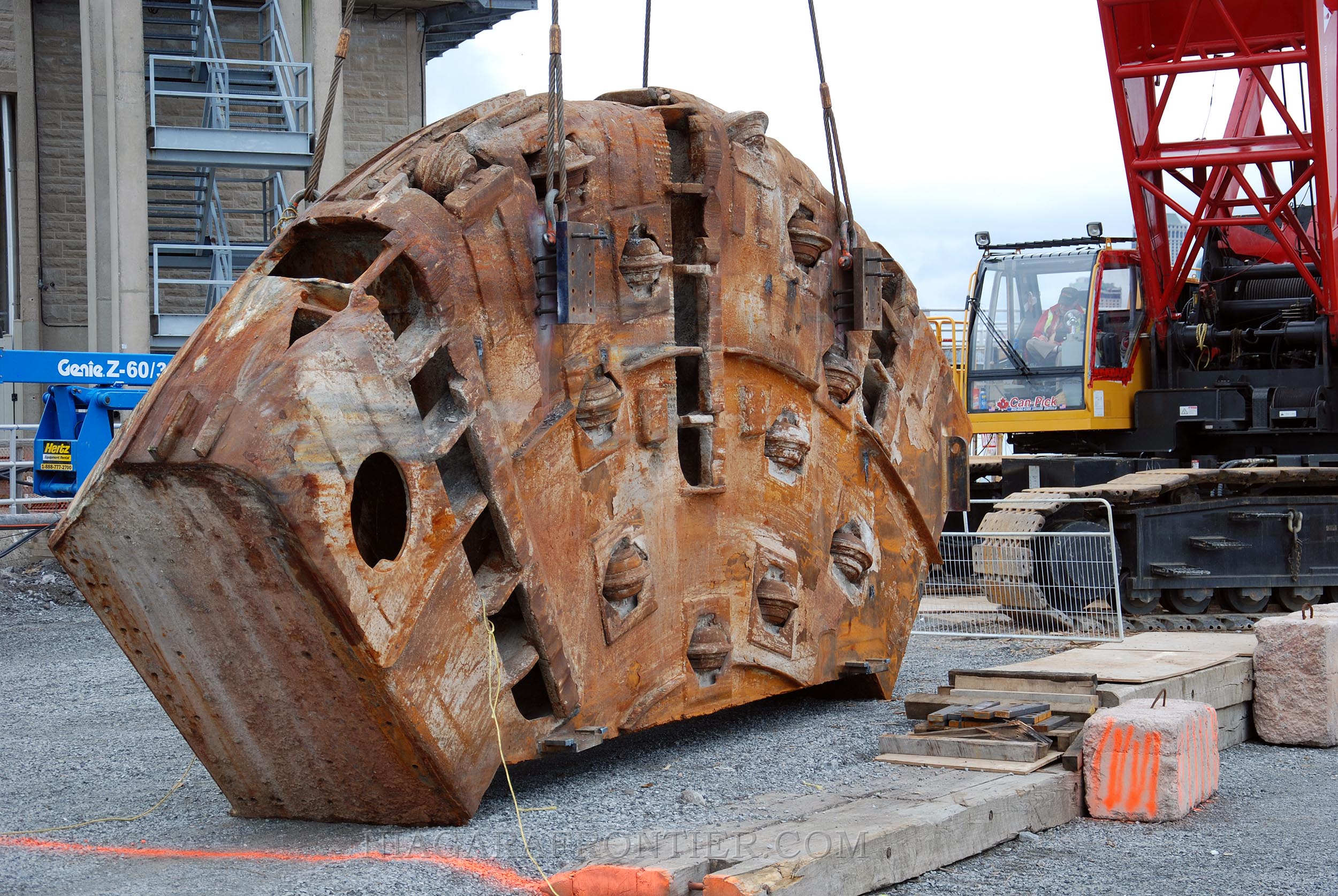

The third section of the cutterhead weighing 75 metric tons was hoisted to the surface from the base of the Intake channel.

The fourth section of Cutterhead being prepared to be lifted to the surface
Intake Channel - September 17th 2011

September 17th 2011 -

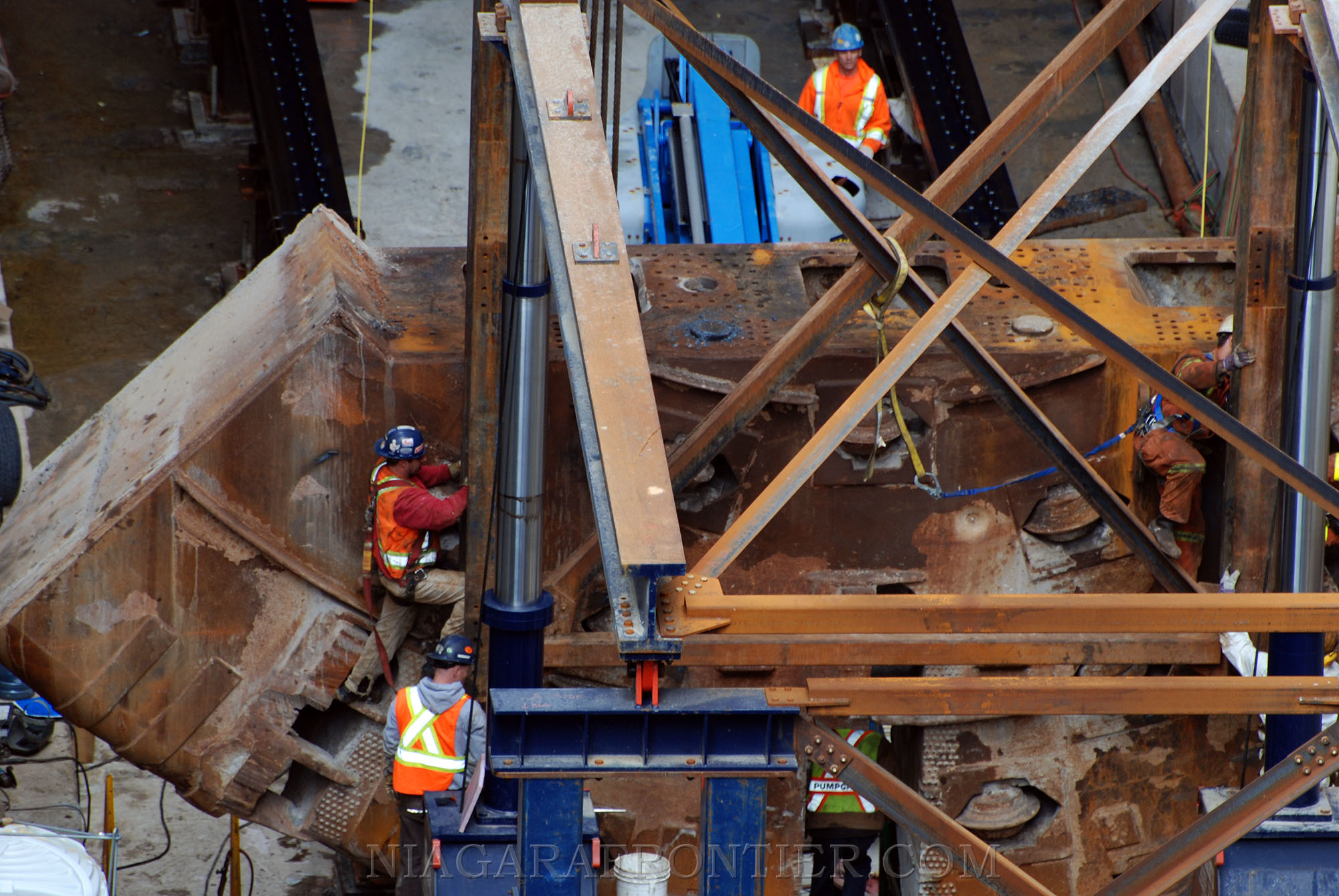

The fourth section of the cutterhead was hoisted to the surface from the base of the Intake channel.

September 25th 2011 -

Arch Form is at 4,100.0 meters.
Restoration Carrier is at 5,190.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stressed grouting up to bay #50. Filling phase completed up to bay #31

A 550 ton crane will be utilized at the intake channel in November for the lifting the the main beam of the TBM.

October 23rd 2011 -

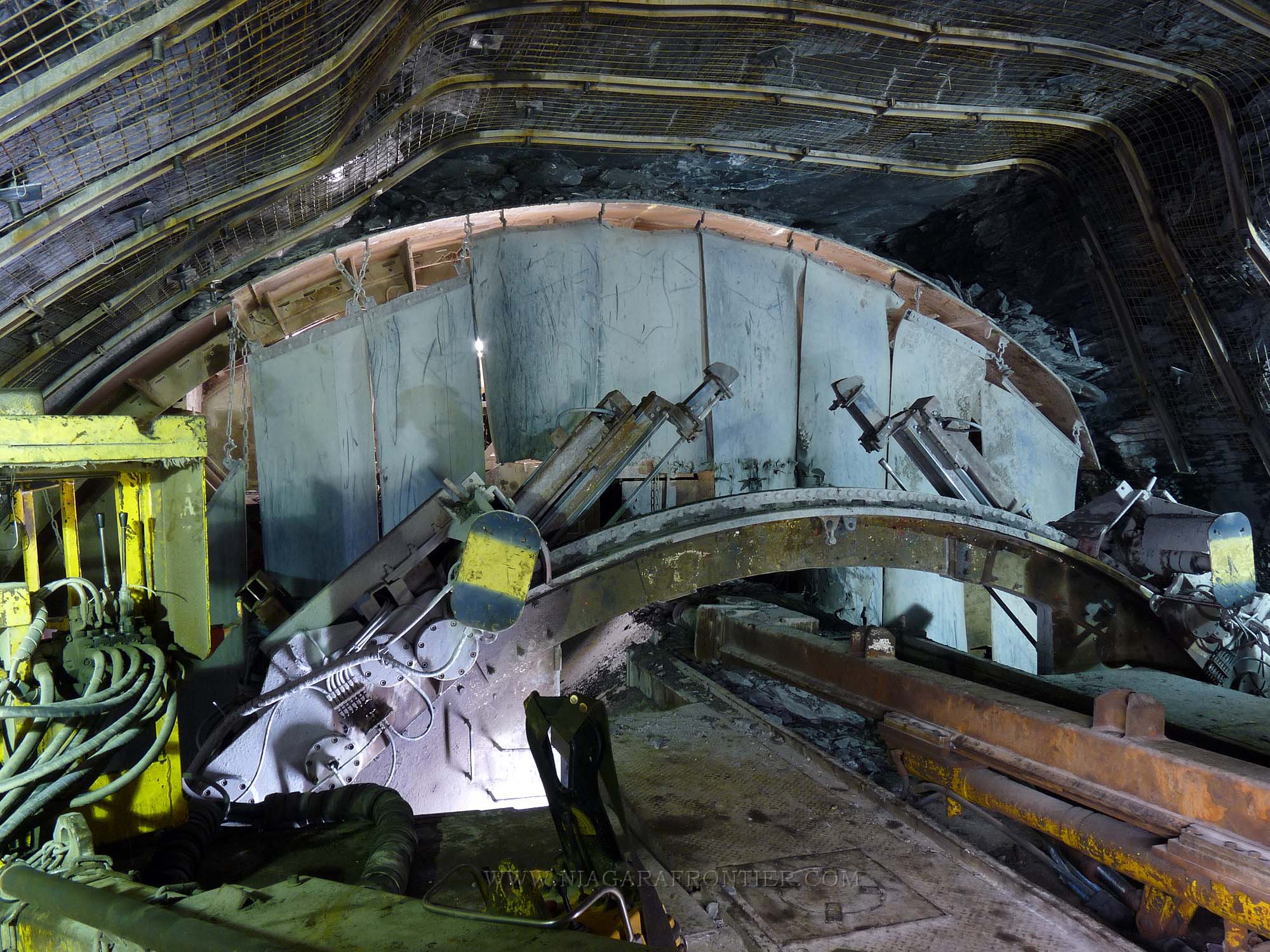

The cutterhead "shoe" weighing approximately 330 tons (pictured below) has been moved into the open area at the bottom of the intake channel awaiting the arrival of a 600 ton crane that will lift it and the TBM main beam to the surface.

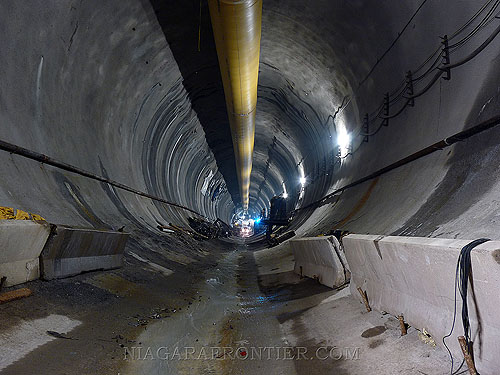

Intake Channel and Tunnel - October 23rd 2011

October 30th 2011 -

Arch Form is at 4,473.5 meters.
Restoration Carrier is at 5,190.0 meters.
Invert Concrete is at 7,625 meters.
Grouting Operation - Pre-stressed grouting up to bay #13. Filling phase completed up to bay #06

November 6th 2011 -

The 550 ton crane is onsite at the outlet location and is being erected in order to lift the remainder of the conveyor bridge crossing the existing hydro canal. When finished it will be moved to the intake location.

Workmen continue the disassembly of the TBM. The gigantic grippers are being prepared to be removed in order that the main beam of the TBM can be walked out of the tunnel on a rail bed before being lifted to the surface.

Remedial work on the "Fall of Ground" continues from the intake and outlet sides of the tunnel.

November 15th 2011 -

The 550 ton crane has completed the lift of the conveyor bridge (approximately 85 meters long - 4 meters wide).

Preparing to lift the remnants of the conveyor bridge at the outlet - November 14th 2011

November 17th 2011 -

Sections for the boom of the 550 ton crane have begun arriving at the intake site.

November 18th 2011 -

Ontario Power Generation Inc. (“OPG” or the “Company”) reported its financial and operating results for third quarter of 2011 ending September 30th.  Net loss for the third quarter of 2011 was $96 million compared to a net income of $333 million dollars for the third quarter of 2010. Net income for the nine months ended

September 30, 2011 was $169 million compared to $447 million for the same period in 2010. As at September 30, 2011, OPG’s long-term debt outstanding with the OEFC was $3.9 billion dollars (actual $4.743 billion dollars).

The tunnel boring machine mining activity has been completed, and the disassembly of the tunnel boring machine is in progress. Lining installation activities at the Niagara Tunnel continue. Installation of the lower one-third of the permanent concrete lining had reached 7,625 metres by July 2, 2011 when this work was temporarily interrupted to do reinforcement repair work in the 6,050 metre area of the tunnel. This lining work is expected to resume in January 2012. All other tunnel lining activities are continuing. As at September 30, 2011, the life-to-date capital expenditures were $1.1 billion. The project is expected to be completed within the approved budget of $1.6 billion and the approved project completion date of December 2013.

November 25th 2011 -

The 550 ton crane has completed the lift of the 317 ton shoe from the base of the intake channel at approximately 11:30 a.m.

November 14th 2011 -

On July 2nd, a "fall of ground" took place at 6,050 meters, effectively cutting the tunnel into two sections: the outlet side and the inlet side.

Work has continued unabated to repair the area of the fall of ground. It has been taking place within each section of the tunnel simultaneously. By luck, a crew bus was stranded in the intake section of the tunnel behind the TBM, allowing crews to be shuttled the nearly 4 kilometers to the rock fall zone. Unfortunately, the crew bus on the intake side became totally disabled. This caused Strabag a major logistical problem. It needed a replacement bus however the remainder of the main-beam and cutterhead of the TBM at the mouth of the intake side of the tunnel precluded the ability to just lower another mini sized crew bus into the intake channel floor and be driving directly into the tunnel unobstructed.

Using perhaps modern engineering adaptation at its best, Strabag did what one could consider most unorthodox but quite unique and innovative. During the week of November 14th, they took a replacement crew bus and cut the roof off the bus. The bus was now in two pieces. The chassis portion of the bus was lowered to the bottom of the intake channel. Now with sufficient clearance the bus chassis was driven underneath the existing cutterhead and main-beam. Once inside the tunnel, the bus chassis and roof were again welded together. A crew bus is again in service on the intake side of the Niagara Tunnel.

December 4th 2011 -

Arch Form is at 4,786.5 meters.
Restoration Carrier is at 5,425.0 meters.
Invert Concrete is at 7,625 meters.
Contact Grouting is at 2,450 meters.
Interface Grouting is 912.5 meters to 820.8 meters. (Grouting process begins at lowest point of tunnel)

December 6th 2011 -

The final segment of the cutterhead was lifted from the base of the intake channel to the surface.

December 8th 2011 -

The 158.5 ton (317,000 lbs) 'shoe' is removed from the intake channel work site on a specialized remote controlled flatbed vehicle by Western Mechanical. The load was transported to the yard on the opposite side of the road. In the meantime, preparations are being made to remove the mainbeam of the TBM.

Intake Channel - December 8th 2011

December 29th 2011 -

The 220 ton (440,000 lbs) main bearing of the TBM was lifted by crane from the base of the intake channel to the surface. The 190 ton (380,000 lbs) main frame will be lifted to the surface in early 2012.

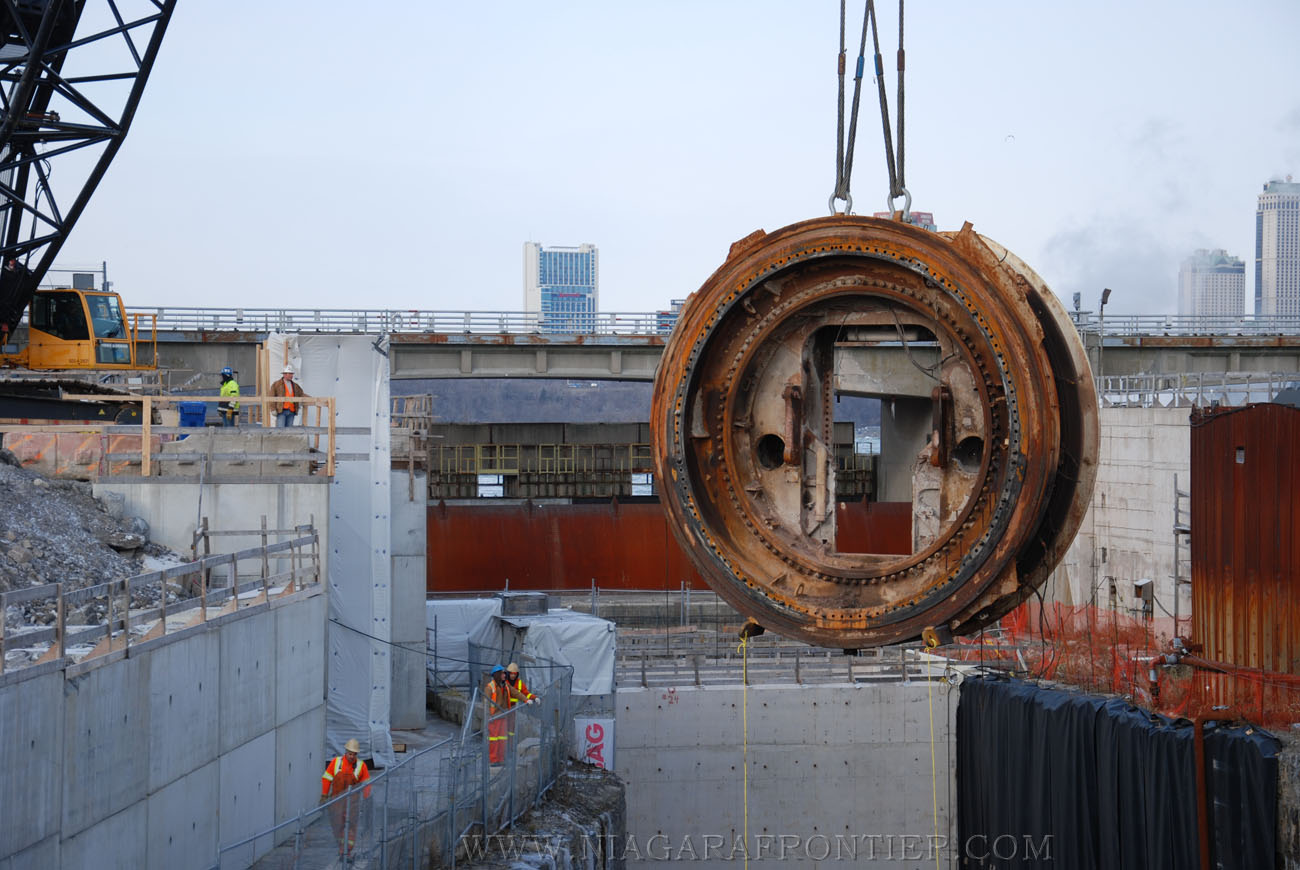

TBM Main Bearing     TBM Main Frame
Intake Channel - December 29th 2011

December 30th 2011 -

The 220 ton (440,000 lbs) main bearing of the TBM was transported from the intake channel work site on two specialized remote controlled flatbed vehicles by Western Mechanical. The main bearing (the heaviest load to date) was transported to the yard on the opposite side of the road utilized two $1 million dollar remote flatbed hydraulic vehicles built in Germany for this tunnel project. The vehicles can carry a maximum weight of up to 400 tons.

January 5th 2012 -

The 225.5 ton (451,000 lbs) main frame of the TBM was lifted by crane from the base of the intake channel to the surface.

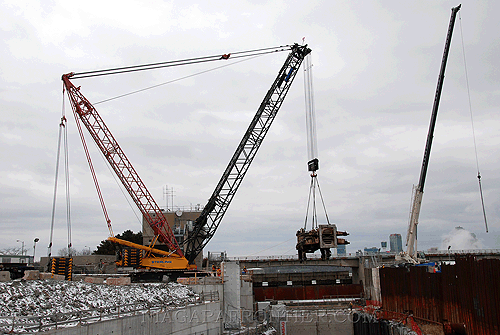

Lifting the TBM Main Frame - 225 tons     Lifting the TBM Main Frame - 451,000 pounds

January 12th 2012 -

Arch Form is at 5,111.5 meters.
Restoration Carrier is at 5,712.0 meters.
Invert Concrete is at 7,625 meters. (had been suspended since July 2nd 2011 as a result of "fall of ground". Work to resume in early February 2012)
Contact Grouting is at 2,637.0 meters.
Interface Grouting is 1137.5 meters. Filling phase completed up to 1000.0 meters

Access through the entire length of the tunnel is back in operation.

The two specialized remote controlled flatbed vehicles operated by Western Mechanical will be lowered into the intake channel and will be instrumental in the removal of the remaining TBM support vehicle sections from within the tunnel.

January 29th 2012 -

Arch Form is at 5,187.0 meters.
Restoration Carrier is at 5,849.0 meters.
Invert Concrete is at 7,625 meters. (had been suspended since July 2nd 2011 as a result of "fall of ground". Work to resume in early February 2012)
Contact Grouting is at 3,037.0 meters.
Interface Grouting is 1,250.0 meters.

* all depth (elevation) measurements are based upon "above sea level"

TUNNEL INTAKE

Construction of the rock-pit at the intake of the Niagara Tunnel Project nears completion
The rock-pit at the base of the intake tunnel entrance is nearing completion - July 7th 2009

The Niagara Tunnel Boring Machine (TBM) will approach the water intake at the International Water Control Dam in a line of approach that follows a path to the river which differs from the existing tunnels (under Dufferin Islands and Rapids Drive).

The TBM will reach the Niagara River by following a path from the Fallsview tourist district and under Niagara Parks Commission land between the east of the Canadian Niagara Power Station and  west of the former Toronto Power Station reaching the river west of Dufferin Islands.

The intake complex will consist of a submerged bell-mouth structure in the Niagara River beneath gate #1 of the existing International Water Control Dam and an underwater approach channel excavated in the riverbed. The intake structure will include a portal with space for sectional gates (stop-blocks) for closure of the tunnel when the need to dewater the tunnel is required. The existing weir of the ice acceleration channel extending up river from the control dam will be removed from between gates 3 and 4 and moved further outwards from shore between gates 4 and 5.

The Grout Gallery is an underground tunnel that will be blasted through the bedrock underneath the Water Control Dam Structure at Gate #1 extending approximately 400 meters (1,312 feet) downriver ending near Dufferin Islands. The tunnel will have a downward slope to end at a maximum depth of approximately 45 meters (147.6 feet). This tunnel will have a diameter of 7 meters (23 feet) in height and 8 meters (26 feet) in width and 403 meters (1,322 feet) in length. The floor and walls are straight (flat) with an arched ceiling. It is at this terminus that the TBM will meet up to the Grout Gallery and end its long journey.

The Grout Tunnel

The Intake Grout Tunnel is the entrance portal for water flowing into the new Niagara Tunnel after its completion. As the Tunnel Boring Machine (TBM) concludes boring the tunnel it will ascend to the surface along the Grout Tunnel. In a sense, the Grout Tunnel acts as the glide path for the emerging Tunnel Boring Machine (TBM). The diagram on the left gives the realistic perspective of the size of the Grout Tunnel in comparison to the TBM.

The most important aspect of the Grout Tunnel was to allow a 360° high pressure grout injection into all the rock cracks and crevices to form a 26 meter diameter waterproof curtain to protect the tunnel from flooding from the river above as the TBM surfaces.

Grout Tunnel Drill & Blast Method

The Grout Tunnel was built using the drill and blast method. Four large 3 meter deep expansion holes were drilled near the lower middle of the rock face. The remainder of the rock face had 3 meter deep blast holes drilled approximately every 80 centimeters apart.

The holes with the exception of the expansion holes were packed with explosives and detonated in a diamond pattern so that the blast would expand toward the expansion holes resulting in a controlled explosion. Every blast would expand the tunnel another 3 meters. The blasting was restricted to day time hours only as not to disturb nearby neighbourhoods.

September 2007 -

A large area 61 meters (200 feet) by 122 meters (400 feet) upriver surrounding gate #1 has been enclosed by a cofferdam consisting of concrete, pile driven sheet of steel, grout and rock. The area has been dewatered and is being prepared for rock blasting. The blasting will enable the construction of a 45 meter (147 feet) deep  shaft and shaping of the intake approach to be created in the bedrock. The tunnel boring machine (TBM) will intersect this shaft and end at this location .

An intake structure will be created to allow water to access the new tunnel at a flow rate of approximately 4-7 feet per second (slow enough to prevent a surface vortex) and allow the flow of surface water through the renewed functioning of gate #1.

January 2008 -

At the intake area, blasting and excavating of the entrance channel is well underway. To date, the access channel is approximately 122 meters (144 feet) long and approximately 18 meters (60 feet) wide. It is located in the dewatered area located upriver of the Water Control Dam Gate #1.

This channel has been blasted and carved into the river bedrock consisting primarily of dolostone and limestone. Holes are drilled into the bedrock and then packed with explosives. The area to be detonated is covered with thick and heavy blast mats. After ensuring all workers and others are at a safe distance, the explosives are detonated. The rock debris is then removed by being loaded onto large trucks and taken a short distance where it is dumped. The rock is then placed into an onsite rock crusher which reduces the debris into highway grade stone. At night the crushed stone is trucked from the construction site to the Queen Elizabeth Highway expansion project currently underway between the cities of St. Catharines and Niagara Falls.

On average, there have been two explosive detonations daily followed by a lengthy clearing period. The explosions occur only between the hours of 8 a.m. and 6 p.m. during weekdays with few exceptions. Each explosion is strictly controlled to ensure there is no collateral damage to the existing Water Control Dam Structure and to any nearby residences. There are three seismic devices strategically located surrounding the blast area to record the strength of each blast to ensure each is within the acceptable limits set by project engineers.

The depth of this access channel is approximately 30 meters (100 feet) deep and has reached the location of the dam structure. At this location, the access channel is below the level of the dam structure. Work is now being done on the third blasting bench. The entrance hole that is known as the "grout gallery" will not be commenced until later this year.

October 20th 2008 -

The construction of the Grout Gallery Tunnel is well underway. It is approximately 47 metres (154 feet) long. Construction of this tunnel is being done so by an old and proven method: with the use of controlled explosives. Following an explosion that tears away a portion of the tunnel face, the debris is removed and the tunnel prepared for the next blast. The rock debris is being crushed on site and is being trucked from the site to other road building construction sites in Niagara. The rock face of the tunnel is prepared by drilling a series of holes

December 10th 2008 -

The intake Grout Gallery Tunnel is 120 meters (394 feet) in length.

January 25th 2009 -

The intake Grout Gallery Tunnel is 146 meters (479 feet) in length.

February 25th 2009 -

The intake Grout Gallery Tunnel is 197.3 meters (647.3 feet) in length.

March 23rd 2009 -

The intake Grout Gallery Tunnel is 245 meters (804 feet) in length.

April 11th 2009 -

The intake Grout Gallery Tunnel is 285 meters (935 feet) in length.

April 17th 2009 -

The intake Grout Gallery Tunnel is 298.3 meters (978.6 feet) in length. The Grout Tunnel will not be extended beyond this length. No further blasting is expected to take place. Strabag has determined that the Grout Tunnel is currently of sufficient length and depth to satisfy their requirements.

April 30th 2009 -

Clean up of the site continues. Dufferin Construction is preparing to continue construction on the entrance to the Grout Tunnel. This construction includes the building the water intake and a rock trap (an area where rock debris will collect before being drawn into the tunnel when water is flowing into it).

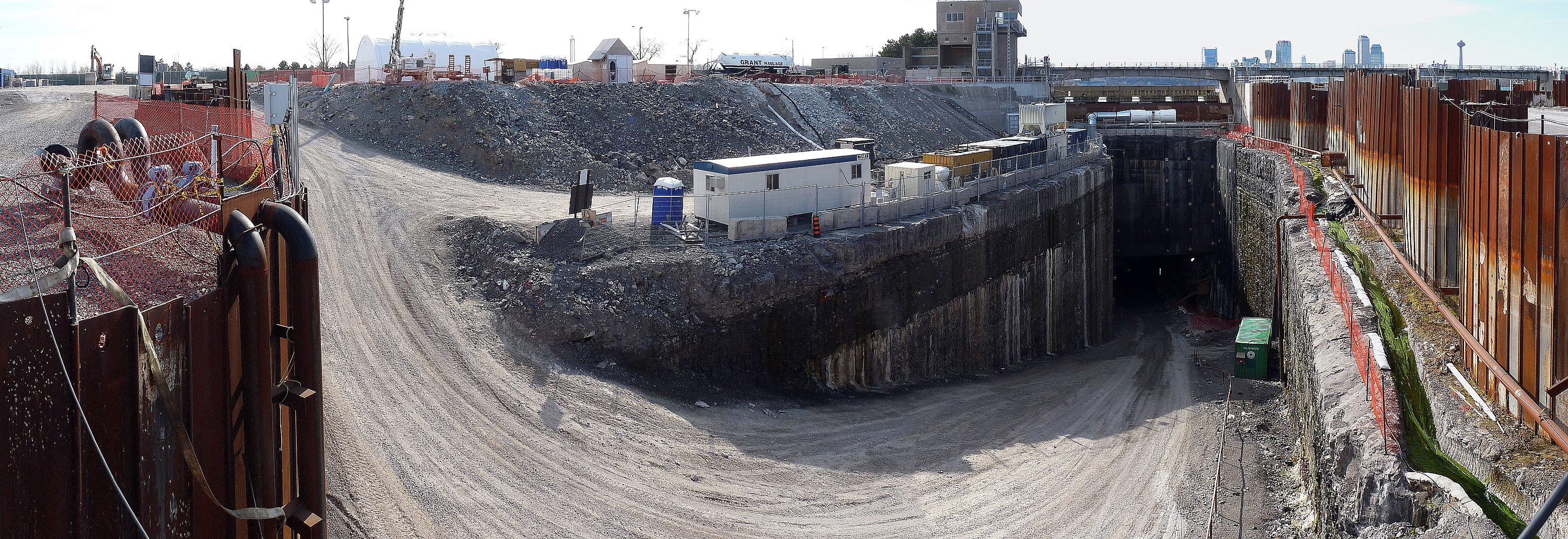

July 7th 2009 -

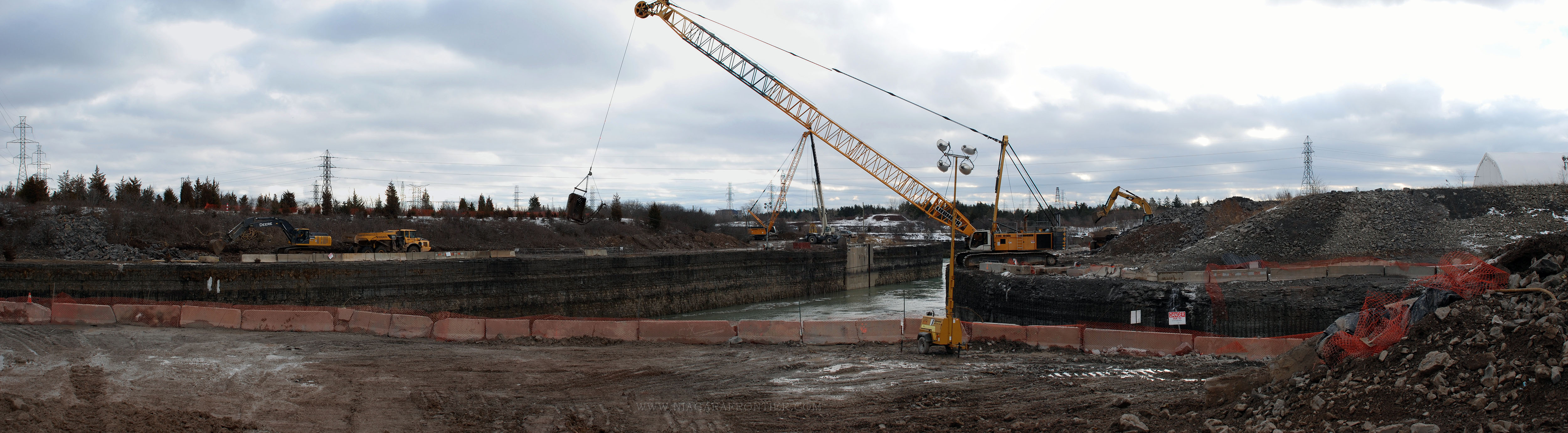

Dufferin Construction is nearing completion of the rock trap at the entrance of the grout tunnel intake (where rock debris will collect before being drawn into the tunnel when water is flowing into it). The rock pit is located just below the main entrance to the grout tunnel as been constructed from the drill and blast method followed by a mucking operation to clear the site of rock. Only one more blasting operation was required to finish this portion of the construction. Construction will soon begin on the structure of the main tunnel entrance.

Inside the grout Tunnel Intake
Inside the Grout Tunnel - January 25th 2009

Grout Tunnel Entrance - April 16th 2009

Entrance ramp to Grout Tunnel Intake

December 2009 - Spring 2010 -

The concrete work on the intake has been suspended throughout the winter months. Work will begin again when the weather becomes warmer.

Spring 2010 -

The concrete work on the intake has resumed. Work is expected to continue throughout the summer and early autumn.

TUNNEL OUTLET

The concrete tunnel outlet structure will be located will be located at the Sir Adam Beck Pump/Generating Station. The outlet canal will be 350 meters (1148.28 feet) long - 23 meters (75.46 feet) wide and 35 meters (114.83 feet) deep. This new outlet will be connected to the current feeder canal leading to the water reservoir from the hydro feeder canal. A lift type closure gate will permit the new tunnel to be closed in the event of an emergency.

August 2007 -

Cleanup of the tunnel outlet has begun. The rock walls at starting point of the tunnel boring machine near the tunnel entrance will be scaled and a bell shaped outlet containing a hydraulic steel closure gate will be constructed. The gate will allow the flow of the water to be stopped in the event of an emergency.

December 2008 -

The Invert Concrete Formwork Bridge has been walked into position. The first two bays have been lined with the waterproofing membrane and the first concrete pour is scheduled for Friday December 12th 2008. The finished inner concrete surface will be 500 - 600 millimetres thick.

January 25th 2009 -

Work is in progressing in preparing the outlet for concrete pouring in order to transition the round shaped tunnel into the rectangular outlet shape.

 NIAGARA FALLS THUNDER ALLEY NAVIGATOR

INFORMATION INDEX

HISTORICAL ARCHIVE

PICTURES & SLIDESHOWS

SITE MAP

THANK YOU FOR VISITING THE

ONTARIO POWER GENERATION
&
STRABAG INC.

NIAGARA TUNNEL PROJECT
Chronology of Events

2005-2013

PAGE

RETURN TO THUNDER ALLEY
